Guidelines for Acceptable Estimates in Online Applications

Slide Note
Embed
Share

Examples of acceptable and non-acceptable estimates in online applications for infrastructure projects. Criteria include clear itemization, exclusion of unnecessary fees, proper documentation of road names, and accurate unit measurements to avoid common errors. These guidelines help ensure accuracy and transparency in cost estimates.


Uploaded on Sep 18, 2024 | 0 Views


Download Presentation

Please find below an Image/Link to download the presentation.

The content on the website is provided AS IS for your information and personal use only. It may not be sold, licensed, or shared on other websites without obtaining consent from the author. Download presentation by click this link. If you encounter any issues during the download, it is possible that the publisher has removed the file from their server.

E N D

Presentation Transcript

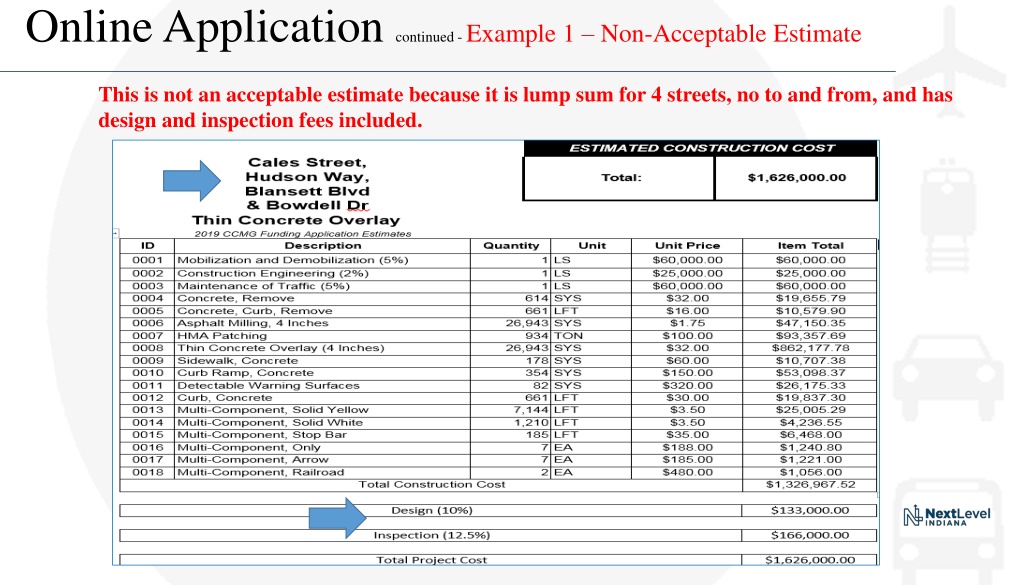

  1. Online Application continued -Example 1 Non-Acceptable Estimate This is not an acceptable estimate because it is lump sum for 4 streets, no to and from, and has design and inspection fees included.

  2. Online Application continued - Example 1 Acceptable Estimate *

  3. Online Application continued -Example 2 Non-Acceptable Estimate This is not an acceptable estimate because contingencies were included and no road name (including the to and from) was listed.

  4. Online Application continued -Example 2 Acceptable Estimate *

  5. Online Application continued -Example 3 Acceptable Estimate *

  6. Online Application continued -Example 4 Acceptable Estimate *Ensure striping is bid as the unit LFT, not LS. We see this error in estimates and bids often.

  7. Online Application continued -Example 5 Acceptable Estimate Force Account *
