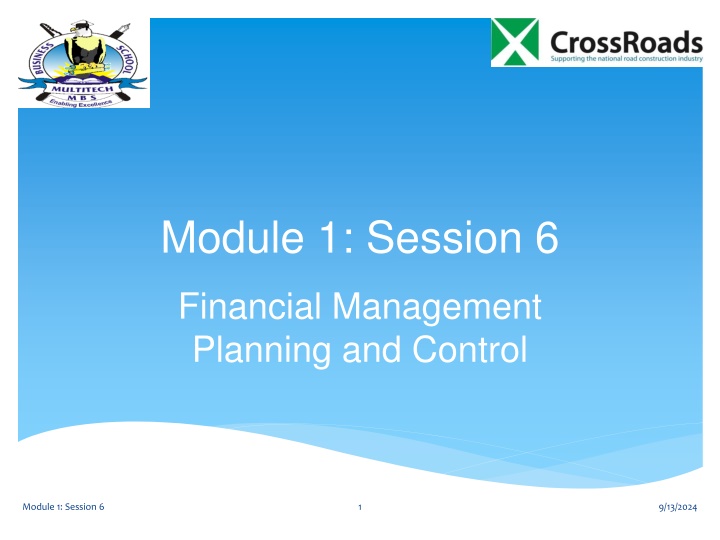

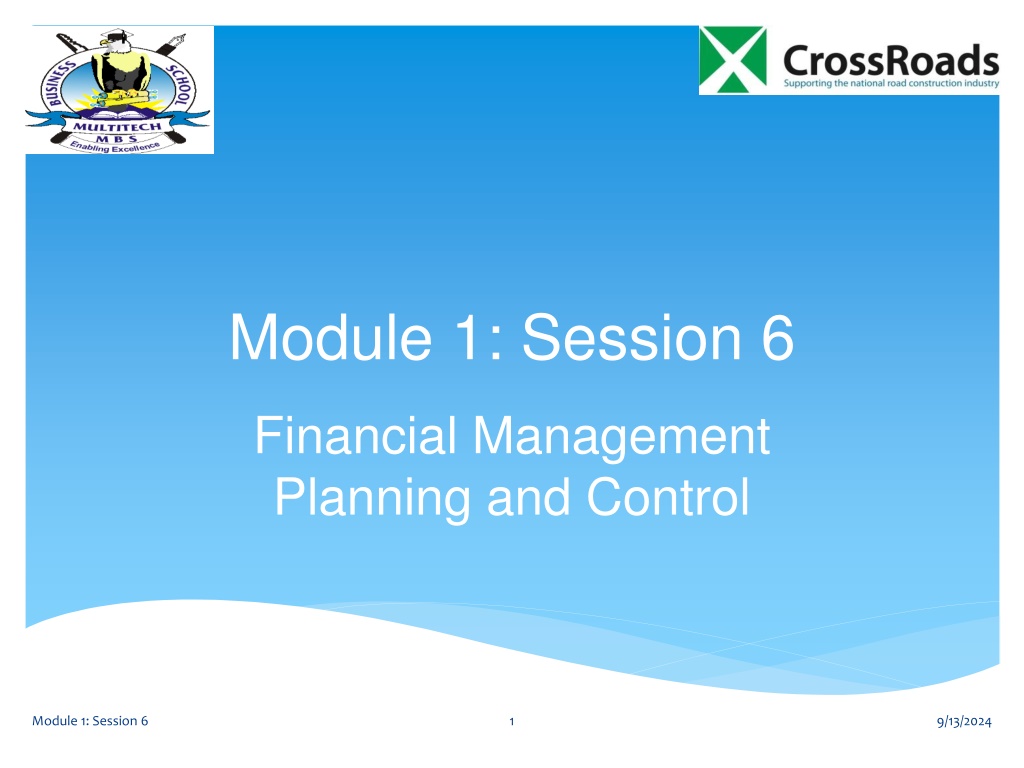

Budgetary Planning and Control in Financial Management

undefined
Module 1: Session 6
Financial Management
Planning and Control
9/13/2024
Module 1: Session 6
1
Introduce the concept of budgetary planning and
control
Influence attitudes from incremental to zero or activity
based budgeting.
Demonstrate the basic application of variances and
variance analysis e.g. Total, usage, efficiency and
price variances.
Introduce the value for money concept
Indicate the common taxes that affect financial
planning of contractors.
9/13/2024
Module 1: Session 6
2
Purpose of the Session
A budget is a management tool to guide and
control performance.
All activities of the business should be budgeted for
and monitored.
During tendering the cost budget is a useful tool to
guide tender bidding prices.
A budget, once approved, serves as a yardstick
against which performance may be measured.
9/13/2024
Module 1: Session 6
3
What is a budget
The budgetary control process operates by
comparing actual to planned performance and
D
e
t
e
r
m
i
n
i
n
g

t
h
e

v
a
r
i
a
n
c
e
s

a
n
d

t
h
e
i
r

e
f
f
e
c
t

o
n

r
e
s
u
l
t
s
Interpreting the cause,
Identifying responsibility for them.
V
a
r
i
a
n
c
e

a
n
a
l
y
s
i
s

h
e
l
p
s

t
o

i
n
f
o
r
m

f
u
t
u
r
e

a
c
t
i
o
n
s
a
n
d

d
e
c
i
s
i
o
n
s

e
.
g
.

f
u
t
u
r
e

b
i
d
s
,

r
e
m
e
d
i
a
l

a
c
t
i
o
n
,
i
n
v
e
s
t
i
g
a
t
i
o
n

e
t
c
.
9/13/2024
Module 1: Session 6
4
Budgetary Control
Incremental Budgeting (IB) uses historical figures and
apply a margin for volume and inflationary adjustments.
Zero Based Budgeting (ZBB) builds up the cost from the
basic elements that make up the task. The cost budget
should best be built up from the quantity surveyors’
estimates.
Activity Based Budgeting (ABB) builds up the budget
based on activities that are to be performed and for each
task identify the input, output, cost and outcome.
9/13/2024
Module 1: Session 6
5
Approach to budgeting
Total variance is the difference between budgeted
and actual expenditure
(Budgeted cost less actual cost)
Material usage variance is the difference in the
quantity of materials used at the budgeted price
=(budgeted quantity less actual quantity )x the
budgeted price.
9/13/2024
Module 1: Session 6
6
Typical variances in
Road Construction
Material price variance is the difference in price of the
actual quantity used
=(budgeted price less actual price) X the actual quantity.
Labour or machine efficiency variance is the difference
in labour or machine time at the budgeted rate
=( budgeted time less actual time) X budgeted rate/price
Labour or machine rate variance
=(the budgeted rate or price less the actual rate) X the
actual hours taken.
9/13/2024
Module 1: Session 6
7
Typical variances in road construction
It is important to investigate causes and
persons responsible for variances.
Purchasers are usually responsible for price
related variances and at times usage if the
materials are not of the expected quality
Supervisors are usually responsible for
usage and efficiency variances
9/13/2024
Module 1: Session 6
8
Responsibility for variances
Machine operators could be responsible for
machine efficiency variances. However
those responsible to hire or to train machine
operators or to train staff could also be
responsible for efficiency rates.
Persons responsible for maintenance of
equipment could cause machine efficiency
variances.
9/13/2024
Module 1: Session 6
9
Responsibility for variances
1)
Is utilising resources most effectively and
efficiently in order to get desired results of
quality, cheapest and quickest.
2)
I
t

i
n
v
o
l
v
e
s

m
a
x
i
m
i
z
i
n
g

q
u
a
l
i
t
y

o
b
t
a
i
n
e
d

b
u
t
m
i
n
i
m
i
z
i
n
g

i
n
p
u
t

r
e
s
o
u
r
c
e
s

i
n
c
l
u
d
i
n
g

t
i
m
e
.
3)
Calls for stretching resources to the maximum.
4)
Requires focusing not only at output but also
the outcome compared to the resources we
expend.

In road construction vfm means having
integrity, being frugal, having speed and
delivering durability.
9/13/2024
Module 1: Session 6
10
Value for Money Concept (VfM)
Works should be conceived, planned, executed
and evaluated  for VFM, including quality and
time.
Assess the output, the outcome and the
resources to be consumed for VFM.
Ensure the desired output occur.
Ensure the expected outcome is realized.
Ensure the processes are cost effective.
Keep asking what could be done better if any.
Ask what else can now be done to
ensure/improve the outcome.
9/13/2024
Module 1: Session 6
11
Value for money consciousness
T
r
a
d
e

l
i
c
e
n
s
e
Value Added Tax
Income/corporation tax
R
a
t
e
s
Withholding tax
PAYE
N
S
S
F

(
e
m
p
l
o
y
e
r

c
o
n
t
r
i
b
u
t
i
o
n
)
D
i
s
t
r
i
c
t

i
n
c
o
m
e

l
e
v
y
Local services tax
9/13/2024
Module 1: Session 6
12
Common taxes and statutory obligations that
affect costs
1. With ref. to case study data, suggest a simple budget
for Munaku to rehabilitate 2km with 2
nd
 grade gravel.
2. Outline the weakness of the  pricing method of Munaku
and analyse why Munaku did not realize his anticipated
profit.
3. Using the availed budget work out the usage, price and
efficiency variances and explain possible causes.
4. Explain what you understand by value for money and
why a road contractor should aspire to deliver value
worthy.
5. Identify possible taxes levied on a tax contractor and
show how they relate to contract costing.
All agree on actionable points.
9/13/2024
Module 1: Session 6
13
Group assignment
undefined
END
Q&A
9/13/2024
Module 1: Session 6
14
2kms incremental budget
9/13/2024
Module 1: Session 6
15
2kms Zero Based Budget
9/13/2024
Module 1: Session 6
16
Variances  and persons responsible
9/13/2024
Module 1: Session 6
17
Slide Note
Embed
Share

Exploring the concept of budgetary planning and control, this module covers different budgeting approaches such as Incremental Budgeting, Zero-Based Budgeting, and Activity-Based Budgeting. It discusses the purpose of budgets, budgetary control processes, typical variances in road construction, and the value for money concept. The session also touches upon taxes affecting financial planning for contractors and the application of variances and variance analysis in budget management.

  • Budgetary planning
  • Financial management
  • Budget control
  • Variance analysis
  • Contract taxes

Uploaded on Sep 13, 2024 | 0 Views

Download Presentation

Please find below an Image/Link to download the presentation.

The content on the website is provided AS IS for your information and personal use only. It may not be sold, licensed, or shared on other websites without obtaining consent from the author. Download presentation by click this link. If you encounter any issues during the download, it is possible that the publisher has removed the file from their server.

E N D

Presentation Transcript

  1. Module 1: Session 6 Financial Management Planning and Control Module 1: Session 6 1 9/13/2024

  2. Purpose of the Session Introduce the concept of budgetary planning and control Influence attitudes from incremental to zero or activity based budgeting. Demonstrate the basic application of variances and variance analysis e.g. Total, usage, efficiency and price variances. Introduce the value for money concept Indicate the common taxes that affect financial planning of contractors. Module 1: Session 6 2 9/13/2024

  3. What is a budget A budget is a management tool to guide and control performance. All activities of the business should be budgeted for and monitored. During tendering the cost budget is a useful tool to guide tender bidding prices. A budget, once approved, serves as a yardstick against which performance may be measured. Module 1: Session 6 3 9/13/2024

  4. Budgetary Control The budgetary control process operates by comparing actual to planned performance and Determining the variances and their effect on results Interpreting the cause, Identifying responsibility for them. Variance analysis helps to inform future actions and decisions e.g. future bids, remedial action, investigation etc. Module 1: Session 6 4 9/13/2024

  5. Approach to budgeting Incremental Budgeting (IB) uses historical figures and apply a margin for volume and inflationary adjustments. Zero Based Budgeting (ZBB) builds up the cost from the basic elements that make up the task. The cost budget should best be built up from the quantity surveyors estimates. Activity Based Budgeting (ABB) builds up the budget based on activities that are to be performed and for each task identify the input, output, cost and outcome. Module 1: Session 6 5 9/13/2024

  6. Typical variances in Road Construction Total variance is the difference between budgeted and actual expenditure (Budgeted cost less actual cost) Material usage variance is the difference in the quantity of materials used at the budgeted price =(budgeted quantity less actual quantity )x the budgeted price. Module 1: Session 6 6 9/13/2024

  7. Typical variances in road construction Material price variance is the difference in price of the actual quantity used =(budgeted price less actual price) X the actual quantity. Labour or machine efficiency variance is the difference in labour or machine time at the budgeted rate =( budgeted time less actual time) X budgeted rate/price Labour or machine rate variance =(the budgeted rate or price less the actual rate) X the actual hours taken. Module 1: Session 6 7 9/13/2024

  8. Responsibility for variances It is important to investigate causes and persons responsible for variances. Purchasers are usually responsible for price related variances and at times usage if the materials are not of the expected quality Supervisors are usually responsible for usage and efficiency variances Module 1: Session 6 8 9/13/2024

  9. Responsibility for variances Machine operators could be responsible for machine efficiency variances. However those responsible to hire or to train machine operators or to train staff could also be responsible for efficiency rates. Persons responsible for maintenance of equipment could cause machine efficiency variances. Module 1: Session 6 9 9/13/2024

  10. Value for Money Concept (VfM) 1) Is utilising resources most effectively and efficiently in order to get desired results of quality, cheapest and quickest. 2) It involves maximizing quality obtained but minimizing input resources including time. 3) Calls for stretching resources to the maximum. 4) Requires focusing not only at output but also the outcome compared to the resources we expend. In road construction vfm means having integrity, being frugal, having speed and delivering durability. Module 1: Session 6 10 9/13/2024

  11. Value for money consciousness Works should be conceived, planned, executed and evaluated for VFM, including quality and time. Assess the output, the outcome and the resources to be consumed for VFM. Ensure the desired output occur. Ensure the expected outcome is realized. Ensure the processes are cost effective. Keep asking what could be done better if any. Ask what else can now be done to ensure/improve the outcome. Module 1: Session 6 11 9/13/2024

  12. Common taxes and statutory obligations that affect costs Trade license Value Added Tax Income/corporation tax Rates Withholding tax PAYE NSSF (employer contribution) District income levy Local services tax Module 1: Session 6 12 9/13/2024

  13. Group assignment 1. With ref. to case study data, suggest a simple budget for Munaku to rehabilitate 2km with 2nd grade gravel. 2. Outline the weakness of the pricing method of Munaku and analyse why Munaku did not realize his anticipated profit. 3. Using the availed budget work out the usage, price and efficiency variances and explain possible causes. 4. Explain what you understand by value for money and why a road contractor should aspire to deliver value worthy. 5. Identify possible taxes levied on a tax contractor and show how they relate to contract costing. All agree on actionable points. Module 1: Session 6 13 9/13/2024

  14. END Q&A Module 1: Session 6 14 9/13/2024

  15. 2kms incremental budget Munaku's Incremental bid Historical cost 210,000,000 Economic mark up 30% 63,000,000 Expected cost 273,000,000 Margin 30% 81,900,000 Price 354,900,000 Rounded up 355,000,000 Module 1: Session 6 15 9/13/2024

  16. 2kms Zero Based Budget Ideal Zero Based Budget bid Item cost per unit Quantity Cost Materials: Gravel in tonnes 5,000 20,000 100,000,000 Machine hire in hours 400 200,000 80,000,000 Fuel for machines in lts 40,000 3,000 120,000,000 Direct labour (man days) 900 10,000 9,000,000 Supervision (man months) 4 500,000 2,000,000 Total cost 311,000,000 Margin 30% 93,300,000 Bid price 404,300,000 Costs underestimated by 14% and bid price understated by 12% Module 1: Session 6 16 9/13/2024

  17. Variances and persons responsible Usage Price Efficiency Total Gravel Machine Fuel Labour Total cost variance (100,000,000) 20,000,000 (80,000,000) 16,000,000 300,000 (13,500,000) (77,200,000) - 16,000,000 24,000,000 (6,000,000) 10,000,000 (18,000,000) (5,700,000) (7,500,000) 6,800,000 (118,000,000) Budgeted profit Actual profit 93,300,000 16,100,000 Responsibility for variance Variance due to machine operator Variancence due to Purchaser 40,000,000 6,800,000 Variance due to supervisors Total profit variance (124,000,000) (77,200,000) Module 1: Session 6 17 9/13/2024
