Monitoring Options and Costs for Comprehensive Plan

future monitoring in support of the comprehensive l.w
1 / 10
Embed
Share

Explore monitoring options and associated costs to meet the Comprehensive Plan requirements, focusing on PCB loads and river concentrations. Various monitoring options are provided with costs ranging from $18,000 to $225,000 per year. The plan includes assessing trends in PCB loads and concentrations over a specific evaluation period.

  • Monitoring
  • Comprehensive Plan
  • PCB Loads
  • River Concentrations
  • Cost Analysis

Uploaded on | 0 Views


Download Presentation

Please find below an Image/Link to download the presentation.

The content on the website is provided AS IS for your information and personal use only. It may not be sold, licensed, or shared on other websites without obtaining consent from the author. If you encounter any issues during the download, it is possible that the publisher has removed the file from their server.

You are allowed to download the files provided on this website for personal or commercial use, subject to the condition that they are used lawfully. All files are the property of their respective owners.

The content on the website is provided AS IS for your information and personal use only. It may not be sold, licensed, or shared on other websites without obtaining consent from the author.

E N D

Presentation Transcript


  1. Future Monitoring in Support of the Comprehensive Plan: Costs for Various Options SRRTTF TTWG Meeting Dave Dilks July 12, 2017

  2. Summary Comprehensive Plan states that monitoring will be conducted to assess trends in PCB loads and concentrations Range of monitoring options are provided Costs range from $18,000 to $225,000/year depending on objectives It is going to take a long time to demonstrate a decreasing trend in river concentrations

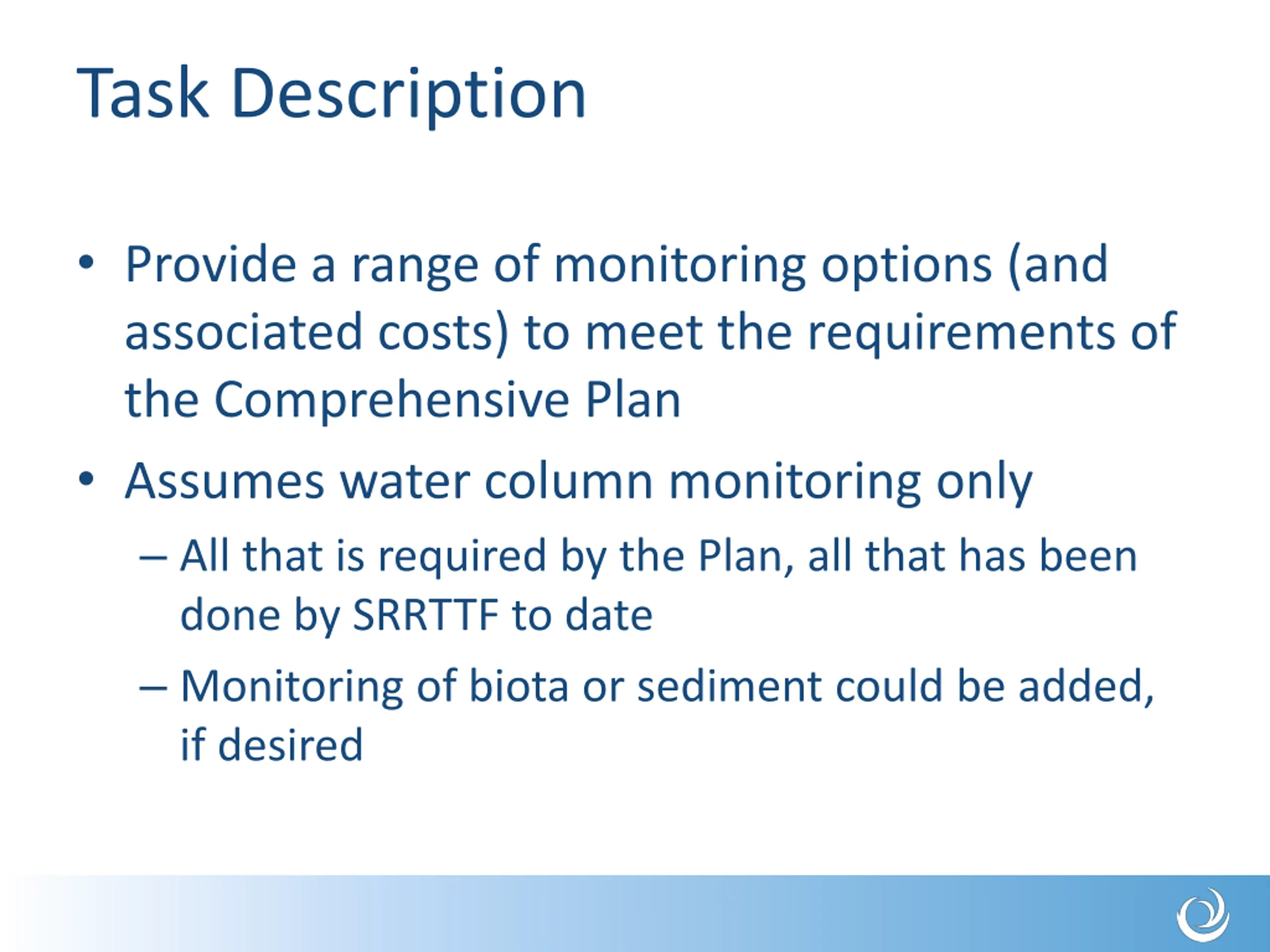

  3. Task Description Provide a range of monitoring options (and associated costs) to meet the requirements of the Comprehensive Plan Assumes water column monitoring only All that is required by the Plan, all that has been done by SRRTTF to date Monitoring of biota or sediment could be added, if desired

  4. Comprehensive Plan Requirements The Task Force will, within five years, assess: PCB loads to the river, and changes in loading over the evaluation period These data needs are addressed by existing programs Spokane River PCB concentrations, and changes in concentration over the evaluation period In-river concentrations will be assessed via review of data to be collected by the Task Force and/or Ecology Statistical tests will be applied to determine if significant reductions have occurred

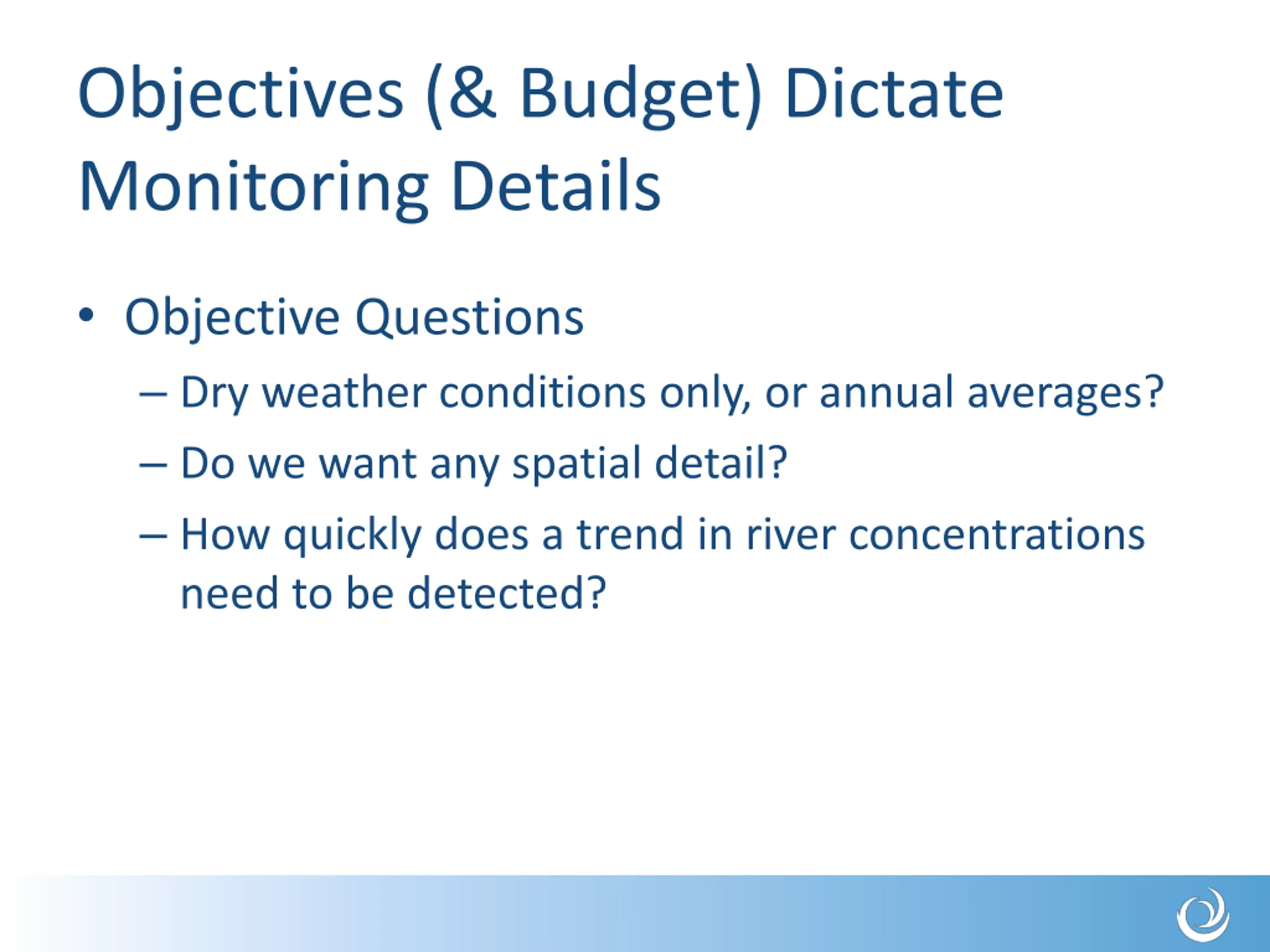

  5. Objectives (& Budget) Dictate Monitoring Details Objective Questions Dry weather conditions only, or annual averages? Do we want any spatial detail? How quickly does a trend in river concentrations need to be detected?

  6. Objectives: Dry Weather vs. Annual Simplest temporal approach is to focus on summer low flow conditions Concentrations will generally be higher (and easier to measure accurately) and more stable But Sampling only in summer won t detect changes due to wet weather/snowmelt loading reductions

  7. Objectives: Spatial Detail Single downstream station should be sufficient for overall temporal trend detection purposes Multiple stations provide some indication of where load reductions are occurring Nine Mile Dam most likely candidate Encompasses large majority of urban sources USGS Spokane Gage is a secondary candidate

  8. Objectives: Trend Detection How long does is take to demonstrate a trend with statistical certainty? With monthly monitoring: If concentrations decrease at 1% per year 25 to 34 years of monitoring required to verify trend If concentrations decrease at 5% per year 8 to 11 years of monitoring required to verify trend Even longer as monitoring frequency decreases Will likely need to rely on observed loads to determine if significant reductions have occurred

  9. Cost Estimates for Various Options Number of Stations Number of Events per Year Cost per Year 1 1 $18,000 $45,000 1 3 $160,000 1 12 $25,000 3 1 $60,000 3 3 $225,000 3 12

  10. Summary Comprehensive Plan states that monitoring will be conducted to assess trends in PCB loads and concentrations Range of monitoring options are provided Costs range from $18,000 to $225,000/year depending on objectives It is going to take a long time to demonstrate a decreasing trend in river concentrations
