Modular Field Cage Installation Sequence Overview



I
n
s
t
a
l
l
a
t
i
o
n

s
e
q
u
e
n
c
e

#
1
1

23-Feb-2016

Jack Fowler (modified by Dan Wenman | SP PD Installation discussion

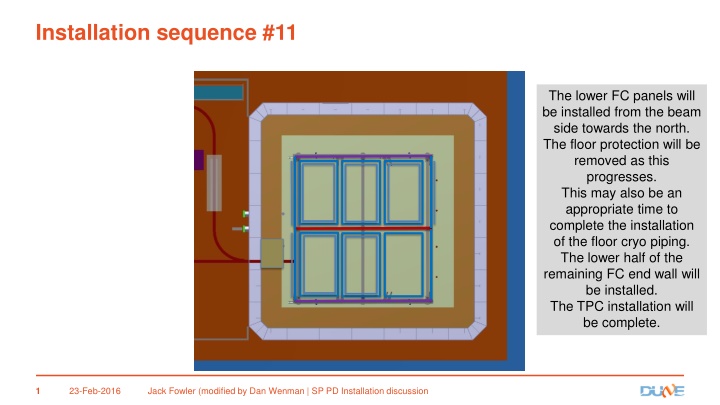

1
The lower FC panels will
be installed from the beam
side towards the north.
The floor protection will be
removed as this
progresses.
This may also be an
appropriate time to
complete the installation
of the floor cryo piping.
The lower half of the
remaining FC end wall will
be installed.
The TPC installation will
be complete.

2 March-2016

Dan Wenman     FC Installation

2

FC Modular
preliminary

concept
 for manual installation

GP standoffs
preassembled to
the beam

Modular FC
profile assembly

Module connection
shown with a
standoff that fits
between profiles. 2-
4 per module/per
beam?

Requires some
kind of captive nut
on the top side of
the GP

2 March-2016

Dan Wenman      FC Installation

3

Modular top field cage installation

Beams with standoffs are
installed
GP is threaded through beams
and secured with fasteners
from the inside
Modular FC assemblies are
mounted to the bottom of the
beams
Electrical connections are
made

2 March  2016

Dan Wenman     FC  Installation

4

Modular top field cage installation (cont.)

GP

Captive nuts on the
ground plane would
allow securing with
fasteners from the
FC side

2 March 2016

Dan Wenman     FC Installation

5

Bottom Modular FC
installation

1.
Support beam with
standoffs are installed
2.
Working from APA to
CPA the first GP
planes are translated
into position and
mounted. (Rotated
parallel to the floor
into position for the
last FC.)
3.
The first
profile/racetrack
module is positioned
and mounted.
4.
Electrical connections
are made
5.
Steps ¼ are repeated
until complete.


2 March-2016

Dan Wenman  FC Installation

6

It may be nice for electrical connections to be biased to one side for last minute access
Access for installing the last modular panels will be a challenge
Make it a requirement for the CPA and FC to be safe to support a person on a plank
near the CPA?
Blocking underneath, in line with the standoffs, to provide support for the FC
beams?  Need to look at real situation with piping and corrugations.

Plank

blocking

blocking

Comments

Possible option for installing FC

Low profile light duty crane with 2 lift
points.
Crane runs on installation beams.
Crane is could be designed to be fully
or partially disassembled with access
from the downstream side of the TPC.

winch

pulley

2 March 2016

Dan Wenman     FC Installation

8

Genie superlift
Other vendors: Vermette
Machining, Sumner


    SLC™-24
    Lifting Height:
    24 ft (7.32 m)
    Width - stowed:
    2 ft .75 in (0.63 m)
    Load Capacity:
    650 lbs (295 kg)


AWP™-36S
Working Height*:
42 ft 5 in (13.10 m)
Lift Capacity :
350 lbs (159 kg)
Platform Height:
36 ft 5 in (11.10 m)

Options for lifting the FC panels
For ProtoDUNE and probably DUNE the lifting equipment will have to be removed
before the TCO is closed.  The last FC’s would then be assembled in place.  For
protoDUNE probably makes sense to assemble all the FC in place.

23-Feb-2016

Jack Fowler | SP PD Installation discussion

9

Back up slides


I
n
s
t
a
l
l
a
t
i
o
n

s
e
q
u
e
n
c
e

#
4

23-Feb-2016

Jack Fowler | SP PD Installation discussion

10
10
The beam side end wall
FC will be installed.


I
n
s
t
a
l
l
a
t
i
o
n

s
e
q
u
e
n
c
e

#
5

23-Feb-2016

Jack Fowler | SP PD Installation discussion

11
11
The 3 upper field cage
panels will be installed.
Note: Access to the CE
on APAs 1, 2 and 3 is
now not possible.


I
n
s
t
a
l
l
a
t
i
o
n

s
e
q
u
e
n
c
e

#
6

23-Feb-2016

Jack Fowler | SP PD Installation discussion

12
12
Completion of the Jura FC as
follows:
Install the upper half of
the north FC wall.
Disassemble scaffolding
in this drift area.
Install the lower FC
panels from beam side to
N side.  Removal of floor
protective panels will be
completed and the areas
are covered with the FC
panels.
Install the lower half of the
north FC wall from the
outside of drift volume.
HV can be installed at this
point.  Need to evaluate the
optimal time for this.


I
n
s
t
a
l
l
a
t
i
o
n

s
e
q
u
e
n
c
e

#
9

23-Feb-2016

Jack Fowler | SP PD Installation discussion

13
13
The upper half of the north
Seleve end wall FC will be
installed.
The upper two FC panels
may be installed at this
point.  This will block
access to the CE for two
of the APAs.
After this is complete, all
of the remaining FC
panels must be moved
and stored inside the
cryostat for the closing of
the TCO.  Also all of the
materials for closing the
TCO must be in the
cryostat prior before
beginning the closure.  Is
there enough storage and
work space available?


I
n
s
t
a
l
l
a
t
i
o
n

s
e
q
u
e
n
c
e

#
1
0

23-Feb-2016

Jack Fowler | SP PD Installation discussion

14
14
After the TCO is closed,
the beam side Seleve FC
will be installed.
Then the final upper FC
will be installed.
The scaffolding from the
Seleve side drift can be
removed.
After the TCO is closed,
access to the cryostat will
only be possible through
the manholes.  All
materials not in the
cryostat must fit through
the manhole.  All tooling
inside the cryostat can
only be removed through
the manhole.
