Change Management Committee Sections 2-6 Review

Change Management Committee Sections 2-6 Review
Slide Note
Embed
Share

The Change Management Committee conducted a comprehensive review of new change proposals, focusing on improving nomination processes and flow rates. The proposals aim to enhance user flexibility and streamline validation procedures, benefiting shippers, DNOs, and National Grid. The proposed changes address issues with Single Sided Nominations and Negative Implied Flow Rates, offering automated solutions and flexibility in managing gas flow processes.

  • Change Management
  • Committee Review
  • User Flexibility
  • Validation Procedures
  • Gas Flow

Uploaded on Feb 26, 2025 | 0 Views

Download Presentation

Please find below an Image/Link to download the presentation.

The content on the website is provided AS IS for your information and personal use only. It may not be sold, licensed, or shared on other websites without obtaining consent from the author.If you encounter any issues during the download, it is possible that the publisher has removed the file from their server.

You are allowed to download the files provided on this website for personal or commercial use, subject to the condition that they are used lawfully. All files are the property of their respective owners.

The content on the website is provided AS IS for your information and personal use only. It may not be sold, licensed, or shared on other websites without obtaining consent from the author.

E N D

Presentation Transcript

  1. Change Management Committee Sections 2 - 6 11thDecember 2019

  2. 2. New Change Proposals Initial Review

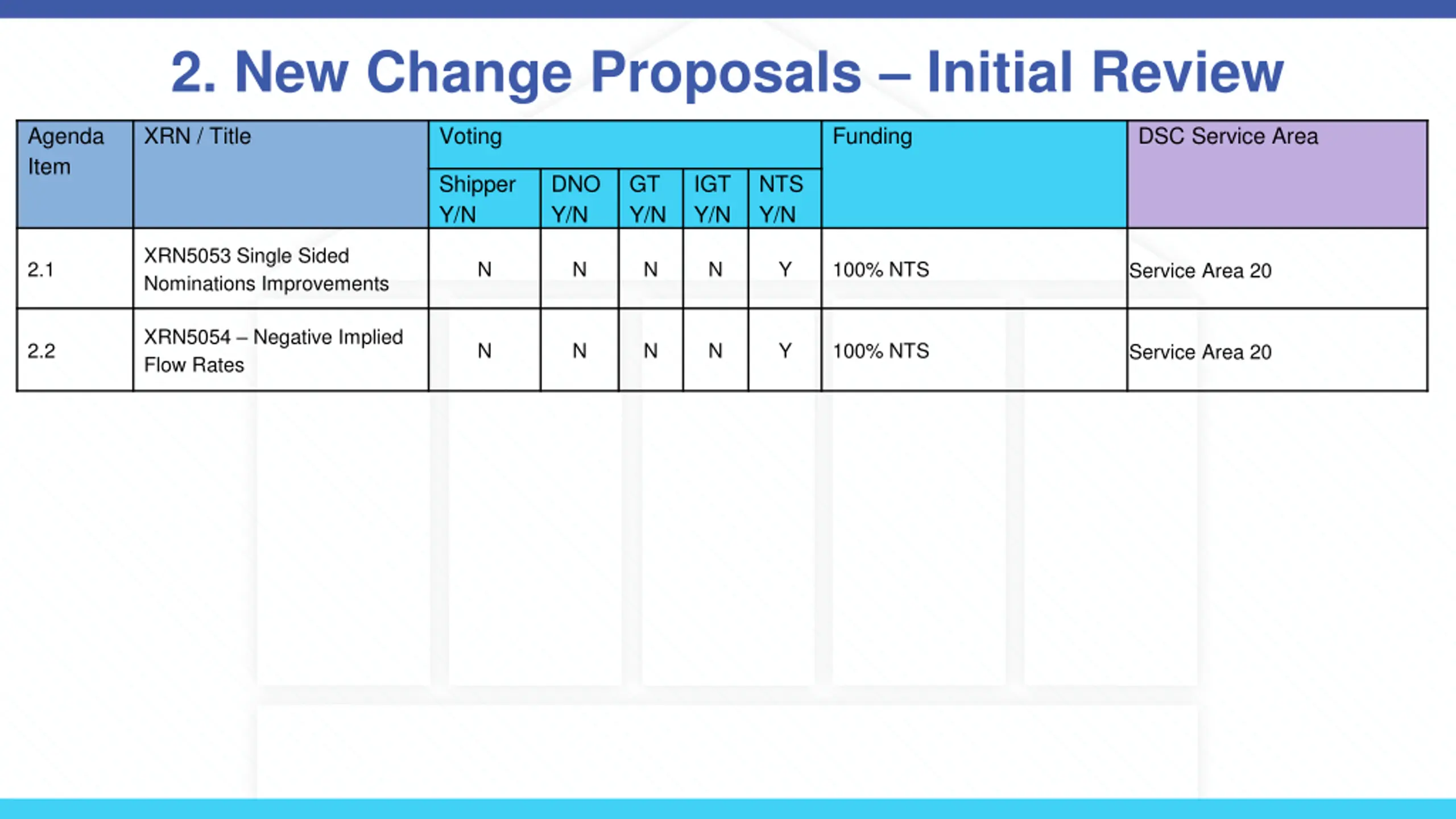

  3. 2. New Change Proposals Initial Review Agenda Item XRN / Title Voting Funding DSC Service Area Shipper Y/N DNO Y/N GT Y/N IGT Y/N NTS Y/N XRN5053 Single Sided Nominations Improvements 2.1 N N N N Y 100% NTS Service Area 20 XRN5054 Negative Implied Flow Rates 2.2 N N N N Y 100% NTS Service Area 20

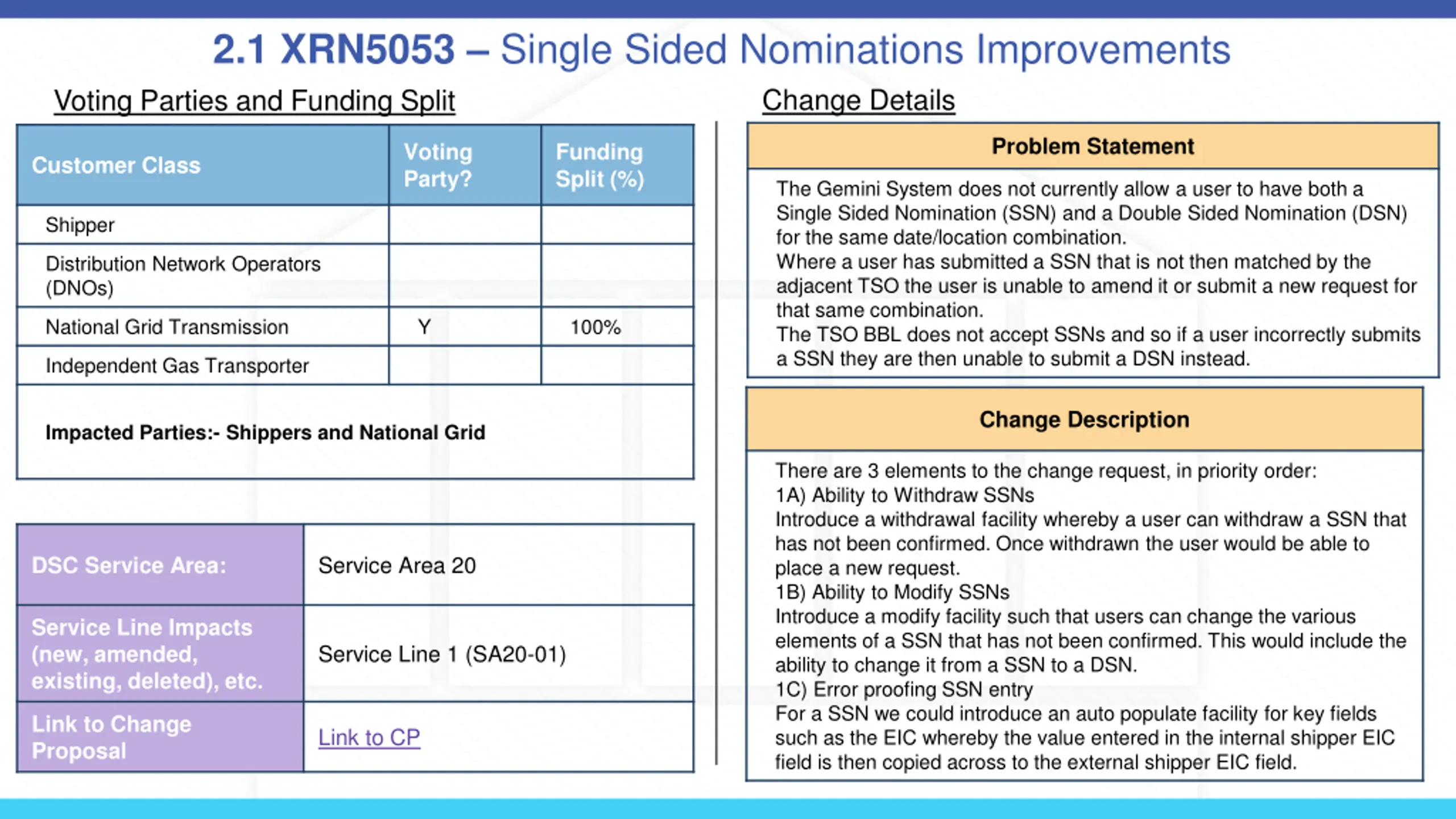

  4. 2.1 XRN5053 Single Sided Nominations Improvements Voting Parties and Funding Split Change Details Problem Statement Voting Party? Funding Split (%) Customer Class The Gemini System does not currently allow a user to have both a Single Sided Nomination (SSN) and a Double Sided Nomination (DSN) for the same date/location combination. Where a user has submitted a SSN that is not then matched by the adjacent TSO the user is unable to amend it or submit a new request for that same combination. The TSO BBL does not accept SSNs and so if a user incorrectly submits a SSN they are then unable to submit a DSN instead. Shipper Distribution Network Operators (DNOs) National Grid Transmission Y 100% Independent Gas Transporter Change Description Impacted Parties:- Shippers and National Grid There are 3 elements to the change request, in priority order: 1A) Ability to Withdraw SSNs Introduce a withdrawal facility whereby a user can withdraw a SSN that has not been confirmed. Once withdrawn the user would be able to place a new request. 1B) Ability to Modify SSNs Introduce a modify facility such that users can change the various elements of a SSN that has not been confirmed. This would include the ability to change it from a SSN to a DSN. 1C) Error proofing SSN entry For a SSN we could introduce an auto populate facility for key fields such as the EIC whereby the value entered in the internal shipper EIC field is then copied across to the external shipper EIC field. Service Area 20 DSC Service Area: Service Line Impacts (new, amended, existing, deleted), etc. Service Line 1 (SA20-01) Link to Change Proposal Link to CP

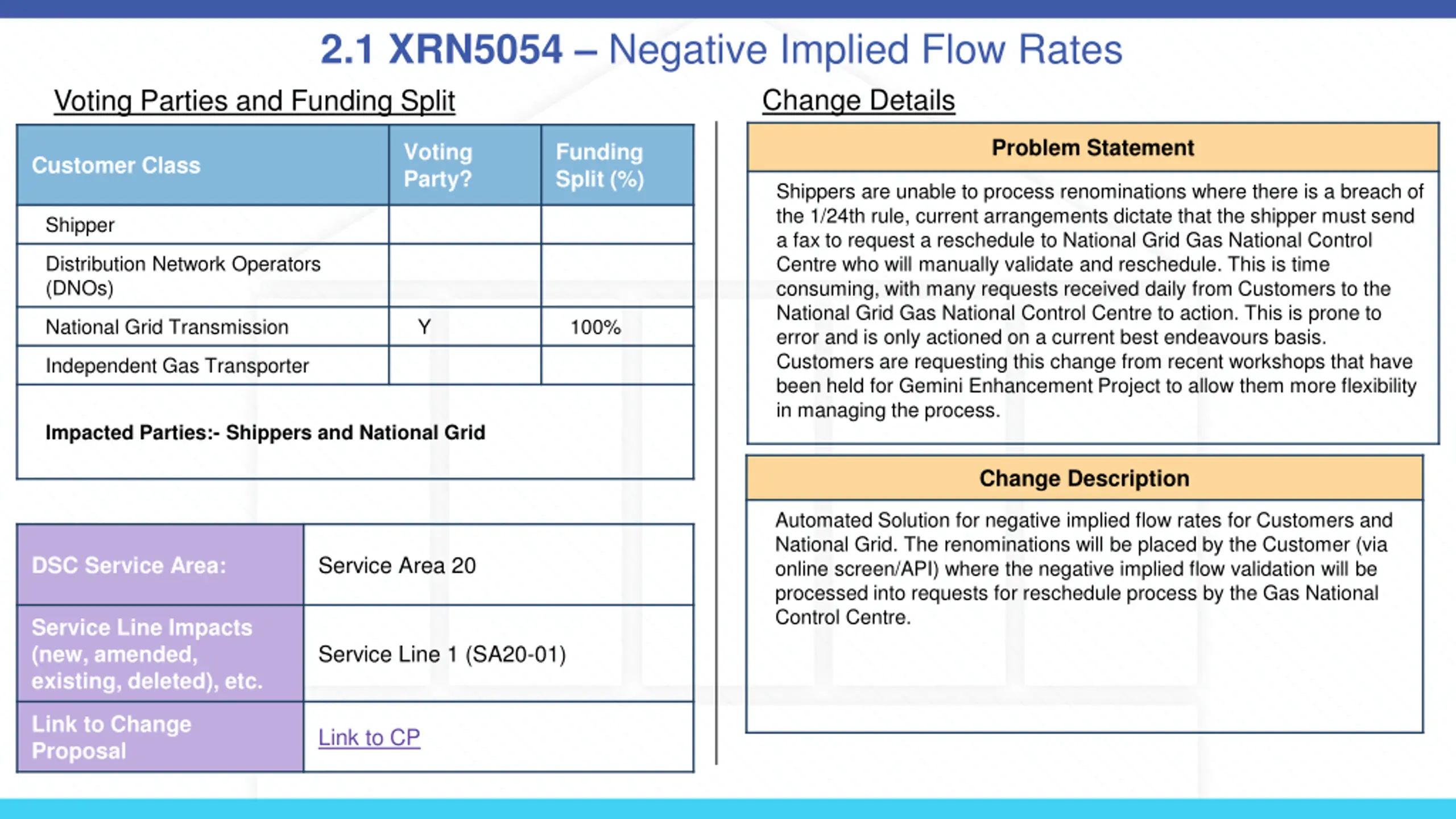

  5. 2.1 XRN5054 Negative Implied Flow Rates Voting Parties and Funding Split Change Details Problem Statement Voting Party? Funding Split (%) Customer Class Shippers are unable to process renominations where there is a breach of the 1/24th rule, current arrangements dictate that the shipper must send a fax to request a reschedule to National Grid Gas National Control Centre who will manually validate and reschedule. This is time consuming, with many requests received daily from Customers to the National Grid Gas National Control Centre to action. This is prone to error and is only actioned on a current best endeavours basis. Customers are requesting this change from recent workshops that have been held for Gemini Enhancement Project to allow them more flexibility in managing the process. Shipper Distribution Network Operators (DNOs) National Grid Transmission Y 100% Independent Gas Transporter Impacted Parties:- Shippers and National Grid Change Description Automated Solution for negative implied flow rates for Customers and National Grid. The renominations will be placed by the Customer (via online screen/API) where the negative implied flow validation will be processed into requests for reschedule process by the Gas National Control Centre. Service Area 20 DSC Service Area: Service Line Impacts (new, amended, existing, deleted), etc. Service Line 1 (SA20-01) Link to Change Proposal Link to CP

  6. 3. New Change Proposals Post Initial Review None for this meeting

  7. 4. New Change Proposals Post Solution Review

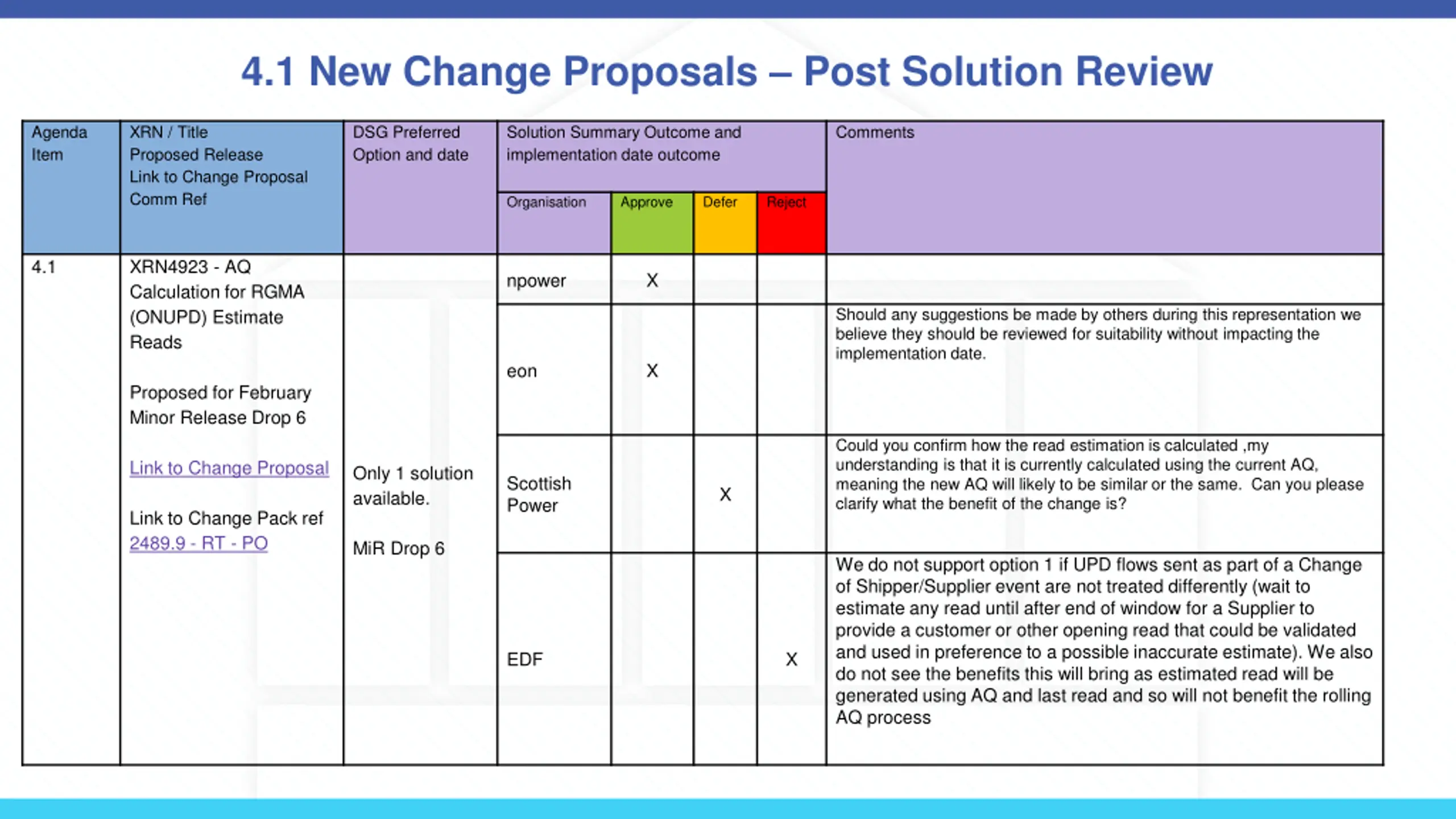

  8. 4.1 New Change Proposals Post Solution Review Agenda Item XRN / Title Proposed Release Link to Change Proposal Comm Ref DSG Preferred Option and date Solution Summary Outcome and implementation date outcome Comments Organisation Approve Defer Reject 4.1 XRN4923 - AQ Calculation for RGMA (ONUPD) Estimate Reads npower X Should any suggestions be made by others during this representation we believe they should be reviewed for suitability without impacting the implementation date. eon X Proposed for February Minor Release Drop 6 Could you confirm how the read estimation is calculated ,my understanding is that it is currently calculated using the current AQ, meaning the new AQ will likely to be similar or the same. Can you please clarify what the benefit of the change is? Link to Change Proposal Only 1 solution available. Scottish Power X Link to Change Pack ref 2489.9 - RT - PO MiR Drop 6 We do not support option 1 if UPD flows sent as part of a Change of Shipper/Supplier event are not treated differently (wait to estimate any read until after end of window for a Supplier to provide a customer or other opening read that could be validated and used in preference to a possible inaccurate estimate). We also do not see the benefits this will bring as estimated read will be generated using AQ and last read and so will not benefit the rolling AQ process EDF X

  9. 4.2 XRN4851 - Moving Market Participant Ownership from SPAA to UNC/DSC

  10. Solution Approach At the DSG session on 18th November, multiple approaches for the new Market Participant process were presented (A simple spreadsheet solution/a file flow similar to the electricity process). These approach options have also been circulated to various Industry groups. The consensus view is that a downloadable spreadsheet is the best approach This was also the recommendation from DSG Previous assumptions were that a file flow was required, similar to electricity processes, which we will continue to investigate should there be an appetite for this for those that commented they indicated that they did not want the elec flows replicated We are seeking confirmation from ChMC that this approach is supported for the Market Participant process from Feb 20.

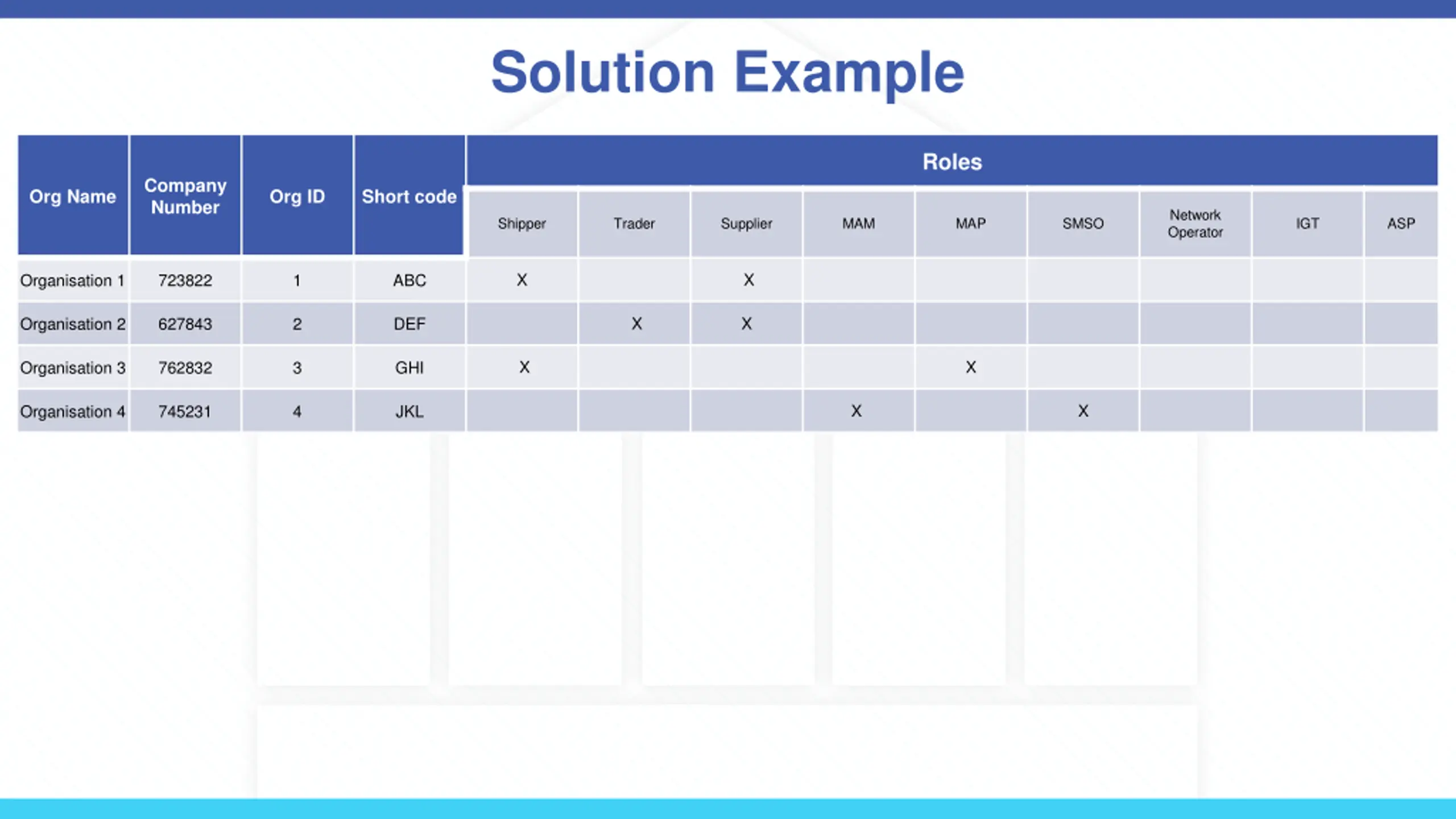

  11. Solution Example Roles Company Number Org Name Org ID Short code Network Operator Shipper Trader Supplier MAM MAP SMSO IGT ASP X X Organisation 1 723822 1 ABC X X Organisation 2 627843 2 DEF X X Organisation 3 762832 3 GHI X X Organisation 4 745231 4 JKL

  12. 5. Implementation Plan Please see the following slides for an overview of: Detail Design Changes for approval Outages. Attached is the full Implementation Plan document.

  13. XRN4941 Auto updates to meter read frequency (MOD0692) XRN4932 Improvements to the quality of the Conversion Factor values held on the Supply Point Register (MOD0681S) June 2020 XRN4930 Requirement to Inform Shipper of Meter Link Code Change June 2020 XRN4888 Removing Duplicate Address Update Validation for IGT Supply Meter Points via CMS XRN4865 Amendment to Treatment and Reporting of CYCL Reads XRN4850 Notification of Customer Contact Details to Transporters XRN4772 Composite Weather Variable (CWV) Improvements Approve Drop XRN4955 Amendment of MDD PSR Needs Codes and Needs Code Descriptions Drop MiR MiR 6 6 Reject Minor XRN4897 & 4899 Deletion of Customer Contact Details and PSR at the Change of Shipper and Supplier Events Minor XRN4871B Modification 0665 Changes to Ratchet Regime XRN4780B Inclusion of MAP Id in the UK Link system (CSS) Major Major XRN4692 CSEPs: IGT and GT File Formats (CIN Files) XRN4691 CSEPs: IGT and GT File Formats (CGI Files) XRN5033 Addition of low-level data to EUC Report AdHoc AdHoc Data Data XRN5004 Golden Bullet Report 0 1 2 3 4 5 6

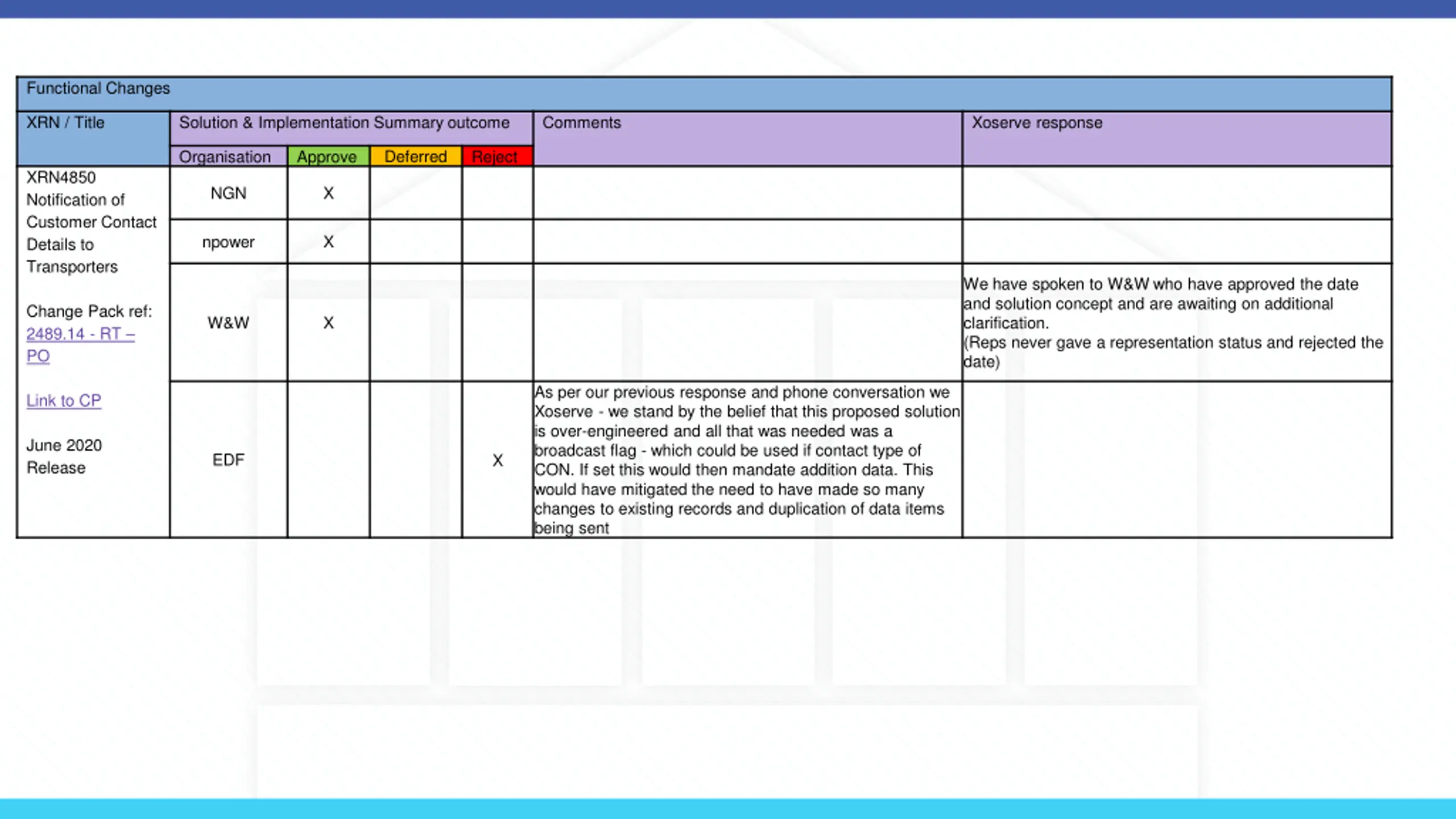

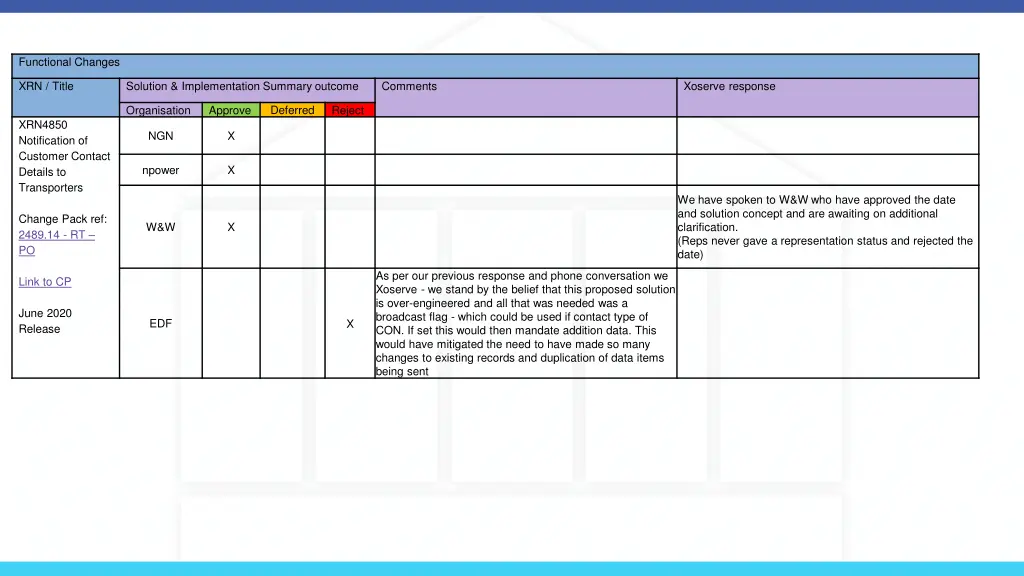

  14. Functional Changes XRN / Title Solution & Implementation Summary outcome Comments Xoserve response Deferred Organisation Approve Reject XRN4850 Notification of Customer Contact Details to Transporters NGN X npower X We have spoken to W&W who have approved the date and solution concept and are awaiting on additional clarification. (Reps never gave a representation status and rejected the date) Change Pack ref: 2489.14 - RT PO W&W X As per our previous response and phone conversation we Xoserve - we stand by the belief that this proposed solution is over-engineered and all that was needed was a broadcast flag - which could be used if contact type of CON. If set this would then mandate addition data. This would have mitigated the need to have made so many changes to existing records and duplication of data items being sent Link to CP June 2020 Release EDF X

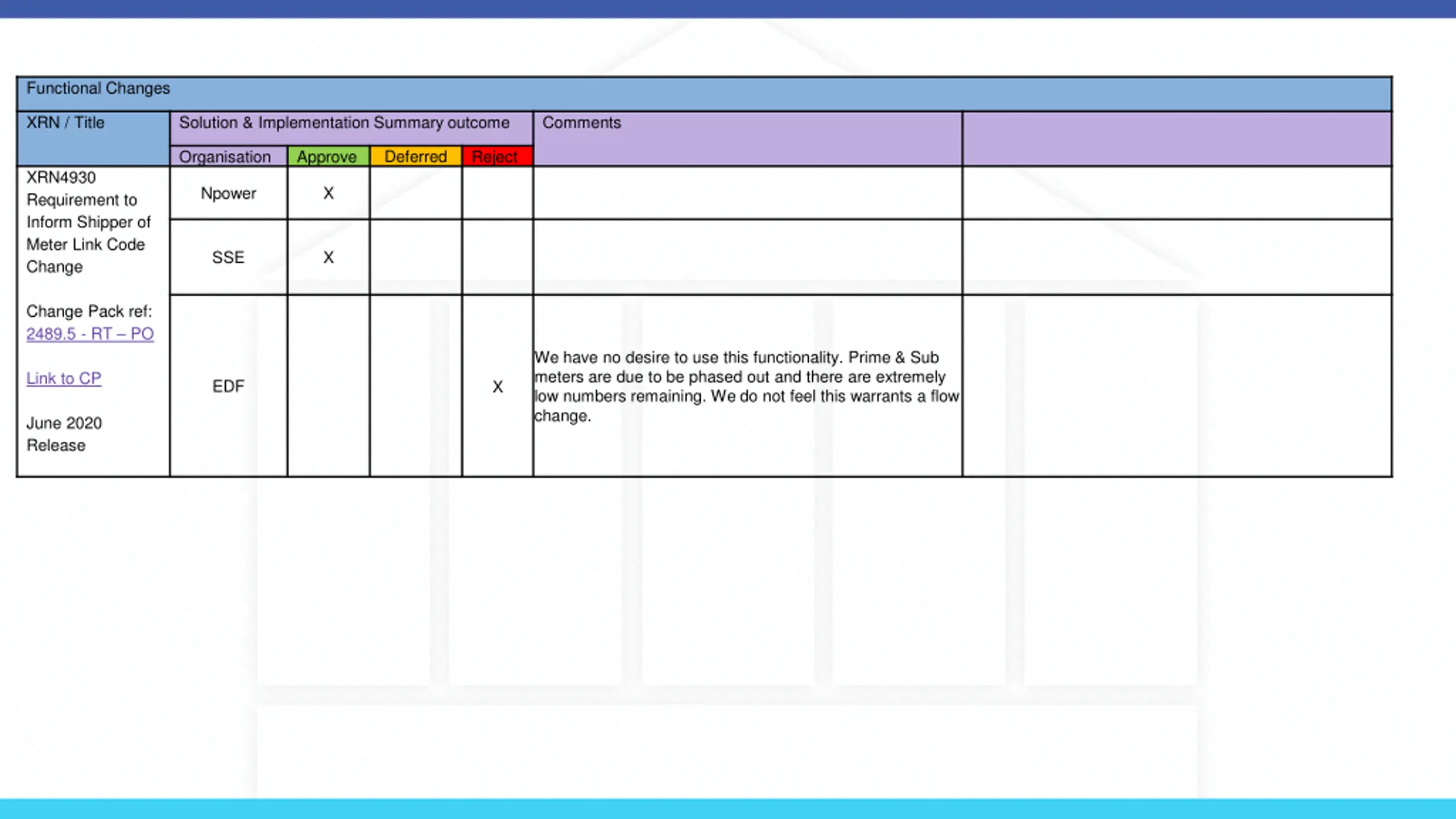

  15. Functional Changes XRN / Title Solution & Implementation Summary outcome Comments Deferred Organisation Approve Reject XRN4930 Requirement to Inform Shipper of Meter Link Code Change Npower X SSE X Change Pack ref: 2489.5 - RT PO We have no desire to use this functionality. Prime & Sub meters are due to be phased out and there are extremely low numbers remaining. We do not feel this warrants a flow change. Link to CP EDF X June 2020 Release

  16. Functional Changes XRN / Title Solution & Implementation Summary outcome Comments Deferred Organisation Approve Reject XRN4932 Improvements to the quality of the Conversion Factor values held on the Supply Point Register (MOD0681S) Npower X Eon X Orsted X Scottish Power X NGN X Change Pack ref: 2489.6 - RT PO XRN5027 really needs to be looked at and agreed before this is in place. We need to ensure data is as accurate as possible before implementing this solution as inaccurate data for this value will impact customer billing Link to CP EDF X June 2020 Release

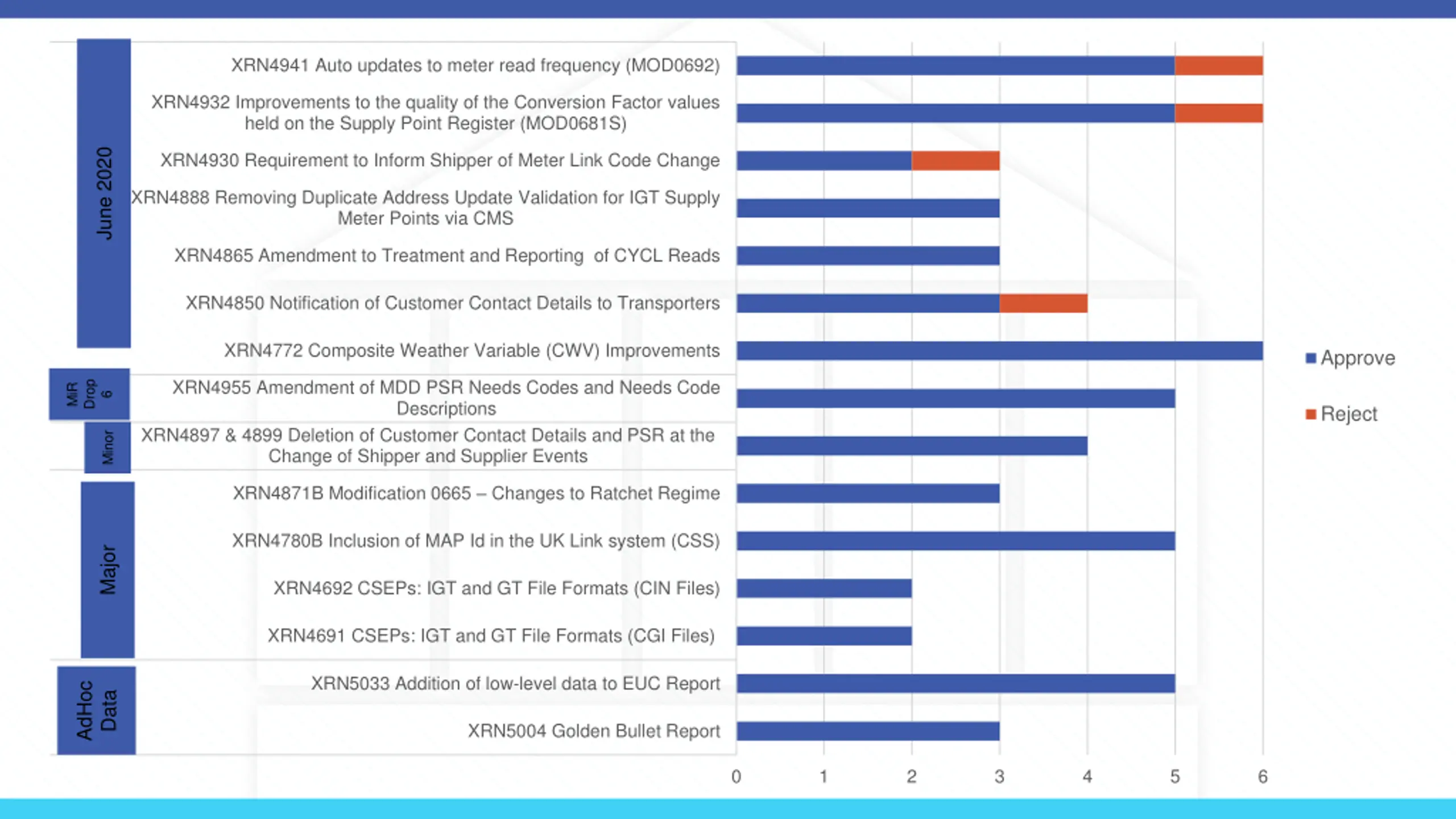

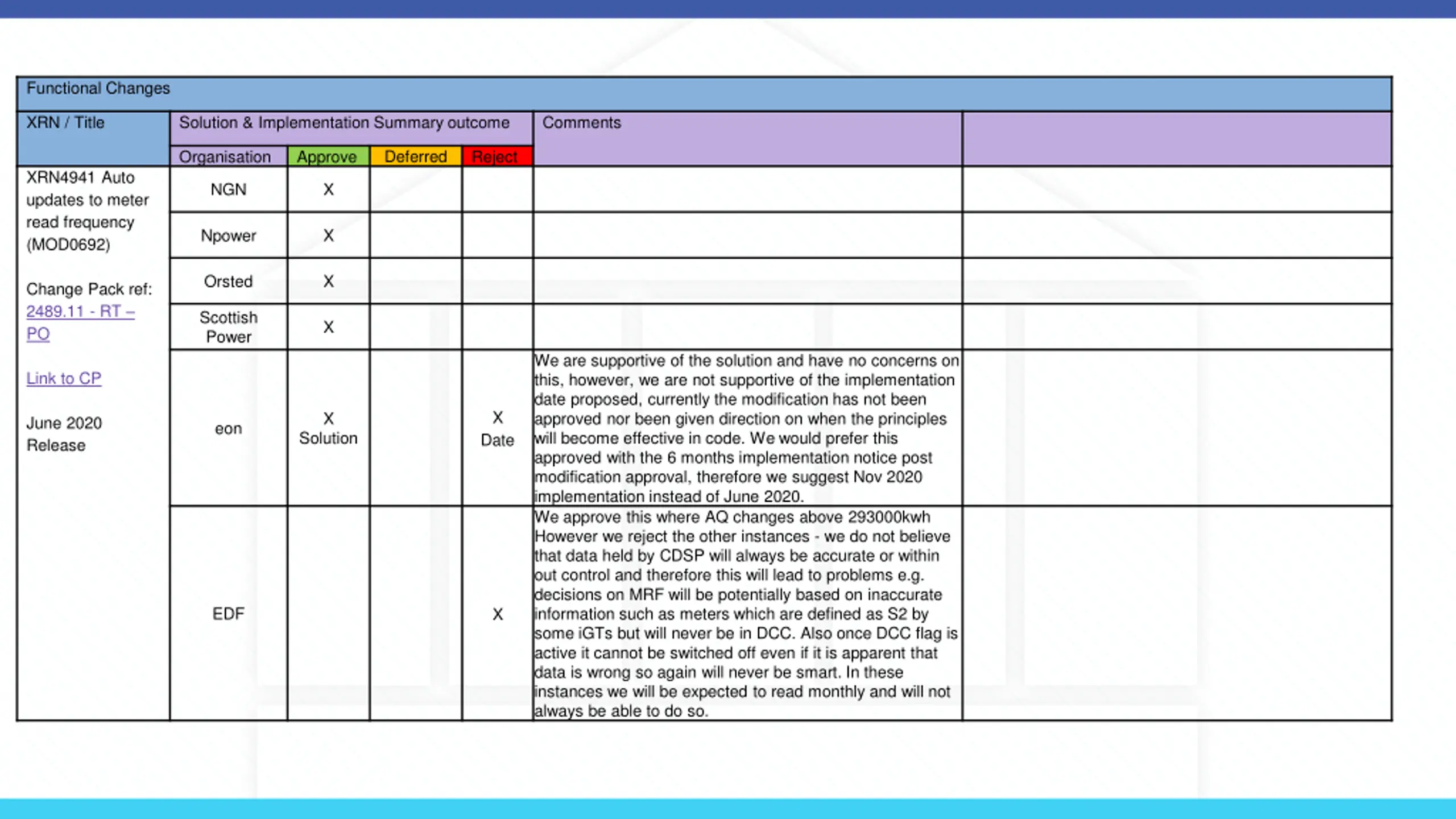

  17. Functional Changes XRN / Title Solution & Implementation Summary outcome Comments Deferred Organisation Approve Reject XRN4941 Auto updates to meter read frequency (MOD0692) NGN X Npower X Orsted X Change Pack ref: 2489.11 - RT PO Scottish Power X We are supportive of the solution and have no concerns on this, however, we are not supportive of the implementation date proposed, currently the modification has not been approved nor been given direction on when the principles will become effective in code. We would prefer this approved with the 6 months implementation notice post modification approval, therefore we suggest Nov 2020 implementation instead of June 2020. We approve this where AQ changes above 293000kwh However we reject the other instances - we do not believe that data held by CDSP will always be accurate or within out control and therefore this will lead to problems e.g. decisions on MRF will be potentially based on inaccurate information such as meters which are defined as S2 by some iGTs but will never be in DCC. Also once DCC flag is active it cannot be switched off even if it is apparent that data is wrong so again will never be smart. In these instances we will be expected to read monthly and will not always be able to do so. Link to CP X X June 2020 Release eon Solution Date EDF X

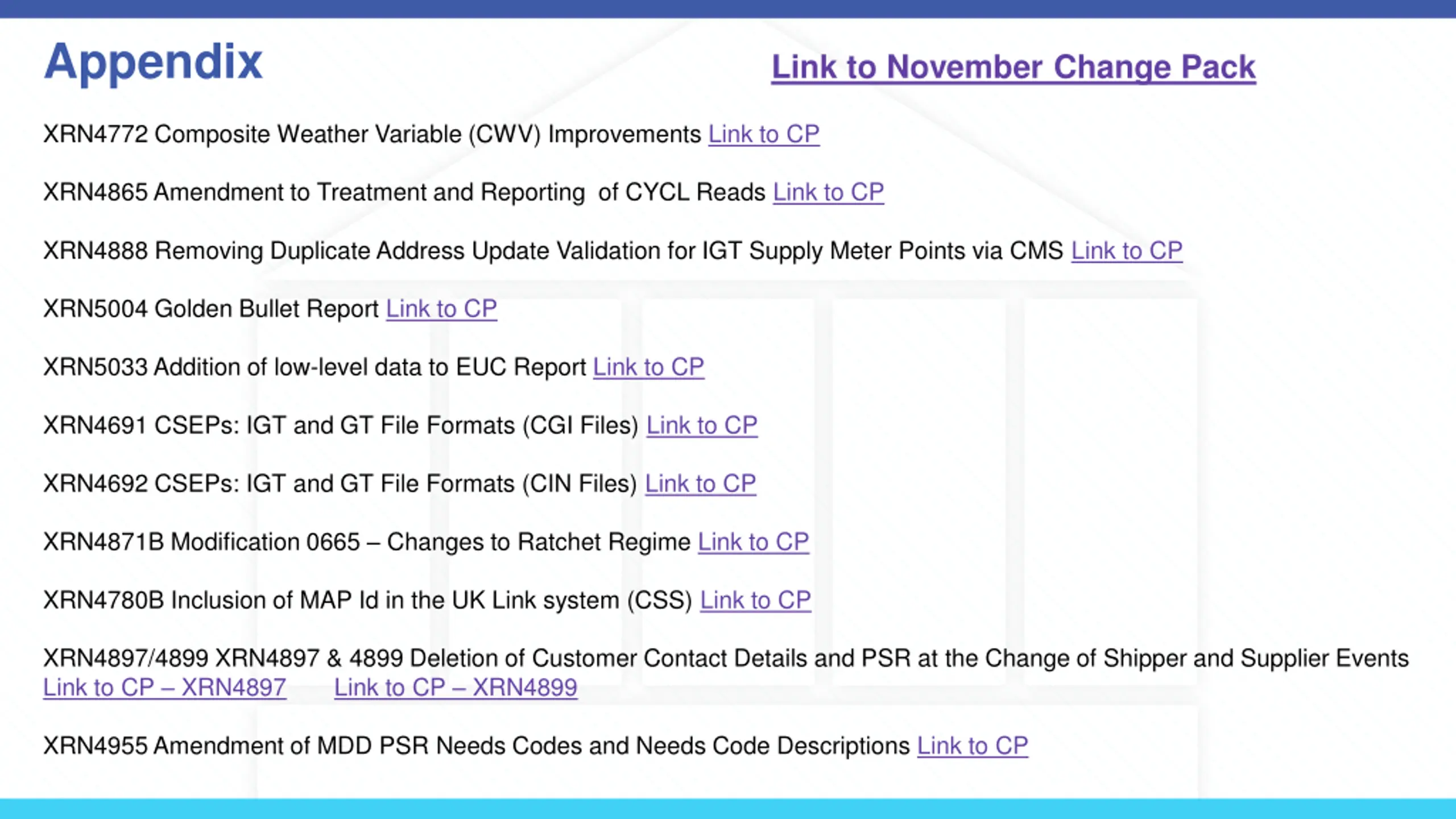

  18. Appendix Link to November Change Pack XRN4772 Composite Weather Variable (CWV) Improvements Link to CP XRN4865 Amendment to Treatment and Reporting of CYCL Reads Link to CP XRN4888 Removing Duplicate Address Update Validation for IGT Supply Meter Points via CMS Link to CP XRN5004 Golden Bullet Report Link to CP XRN5033 Addition of low-level data to EUC Report Link to CP XRN4691 CSEPs: IGT and GT File Formats (CGI Files) Link to CP XRN4692 CSEPs: IGT and GT File Formats (CIN Files) Link to CP XRN4871B Modification 0665 Changes to Ratchet Regime Link to CP XRN4780B Inclusion of MAP Id in the UK Link system (CSS) Link to CP XRN4897/4899 XRN4897 & 4899 Deletion of Customer Contact Details and PSR at the Change of Shipper and Supplier Events Link to CP XRN4897 Link to CP XRN4899 XRN4955 Amendment of MDD PSR Needs Codes and Needs Code Descriptions Link to CP

  19. 5. Implementation Plan - Outages Outages Outage Duration Change Request Number Committee Notified Date Impacted System Start Time Start Date End Date End Time Brief Description This is the cutover of the production environment for EFT, the outage will be on the weekend, the impact to the industry will be minor and that any system that utilises the Enhancement File Transfer (EFT) as a background application will be unable to send or receive files during the maintenance window as the application is switched from PET/KET to Chess/Cress. This is the cutover of the production environment for DCC the outage will be on the weekend, the impact to the industry will be minor and that any nominations/ confirmations that utilises the Data Communications Company (DCC) as a background application will be unable to send or receive files during the maintenance window as the application is switched from PET/KET to Chess/Cress. Subject to change due to multiple inflight changes at the time, but only by a week. This is the cutover of the production environment for CMS, the outage will be on the weekend, the impact to the industry should be minor and that the Contact Management System will be unable to send or recieve files, raise contacts and will not allow users to log on during the maintainence window as the application is switcheed from PET/KET to Chess/Cress. Subject to change due to multiple inflight changes at the time, but only by a week. This is the cutover of the entire RTP application, the outage will be on the weekend and the impact will be little to none and will unable to be utilised during the maintenance window as the application is switched from PET/KET to Chess/Cress. This will be cutover of the AD & BoKs application, the which includes the Actives Directory (AD), BoKs and Squid proxy the outage will be on the weekend and the impact will be little to none and will unable to be utilised during the maintenance window as the application is switched from PET/KET to Chess/Cress. This is the cutover of the entire Birst connector application, the outage will be on the weekend and the impact will be little to none and will unable to be utilised during the maintenance window as the application is switched from PET/KET to Chess/Cress. This is the cutover of the entire Control M application, the outage will be on the weekend and the impact will be little to none and will unable to be utilised during the maintenance window as the application is switched from PET/KET to Chess/Cress. Subject to change due to multiple inflight changes at the time, but only by a week. This is the cutover of the Internet routing for UKLink, the outage will be on the weekend and the impact will be minor, UKLink will be unable to be accessed and unable to send or receive files to corresponding systems during the maintenance window as the application is switched from PET/KET to Chess/Cress. 4970 EFT 07/02/2020 TBC 08/02/2020 TBC 13/11/2019 4970 DCC 28/03/2020 TBC 29/03/2020 TBC 13/11/2019 4970 13/11/2019 CMS 11/04/2020 TBC 12/04/2020 TBC 4970 13/11/2019 RTP 25/01/2020 TBC 26/01/2020 TBC 4970 13/11/2019 AD & BoKs 28/03/2020 TBC 29/03/2020 TBC 4970 13/11/2019 Birst Connector 11/04/2020 TBC 12/04/2020 TBC 4970 13/11/2019 Control M 16/05/2020 TBC 17/05/2020 TBC Internet routing for UKLink 4970 13/11/2019 23/05/2020 TBC 24/05/2020 TBC In order to complete Gemini Re-platform project implementation, an extended outage will be required on the Gemini system. Current estimated timescales for the GRP implementation are as follows: Gemini Maintenance Window: 3.00 to 5.00 Extended outage from 5.00 to 13.00 In the event of a roll back an additional outage from 13.00 to 17.00 If a change is identified to the above timings, further notification will be issued. Project team will work with NG and Xoserve Business to ensure appropriate measures are in place to manage all impacts due to the extended outage. 5/07/20 20 05/02/2 020 4550 Gemini 3.00 17.00 11/12/2019

  20. 6. Approval of Change documents 6.1 BER for XRN4779 Adding AQ to PARR Reports Voting Party Shippers
