Summer Shutdown 2023

Summer Shutdown 2023
Slide Note
Embed
Share

This document provides a detailed overview of the Summer Shutdown 2023 work schedule, including the timeline, milestones, trades work details, planning stages, and more. It outlines the parameters, duration, and tasks involved in the shutdown process along with key dates for commencement and completion. The information covers various aspects such as shutdown parameters, coordination, resource levels, and job collections, giving insights into the planned activities and expected outcomes for the shutdown period.

  • Summer Shutdown 2023
  • Work Schedule
  • Timeline
  • Milestones
  • Trades Work

Uploaded on Feb 17, 2025 | 0 Views

Download Presentation

Please find below an Image/Link to download the presentation.

The content on the website is provided AS IS for your information and personal use only. It may not be sold, licensed, or shared on other websites without obtaining consent from the author.If you encounter any issues during the download, it is possible that the publisher has removed the file from their server.

You are allowed to download the files provided on this website for personal or commercial use, subject to the condition that they are used lawfully. All files are the property of their respective owners.

The content on the website is provided AS IS for your information and personal use only. It may not be sold, licensed, or shared on other websites without obtaining consent from the author.

E N D

Presentation Transcript

  1. Summer Shutdown 2023 Cons Gattuso January13th, 2022

  2. Shutdown Parameters (Tentative) Start Shutdown We will determine if the need intensity reduction intensity as the work list evolves. Duration 10-12 Weeks (duration may change depending on the major tasks undertaken ) Beam Off Sunday July 9th@0001 hrs. Configuration Control Open surveys would take place Monday 10th-Wednesday 12th Specialty access would be from Wednesday-Friday Lighting Assessment, Phone Assessments, Fire protection testing, WiFi installation * General tunnel access would commence Monday July 17th Start of tunnel work Monday July 17th End of tunnel work Week of Monday October 9th HEP Monday October 16th 2 C. Gattuso

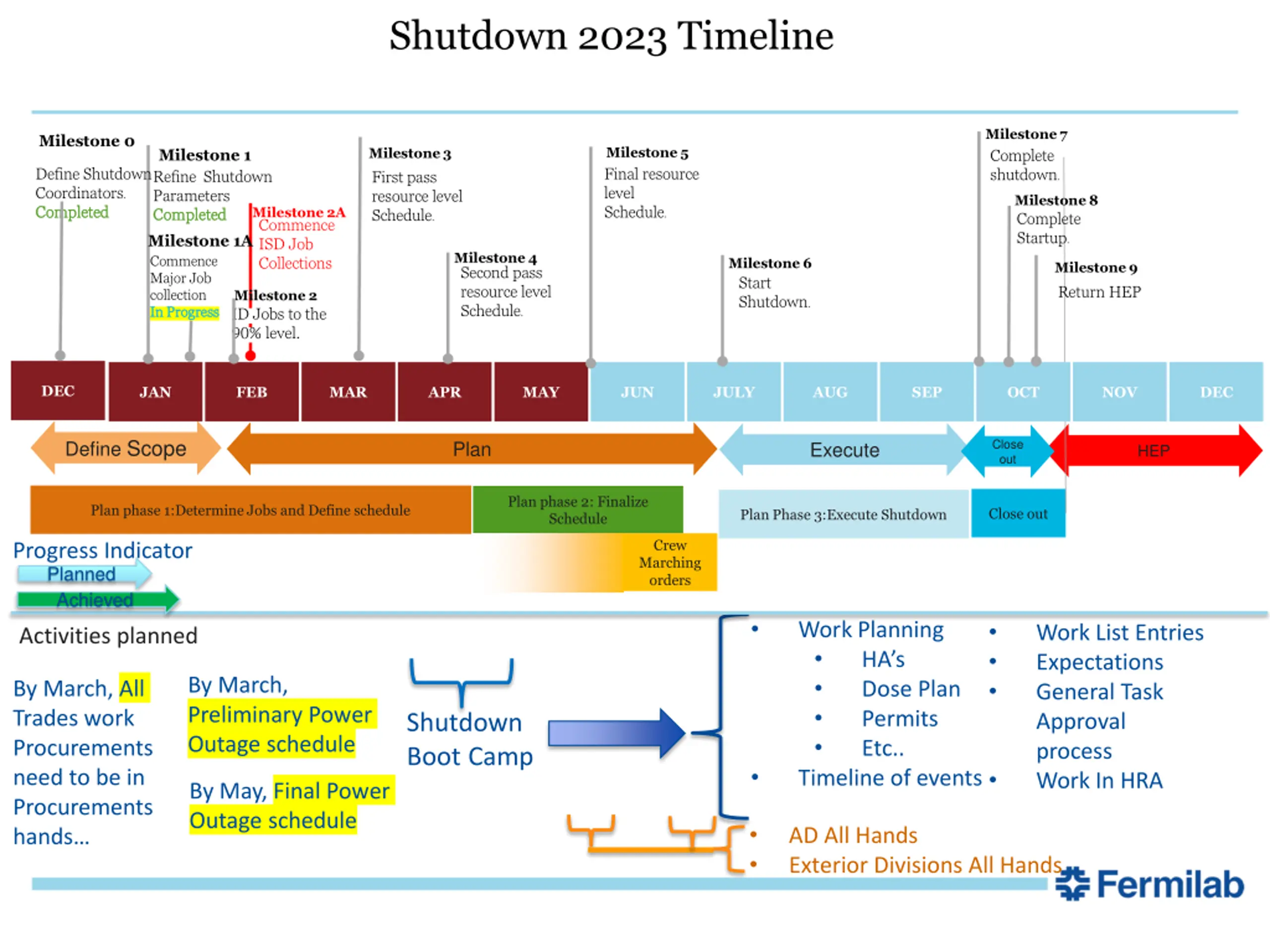

  3. Shutdown 2023 Timeline Milestone 7 Complete shutdown. Milestone 0 Milestone 5 Final resource level Schedule. Milestone 3 Milestone 1 Refine Shutdown Parameters Completed Completed Define Shutdown Coordinators. Completed Completed First pass resource level Schedule. Milestone 8 Complete Startup. Milestone 2A Commence ISD Job Collections Milestone 1A Milestone 4 Second pass resource level Schedule. Milestone 6 Start Shutdown. Commence Major Job collection In Progress In Progress Milestone 9 Return HEP Milestone 2 ID Jobs to the 90% level. DEC JAN FEB MAR APR MAY JUN JULY AUG SEP OCT NOV DEC Define Scope Close out Plan Execute HEP Plan phase 2: Finalize Schedule Plan phase 1:Determine Jobs and Define schedule Close out Plan Phase 3:Execute Shutdown Crew Marching orders Progress Indicator Planned Achieved Work Planning HA s Dose Plan Permits Etc.. Timeline of events Work List Entries Expectations General Task Approval process Work In HRA Activities planned By March, Preliminary Power Outage schedule By March, All Trades work Procurements need to be in Procurements hands Shutdown Boot Camp By May, Final Power Outage schedule AD All Hands Exterior Divisions All Hands

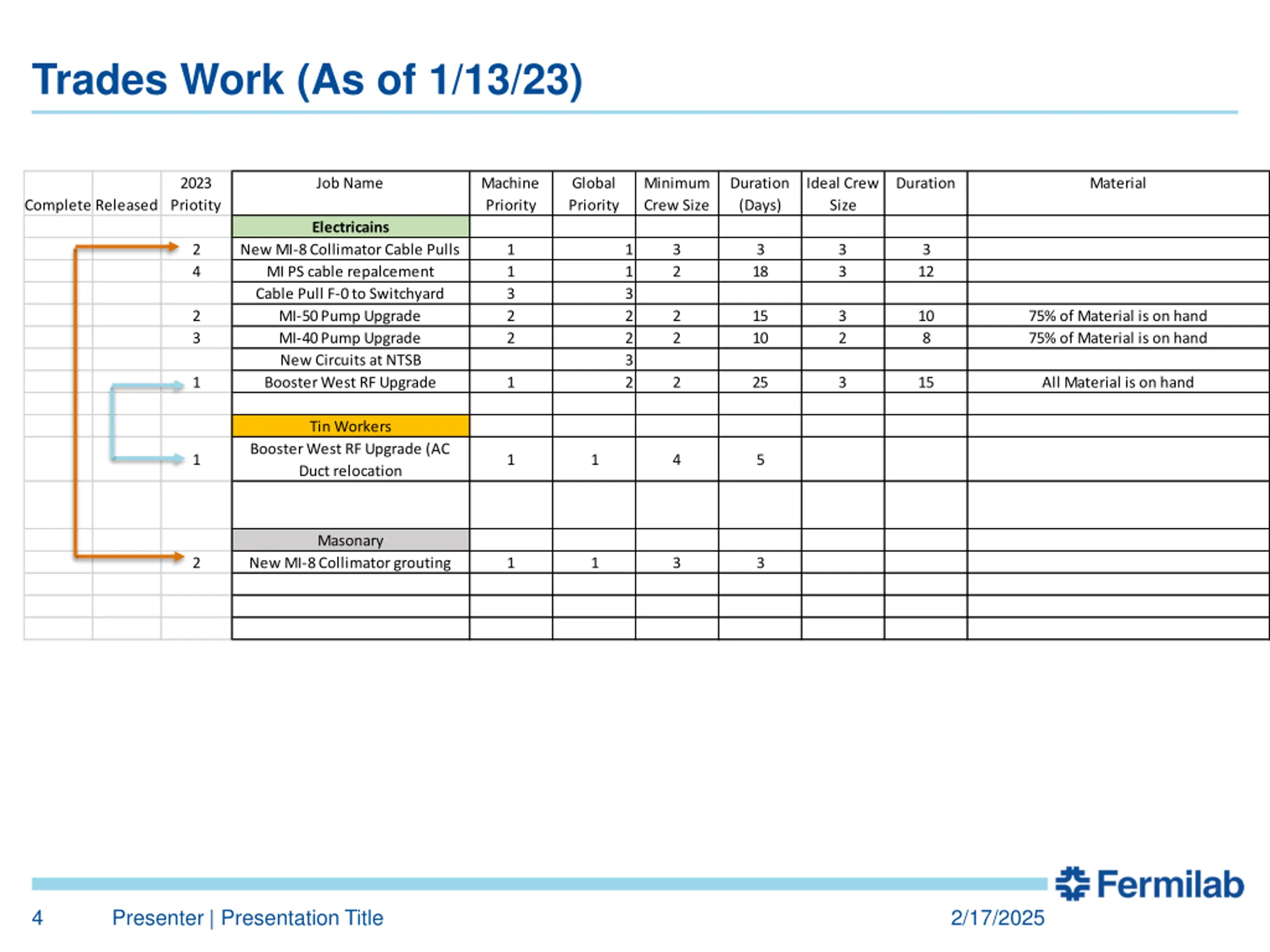

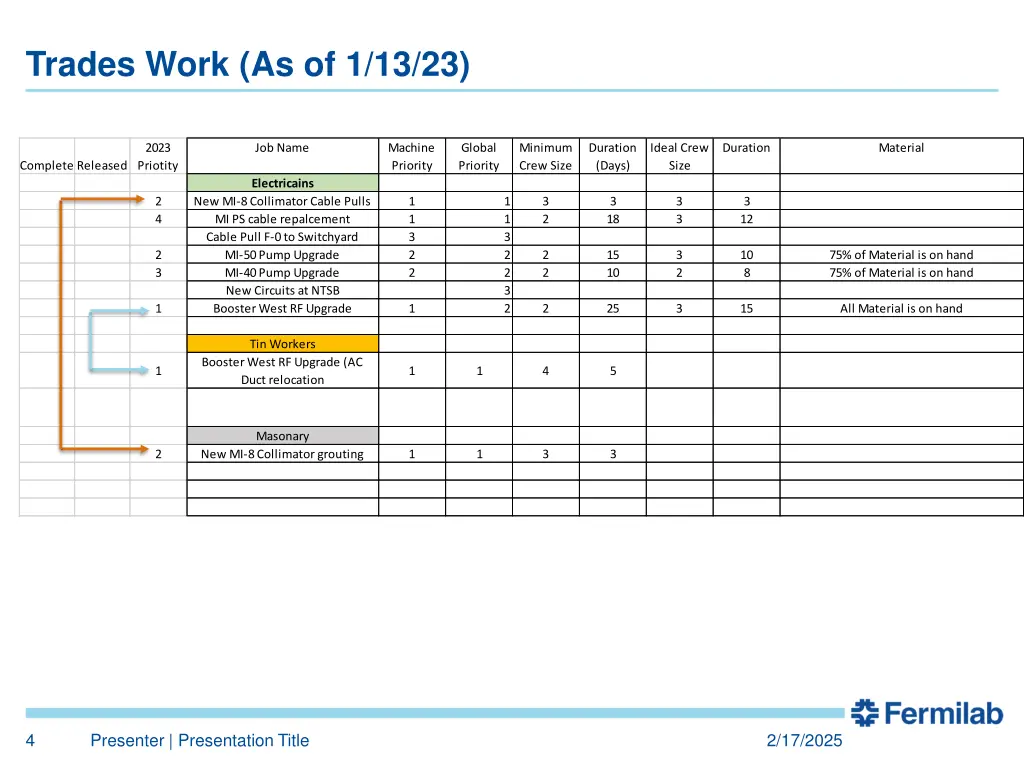

  4. Trades Work (As of 1/13/23) 2023 Priotity Job Name Machine Priority Global Priority Minimum Crew Size Duration (Days) Ideal Crew Size Duration Material Complete Released Electricains 2 4 New MI-8 Collimator Cable Pulls MI PS cable repalcement Cable Pull F-0 to Switchyard MI-50 Pump Upgrade MI-40 Pump Upgrade New Circuits at NTSB Booster West RF Upgrade 1 1 3 2 2 1 1 3 2 2 3 2 3 2 3 3 3 3 18 12 2 3 2 2 15 10 3 2 10 8 75% of Material is on hand 75% of Material is on hand 1 1 2 25 3 15 All Material is on hand Tin Workers Booster West RF Upgrade (AC Duct relocation 1 1 1 4 5 Masonary 2 New MI-8 Collimator grouting 1 1 3 3 4 Presenter | Presentation Title 2/17/2025

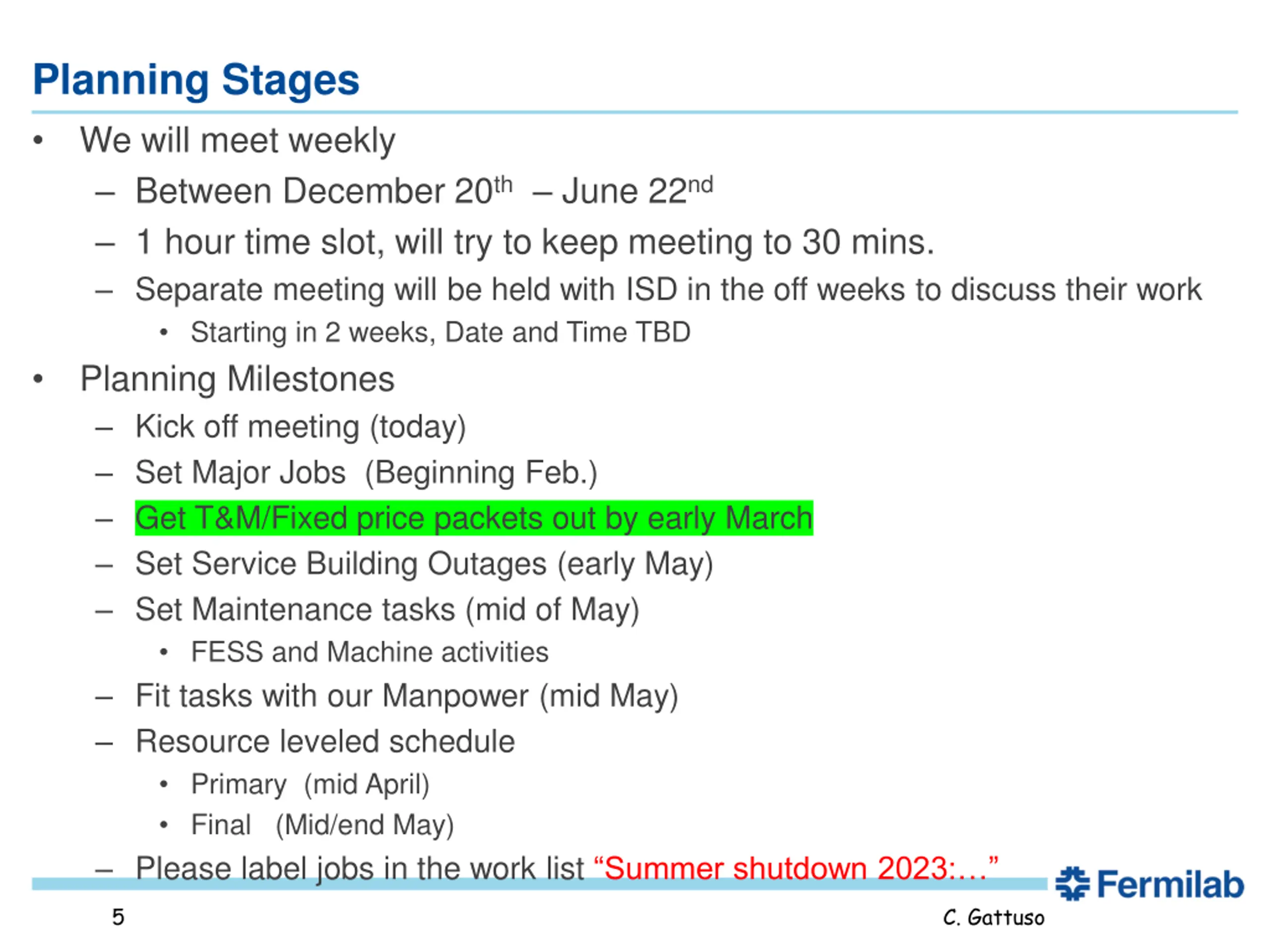

  5. Planning Stages We will meet weekly Between December 20th June 22nd 1 hour time slot, will try to keep meeting to 30 mins. Separate meeting will be held with ISD in the off weeks to discuss their work Starting in 2 weeks, Date and Time TBD Planning Milestones Kick off meeting (today) Set Major Jobs (Beginning Feb.) Get T&M/Fixed price packets out by early March Set Service Building Outages (early May) Set Maintenance tasks (mid of May) FESS and Machine activities Fit tasks with our Manpower (mid May) Resource leveled schedule Primary (mid April) Final (Mid/end May) Please label jobs in the work list Summer shutdown 2023: 5 C. Gattuso
