Construction Project Execution Guidelines

Slide Note
Embed
Share

This guide outlines the stages and activities involved in the execution of a construction project, including deployment of manpower, machineries, and additives, submission of required information, and establishment of laboratories. It also covers the responsibilities of contractors, project management units, and the implementation unit throughout the project lifecycle.


Uploaded on Oct 07, 2024 | 0 Views


Download Presentation

Please find below an Image/Link to download the presentation.

The content on the website is provided AS IS for your information and personal use only. It may not be sold, licensed, or shared on other websites without obtaining consent from the author. Download presentation by click this link. If you encounter any issues during the download, it is possible that the publisher has removed the file from their server.

E N D

Presentation Transcript

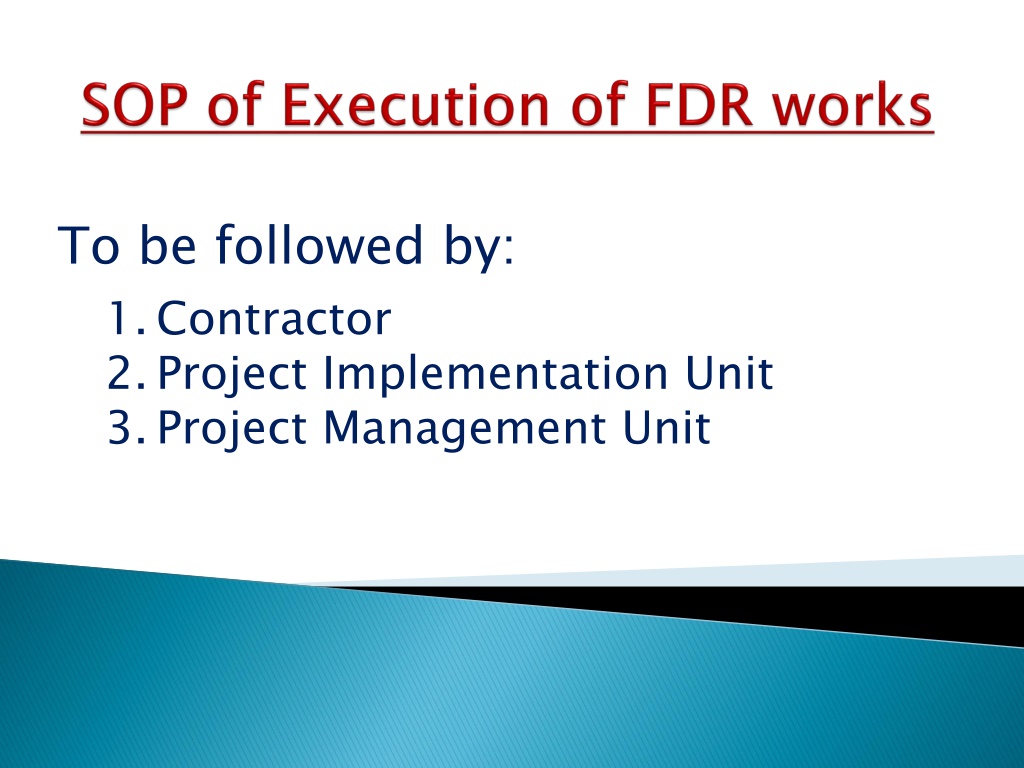

  1. To be followed by: 1.Contractor 2.Project Implementation Unit 3.Project Management Unit

  2. Stages: 1.Deployment of Manpower 2.Deployment of Manpower for Lab 3.Deployment Execution of Manpower of

  3. 4. Deployment of Machineries: i. Reclaimer ii. Cement Spreader iii. Pat Foot Roller iv. Tandum Roller/Soil Compactor v. Pneumatic Tyre Roller vi. Water Tanker vii.Motor Grader Spreader & Additive

  4. 5. Arrangement of Additive: Details submitted by the contractor i. Brand Name and Manufacturer Detail ii. IRC Accreditation Certificate iii.Leaching Test Report iv.Procurement (submitted to the PIU time to time). of Additives required to be Accreditation or Equivalent Detail of the Material

  5. 6. Submission of JMF Following information is to be submitted to the PIU: i. MDD and OMC ii.7th day and 28th day UCS iii.Flexural Strength iv.Durability v.Residual Strength

  6. 7. Stagewise Activities of Work Execution 1. Collection of Material Sample for JMF Responsible Person -PIU+PMU+Contractor 2. Procurement and Evaluation of JMF Responsible Person -PIU+PMU 3. Establishment of Information Sign board & Citizen Information Board Responsible Person Contractor 4. Setting of works - Establishment of Bench Mark (RBM/TBM)/ Reference Pillers Responsible Person Contractor

  7. 5. Establishment of Central Laboratry and Packagewise Laboratories Responsible Person-Contractor 6. Joint Survey of the road and CD structure Responsible Person - PIU & Contractor 7. Finalization of Road level Responsible Person PIU & Contractor 8. Clearing & Grubbing Responsible Person Contractor

  8. 9. Execution of Embankment and Subgrade Responsible Person-Contractor 10. Dismentaling of Existing Pavement & Spreading in required width Responsible Person - Contractor 11. Construction of Trial Patch Responsible Person PIU & Contractor 12. remaining length Responsible Person PIU, PMU & Contractor Execution of Stabilization work of

  9. 13. Prime coat over FDR base Responsible Person-PIU & Contractor 14. Tack Coat Responsible Person - Contractor 15. Laying of SAMI Layer Responsible Person PIU, PMU & Contractor 16. Laying of Tack coat over SAMI layer under with BC Responsible Person PIU, PMU & Contractor

  10. 17. Laying of BC Responsible Person- PIU, PMU & Contractor 18. Speed braker as required Responsible Person - PIU & Contractor 19. Construction of Side drain and paneled concrete pavement in the built up area. Responsible Person PIU & Contractor 20. Fixing of Caution Board & Village Boards, Logo Board, Fixing of Cateyes,. Marking of Edge Lines. Responsible Person PIU & Contractor
