Construction Act
(formerly Construction Lien Act)

On December 12, 2017, Bill 142, Construction Lien
Amendment Act, 2017 received Royal Assent.  The Bill
amends the
Construction

Lien Act
(Ontario), and renamed
it the
Construction Act
.  The substantive amendments
modernizing the new Act also came into force on
July 1,
2018
.
Other amendments including the introduction of prompt
payment, adjudication, regulations and forms came into
force on
October 1, 2019
.

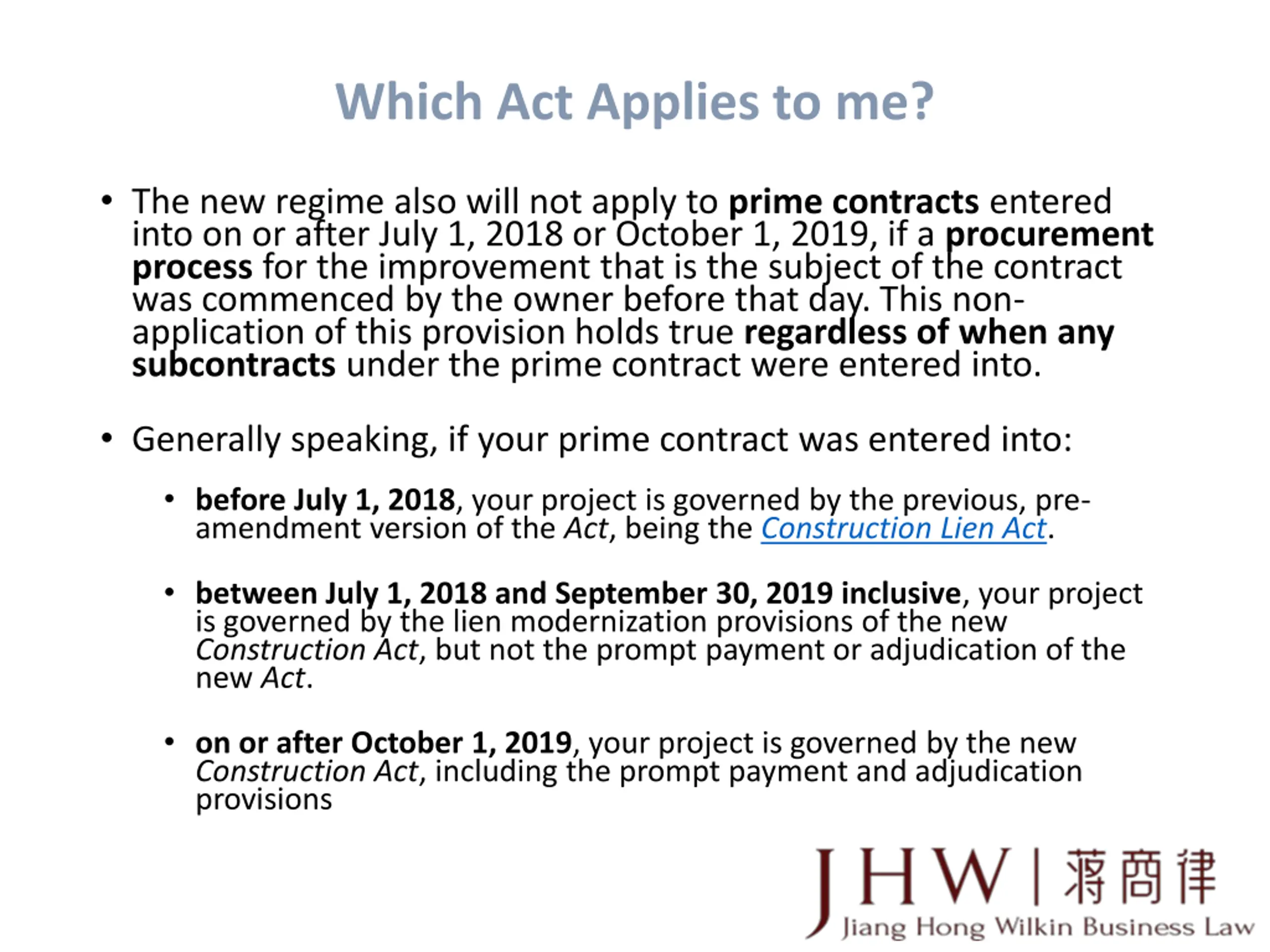

Which Act Applies to me?

The new regime also will not apply to
prime contracts
entered
into on or after July 1, 2018 or October 1, 2019, if a
procurement
process
for the improvement that is the subject of the contract
was commenced by the owner before that day. This non-
application of this provision holds true
regardless of when any
subcontracts
under the prime contract were entered into.
Generally speaking, if your prime contract was entered into:
before July 1, 2018
, your project is governed by the previous, pre-
amendment version of the
Act
, being the
Construction Lien Act
.
between July 1, 2018 and September 30, 2019 inclusive
, your project
is governed by the lien modernization provisions of the new
Construction Act
, but not the prompt payment or adjudication of the
new
Act
.
on or after October 1, 2019
, your project is governed by the new
Construction Act
, including the prompt payment and adjudication
provisions

Construction Pyramid
Can include a Landlord
and/or Tenant
Includes Engineer or
Architect having direct
contract with Owner

What is a construction lien?

Section 14(1) of the Act provides that,
“a person who supplies
services or materials
to an
improvement
 for an owner, contractor or
subcontractor,
has a
lien upon the interest
of the
owner

in the
premises
 improved
for the
price
 of those services or materials.”

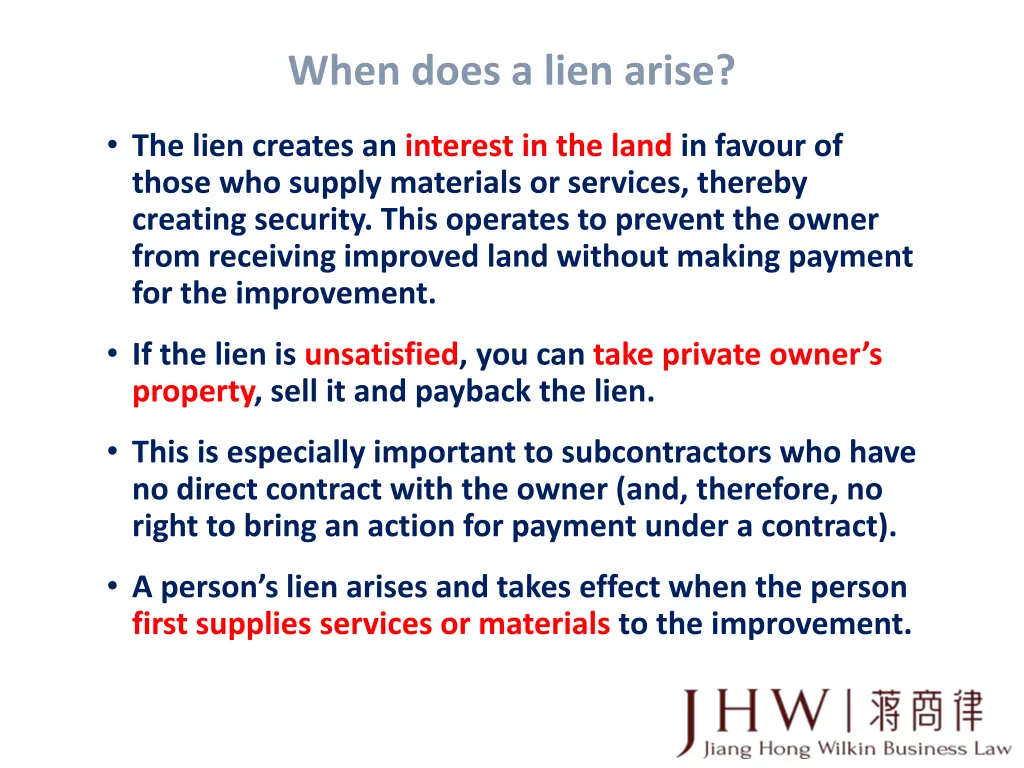

When does a lien arise?

The lien creates an
interest in the land
in favour of
those who supply materials or services, thereby
creating security. This operates to prevent the owner
from receiving improved land without making payment
for the improvement.
If the lien is
unsatisfied
, you can
take private owner’s
property
, sell it and payback the lien.
This is especially important to subcontractors who have
no direct contract with the owner (and, therefore, no
right to bring an action for payment under a contract).
A person’s lien arises and takes effect when the person
first supplies services or materials
to the improvement.

Who can lien?

Any person who is under a contract and has supplied
services and/or materials to an “
improvement
” has a
right to lien.

Pretty well all persons working on a construction project
will have a right to lien, including suppliers of rental
equipment, architects, and those who provide design
services.

What can you lien?

The Act makes reference to an “
improvement
” to set out what type of
property and what type of work can be liened.
An improvement includes the
alteration of and/or the addition to the
property
.  This is a broad definition and encapsulates most
construction activity.
It also includes the
construction and installation
of industrial,
mechanical, or electrical equipment, when that equipment is essential
to the regular use of that property.
Affixed machinery in a plant such as an automotive assembly plant
would fall within the definition of an improvement.
It is also possible to lien for work done for a
capital repair
.  This type of
work is for work done to extend the economic life of a building or
structure.
It has to be noted that this does not include just any type of repair, and
does not include preventative maintenance.

What is a Capital Repair?

a
capital repair
to land is
any repair intended to extend the normal economic life of
the land or of any building, structure or works on the land,
or
to improve the value or productivity of the land, building,
structure or works,
but does not include maintenance work performed in
order to prevent the normal deterioration of the land,
building, structure or works or to maintain the land,
building, structure or works in a normal, functional state.

What services can you lien for?

Supply of services can include:

engineering services
and architectural services
rental of equipment
security services to a construction site
services of estimating and job supervision.

What is the value of your lien?

The Act gives you the ability to lien for the “
price
” of
services and materials that you provided to the project.
“Price” is a defined term and means:
the
amount agreed
between the parties, or if there
is no agreement on the amount, then the
market
value
of the work; AND
any
direct costs
incurred as a result of a delay not
caused by provider

What does “direct cost” really mean?

Direct Costs
” are “reasonable costs” of performing the
contract or subcontract during the extended period of
time, including:
Costs related to the additional supply of services or
materials (including equipment rentals);
Insurance and surety bond premiums; and
Costs resulting from seasonal conditions;
that, but for the extension, would not have been
incurred, but
do not
include indirect damages suffered as
a result, such as loss of profit, productivity or
opportunity, or any head office overhead costs.

What is the value of your lien?

You are not entitled to lien for
interest
 on the amount
you are owed, nor can you lien for any
indirect costs
associated with your claim.
You are still at liberty to assert a claim for the amounts
as part of a claim for
damages
 under regular contract
law.
You should never exaggerate the value of your lien.
The Act contains specific provisions about an
exaggerated” lien
and that you could be liable for the
costs that someone incurs as a result of the
exaggerated lien.

Written Notice of a lien

The first step which you may wish to consider prior to the
actual registration of a lien is a written notice of lien.
Typically this can be used in the event that your lien rights
do not expire for a period of time that will permit the
written notice to have time to be effective.
A written notice of a lien is completed by personally
serving
a prescribed form (Form 1) on the person(s) above you in
the construction pyramid.
Upon receipt of a written notice of lien, the payer, i.e. the
person above you in the construction pyramid, must
retain
the full amount in dispute
.
Written notice of lien also affect
s

priority
 of lien against
mortgages.
Furthermore, if you are still unpaid after the written notice
of lien is sent, you still need to register your lien on title or
you will lose your lien rights.

How do you register a lien?

The act of placing a lien on title is known as
“preserving” your lien.
It is the
registration of your lien on title
.
There is a specific form “Form 12-Claim for Lien” that
has to be completed, with information such as: • your
proper legal name; • who you contracted with; • the
name of the owner; • the time in which you supplied
to the project; • your total contract value; • how much
you are owed; • what type of work you supplied;
This can be done by visiting the local Land Registry
Office in the county of the project.
Lawyers have access to a program called Teraview
which allows them to register your lien electronically.

When can you lien?

Once you have supplied materials or services to site,
you have a lien.
You can register a lien even though the money is not
yet due and owing and if you have yet to render an
invoice.
In theory, you could register a lien every day you are on
site even though you have not invoiced for the work.
In practice, that is a terrible idea.

When can you lien?

By when do you have to preserve lien?
There are strict timelines that are outlined in the Act.
If you miss a deadline, you will lose your right to lien
and may not see any payment.
Before you start to count days, you first have to
determine whether you are a “contractor” or a
“subcontractor”.  A “contractor” has a contract directly
with the owner.  A “subcontractor” is anyone with a
contract with the contractor, or with another
subcontractor (i.e. a supplier).

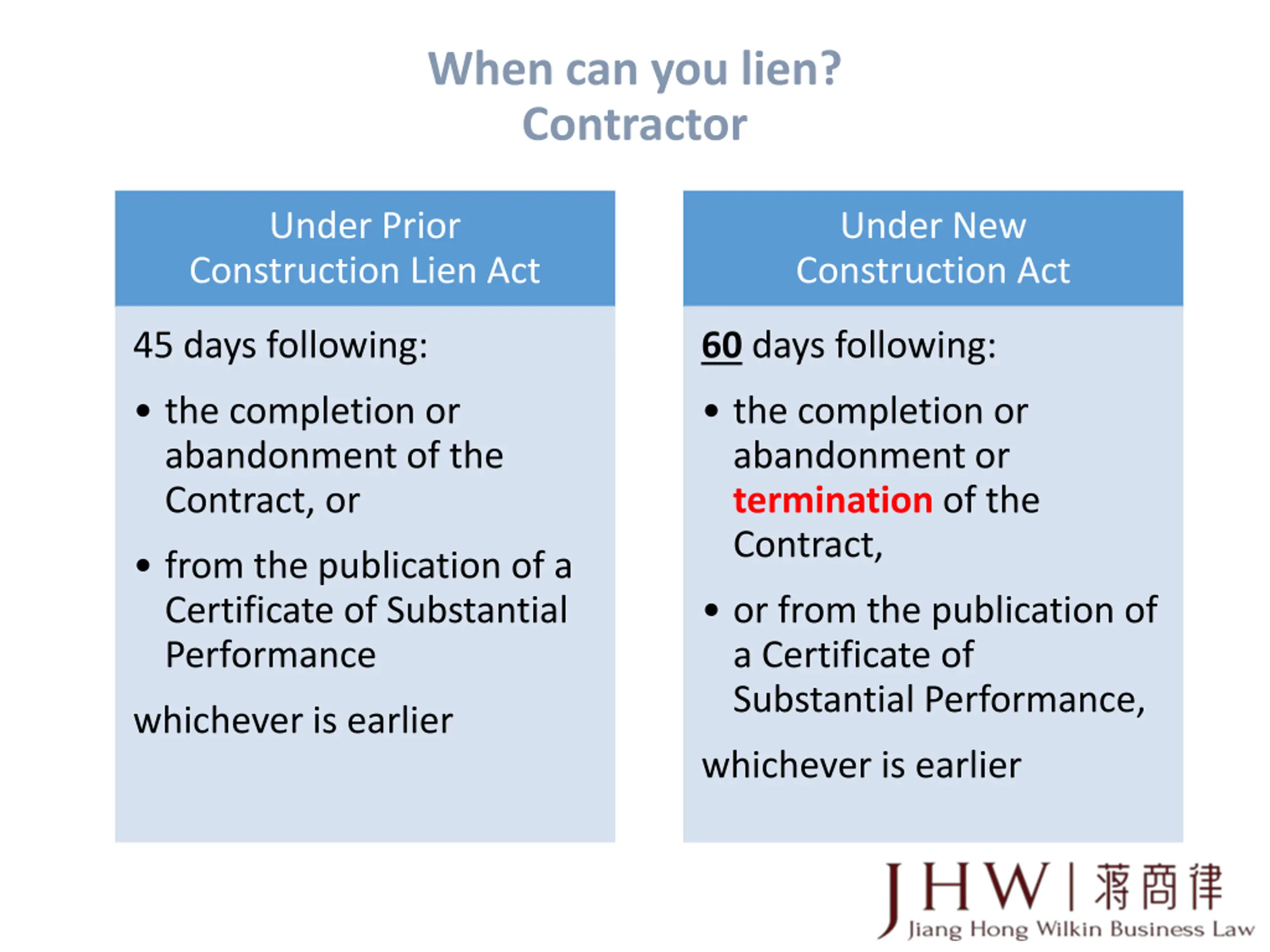

When can you lien?
Contractor

When can you lien?
 Lien of a Contractor

Section 31 of the Act has been amended to increase
the deadline to preserve a lien from 45 days to 60 days.

Termination of a contract has been added as a trigger
in determining the timeline for preserving a lien.

If a contract is terminated, a Notice of Termination
under Subsection 31(6) (Form 8) must be published by
the owner, contractor or a person whose lien is subject
to expiry.

When can you lien?
Subcontractor

When can you lien?
Lien of a Subcontractor

A subcontractor, or any other person, must register its

lien within 60 days of the earlier of:
the date upon which the certificate of substantial
performance is published (if there is one);
the date that they last supply services or materials to
the project;
the date that the contract was completed, abandoned,
or terminated; and
the date that the subcontract is certified to be
complete (this rarely occurs).

What if you start an adjudication?

Adjudication and expiry
(10) If the matter that is the
subject of a lien
that has not
expired is also a matter that is the subject of an
adjudication under Part II.1, the lien is deemed, for the
purposes of this section only, to have expired on the
later of the date on which the lien would expire
under
section 31 and the
conclusion of the 45-day period next
following the receipt by the adjudicator of documents
under section 13.11
.

Perfection of Lien

Once the lien is registered, you will have to “perfect”
the lien by starting a court action.
This can now be done in Small Claims Court if the value
of the lien is less than the $25,000 limit.
The claim is issued in the Superior Court, and it has to
be done within
90 days of the last day in which you
could have registered your lien
.
After the statement of claim is issued, a
certificate of
action
 also has to be issued, and then
registered on
title
 of the property.
If you fail to commence the court action, or fail to
register the certificate of action, your lien will expire
and it cannot be enforced.

Maintaining the Lien

Once the court action is commenced, it proceeds through
the litigation process similar to any other lawsuit.
There are some modifications to the process that do differ
from an ordinary lawsuit.
There is no automatic disclosure of documents, no right to
examinations for discovery, and no mandatory mediation.
However, it is usually agreed between the parties that these
steps will take place, depending on the nature of the matter.
In order to maintain your lien, you will have to take steps to
advance the court action.
Within
two years of starting the claim
, you will have to
ensure that it is set down for trial or that there has been an
Order directing a trial.  If this is not done, your lien will
expire.

Lien Process
By Contractor

Lien Process

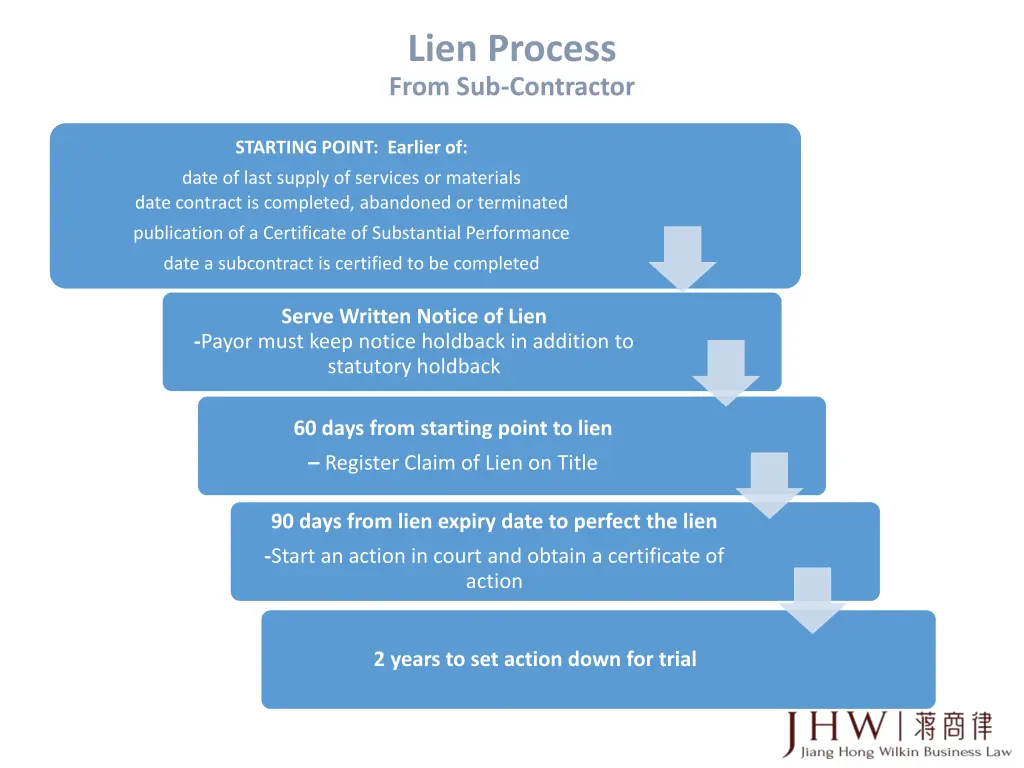

From Sub-Contractor

Certificate of Substantial Performance

Not all construction projects will carry with them a
requirement for a certificate of substantial
performance (“CSP”).
A CSP can be published by a payment certifier (i.e.
architect) if there is one, or by the owner and
contractor.
The CSP serves as notice that the project is almost
complete, and acts to cut off a significant portion of
lien rights.

Certificate of Substantial Performance

A CSP can only validly be published when two criteria are
met:
The improvement is “ready for use”; AND
Where the improvement to be made is capable of
completion, or where there is a known defect,
correction, at a cost of not more than:
OLD DEFINITION: 3% of the first $500,000 of the contract
price; 2% of the next $500,000 of the contract price, and 1% of
the balance
NEW DEFINITION: 3% of the first  $1 million of the contract
price; 2% of the next $1 million of the contract price, and 1%
of the balance

Completion or Deemed Completion

A contract is deemed completed when the price of
completion is not more than the lesser of:
1% of the contract price; and
$1,000 (old Act)/$5,000 (new Act)

Termination of Contract

In the event that a contract or a subcontract is
terminated, a notice is required to be published.
If a contract is terminated, either the owner or the
contractor or other person whose lien is subject to
expiry shall publish a
notice of the termination
(Form
8) and, for the purposes of this section, the date on
which the contract is terminated is the termination
date specified in the notice for the contract.
Daily Commercial News

Declaration of Last Supply

When there is no certification of substantial performance of
the contract, or for services or materials supplied after the
date of the substantial performance, the 60-day period starts
on,
the date on which the person last supplied services or
materials to the improvement,
the date the contract is completed, abandoned or
terminated, and
the date a subcontract is certified to be completed, where
the services or materials were supplied under or in respect
of that subcontract.

Can you lien a public road or a street?

Yes, although a lien does not “attach” to title in the same
way.

Rather than register a lien on title you preserve it by
providing certain people with the lien (clerk in case of
municipality).

Can you lien government property?
Federal

Federal government property cannot have liens
enforced against them.

The Federal Government takes the position that the
Act has no application at all to its property.

Generally, most Federal projects are protected by
Labour and Material Payment Bonds, which can be
utilized by trades and suppliers to obtain payment.

Can you lien government property?
Provincial

Provincial government property is subject to the Act.
The lien is preserved by providing the government
body in charge of the project with the claim for lien.
The property is never “sold” to enforce the lien, rather
the lien acts as a mechanism to be entitled to share in
the holdback.

Can you lien government property?
Municipal

Municipal property is subject to the Act.
The lien is preserved by providing the clerk of the
municipality with a copy of the Claim for Lien.
Similarly, the property is never “sold” to enforce the
lien, rather the lien acts as a mechanism to be entitled
to share in the holdback.

What about landlords?

Even where the landlord does not meet the definition of
Owner, the Act now provides lien claimants with potential lien
rights against the landlord:
if the lease contains a
leasehold improvement
clause that
requires the landlord to pay a certain amount towards the
improvement, the
landlord
 is
liable to the lien
claimants for
10%
of that amount
This means if the
landlord funds an improvement
through a
tenant improvement allowance
, or
rent abatement
or other
tenant inducement
, contractors performing the work will
automatically have a lien right against the landlord for the
10%
a s. 39 request is available to determine if there is such a
leasehold improvement clause

What about landlords?

The landlord can also be fully liable for the lien amount (ie.
the price of services or materials supplied by the contractor)
if it meets the criteria set out in the definition of "
owner
".
The landlord is deemed to be an "owner" under the New
Act if:
the landlord has an interest in the improved premises;
the landlord requested the improvement; and
the improvement was made on the landlord's credit or behalf, or
with the landlord's privity or consent, or for the landlord's direct
benefit.
If each of these criteria is met, the
contractor may seek full
payment from the landlord
 (as "owner") (to the extent that
the contractor is not paid) using a construction lien,
regardless of whether there is a direct contract between the
contractor and landlord.

What about condos?

Liening a Condo Unit

Same way as registering a lien on other non-condo
property owners
Lien is against the “unit” but not against the “common
elements”.
Lien can be against any lands “enjoyed” with the unit.
So if unit owner owns parking and/or locker, can also
lien parking and/or locker.
When perfecting the lien, the Statement of Claim will
name only the individual registered owner of the unit
and not the other unit holders or the condominium
corporation

Liening Condo Comment Elements?

Unlike a “unit”, the
common elements
are not individually owned
and
do not have a unique PIN
associated with them.
As such, registering a lien against the common elements requires a
lien claimant to list all of the units in the “Properties” section of
the claim for lien—thereby
liening each unit in the condominium
for its proportionate share in the common elements
.
A lien claimant who wants to register a lien relating to an
improvement to the common elements must
give notice
of the
lien’s to the condominium corp. and to every unit owner or every
owner of a common elements condominium corporation.
When
perfecting the lien
by commencing an action, it is not
necessary to name every unit holder as a defendant in the
Statement of Claim.  Under the Condominium Act, it is sufficient
to
name only the condo corp
.
Condominium unit owners can
remove liens from their unit
that
are related to improvements to the common elements, by making
a motion to court paying his portion of the lien to court.

Liening Condo Corp before registration?

Under the Construction Act, an owner “does not include a
home buyer
”.
Thus, if a
lien is registered
 against the “premises”
after
 the
condominium declaration and description
has been
registered
 and title to the “units” and “common elements”
have been transferred from the developer to individual
owners, the
lien will most certainly be defeated
.
The answer: s. 33.1 of the Construction Act which requires
that
notice be published
that a project is on the cusp of
being registered as a condominium. Notice is Form 11 and to
be published before condo registration
Lien claiments will then make sure they
register the lien
before the condo registration
.

How do you get a lien off title?

If you are unable to come to a resolution, it may be necessary
to have the lien removed from title.
You can bring a motion to court, without telling the lien
claimant, so long as you pay into court cash, a lien bond, or
a letter of credit in the amount of the lien, plus 25% or
$250,000, whichever is less, as security for costs.
You will obtain a court order that you register on title of the
property that removes the lien, and the court action
proceeds.  The court action proceeds with money in court
being recoverable by the lien claimant at the end of the day.
If a lien is out of time or is otherwise invalid, you can bring a
motion to declare that the lien is invalid.  If you are
successful, the lien is deleted.  However, this does not
prevent a breach of contract claim from continuing.

Can you extend your lien rights?

What is your last day on site?
Can you attend back on site and hammer a nail in to
extend lien rights?
Unless you are returning to the project to complete
some significant contract work, your lien rights will
expire.
You cannot return to the site and supply a drywall
screw in the hopes of reviving your lien rights.
Furthermore, you cannot claim your last day of supply
was when you returned to complete deficiency work.

What are holdbacks?

A holdback is a requirement that all owners, contractors
and subcontractors
withhold part of the cost
of the services
or materials they receive on a project.

Statutory Holdbacks

Basic holdback
22 (1) Each payer upon a contract or subcontract under which a lien
may arise shall retain a holdback equal to
10 per cent of the price
of
the services or materials as they are actually supplied under the
contract or subcontract
until all liens
that may be claimed against
the holdback have
expired
 or been
satisfied, discharged
or
otherwise provided for under this Act.
Finishing holdback
(2) Where the contract has been certified or declared to be
substantially performed
but services or materials remain to be
supplied to complete the contract, the payer upon the contract, or a
subcontract, under which a lien may arise shall retain, from the date
certified or declared to be the date of substantial performance of
the contract, a separate holdback equal to
10 per cent
 of the price of
the remaining services or materials as they are actually supplied
under the contract or subcontract,
until all liens
that may be claimed
against the holdback have
expired
 or been
satisfied, discharged
or
otherwise provided for under this Act.

The Notice Holdback

In the event of receipt of a written notice of lien or
receipt of a claim for lien, the payer must maintain a
notice holdback, which must be equal to the amount in
dispute.
If they do not, then the payer may effectively have to
pay twice for the work.
For example, if a subcontractor on a project registers a
lien and provides that lien to the owner of the project,
the owner has to withhold from the general contractor
the amount of that lien.

The Notice Holdback

Payments that may be made
24 (1) A payer may, without jeopardy, make payments on a
contract or subcontract up to 90 per cent of the price of the
services or materials that have been supplied under that
contract or subcontract
unless
,
prior to making payment
,
the payer has received written notice of a lien
.
(2) Where a payer has received written notice of a lien and
has retained, in addition to the holdbacks required by this
Part,
an amount sufficient to satisfy the lien
, the payer may,
without jeopardy, make payment on a contract or
subcontract up to 90 per cent of the price of the services or
materials that have been supplied under that contract or
subcontract, less the amount retained

Sample of Statutory Holdback and Notice Holdback

Owner was installing a hot tub
Contract price is $10,000, and tub was installed
Owner has to holdback $1,000 (10%) for 60 days: Basic hold back
Before end of 60 days, owner receives written notice of a lien
from the manufacturer for $ 6,000 and another lien from the
installer for $1,500
So, how much does the owner holdback? The answer is
$ 8,500. The full amount of the written notices (Notice holdbacks
of $7,500) together with the statutory holdback (basic statutory
holdback of $1,000)
No finishing holdback in this case.
On day 61, if the liens were not registered on title, the liens expire
and Owner can pay entire $10,000 to contractor
On day 61, if the liens were registered, Owner pays contractor
$1,500.  Owner pays $8,500 when the liens were dealt with.

Holdbacks for Public Sector Owners?

Public sector owners, such as the Crown, municipalities
and broader public sector organizations, are required to
have a surety bond on public contracts above a
prescribed amount, and alternative financing and
procurement arrangements (AFPs) are subject to a
minimum coverage limit, to protect subcontractors and
workers if the general contractor files for bankruptcy.

Public Contracts?

Part XI.1 has been added to the Act to establish requirements
for a
contractor
 who enters into a contract with an owner that
is the Crown, a municipality or a broader public sector
organization (a “
public contract
”) to provide the owner with a
labour and material payment bond
and with a
performance
bond
, if the contract price is above the amount set out in the
regulations.
The general regulation under the Act provides that the contract
price must be $
500,000
 or higher.
The surety bonds must meet the following requirements:
Both bonds must be issued by an insurer that is licensed under
the Insurance Act to write surety and fidelity insurance, have a
coverage limit of at
least 50% of the contract price
and extend
protection to subcontractors and suppliers.
Labour and material payment bonds must extend protection to
subcontractors and persons supplying labour or materials to the
improvement.

Public Contracts?

The surety bond requirements do not apply to:
A contractor who is an architect
A contractor who is an engineer

Main changes to the holdback rules

Holdbacks
 may now be retained using security:
1.
A
letter of credit
in the prescribed form.
2.
A demand-worded
holdback repayment bond
in the
prescribed form.
3.
Any other form that may be prescribed.

The new Act makes
payment of holdback mandatory
after all liens that may be claimed against it have expired
or been satisfied, discharged, or otherwise provided for
under the legislation

Mandatory Release of Holdback

Payment of Basic Holdback
Subject to the delivery by the owner of a notice of non-
payment of holdback, each payer (contractor, subcontractor or
owner) is required to
pay the basic holdback
to discharge all
claims against the holdback where
all liens
that may have
been claimed against the holdback
have expired
or been
satisfied, discharged or otherwise provided for under this Act.
Payment of Finishing Holdback
Each payer (contractor, subcontractor or owner) is required to
pay the finishing holdback to discharge all claims against the
holdback where
all liens
that may have been claimed against
the holdback
have expired
or been satisfied, discharged or
otherwise provided for under this Act.

Non-Payment of Holdback

An owner can refuse to pay the holdback, or a portion
of it, only if they give notice to the contractor and they
publish a notice.
In the event this happens, a contractor can then refuse
to pay the holdback only if they refer the matter to
adjudication and they notify all subcontractors.
The process repeats for other payers in the
construction pyramid.

Non-Payment of Holdback

Under the new Act (s. 27.1), an owner may refuse to pay some or
all of the holdback amount owner is required to pay to a
contractor if:
Within
40 days
after the
publication
 of a certificate or declaration of
substantial performance
, the owner
publishes
 a notice specifying the
amount of holdback that it refuses to pay in the manner set out in the
regulations; and
The owner notifies the contractor of the publication of the notice.
Contractors or subcontractors may also refuse to pay some or all
of the holdback amounts owing if the owner or contractor refuses
to pay, the contractor or subcontractor refers the matter to
adjudication, and notice is provided to the parties that are not
being paid of that fact and that the matter is being referred to
adjudication.
Take-away, if the owner delivers a notice of non-payment of
holdback, the contractor will have to lien to preserve its lien rights
as against the holdback.

Non-Payment of Holdback

Must
publish
 a notice of non-payment of hold back
(Form 6):
Specifying the amount of the holdback the payer
refuses to pay.
No later than 40 days after:
publication of the certification or declaration of substantial
performance, or
if no certification or declaration of substantial performance is
published, the date on which the contract is completed,
abandoned or terminated.
Publishing to be done in the Daily Commercial News

Release of Holdback-Basic
From Owner to Contractor

Entitlement to Holdback

The basic holdback and notice holdback combined not
released by payor will be available to those who prove
valid lien.  You must have a lien to be entitled to
holdback.

In the event that there is sufficient holdback to see the
lien claims paid, they may be paid in full.

In the event that the holdback is less than the value of
all of the liens, the lien claimants will share pro-rata in
the holdback.

Early Release of Holdback - Annual

The new Act permits holdback to be paid out on an
annual basis for contracts with a completion schedule
that is longer than one year if:
The contract provides for it;
The contract price is at least $10 million; and
There are no preserved or perfected liens in respect of
the contract (or all liens have been satisfied,
discharged, or otherwise provided for under the
legislation)

Early Release of Holdback - Phased

The new Act also permits holdback to be paid out on a
phased basis if:
The contract provides for it and identifies each phase;
The contract price is at least $10 million (proposed
amount); and
There are no preserved or perfected liens in respect of
the contract (or all liens have been satisfied,
discharged, or otherwise provided for under the
legislation)

Early Release of Holdback
– Completion of Design Phase

The new Act permits holdback to be paid out at the
completion of the “design phase” if:
The contract provides for it; and
There are no preserved or perfected liens in respect of
the contract (or all liens have been satisfied,
discharged, or provided for under the legislation).

Priority of Liens

Rules surrounding priorities are complex.
There are circumstances where a lien can take priority
over a mortgage, but it is often limited.
It will depend on when your lien arose, when the
mortgage was registered, the type of mortgage, and
the date of mortgage advances.

Priority of Liens

BUILDING MORTGAGE
Mortgage taken by a mortgagee “with the intention to secure the financing of an
improvement, including refinance
Lien claimants have priority over a building mortgage to the extent of any shortfall in the
holdbacks the owner is obliged to retain under Part IV of the Act
PRIOR NON-BUILDING MORTGAGE:
Mortgage registered on title prior to the “time when the first lien arose in respect of this
improvement”.
Prior advances have priority to lien claims to the extent of the lesser of: (i) the value of
the premises at the time the first lien arose; and (ii) the total advanced before the start
of the project.  Subsequent advances retain priority unless a mortgagee has notice of a
lien.
SUBSEQUENT NON-BUILDING MORTGAGE
 Lien claimants will have priority over a subsequent mortgage to the extent of any
deficiency in holdbacks required to be kept by the owner under Part IV.  In addition to
priority over deficiencies in the holdback, lien claimants have priority to all advances
made in the face of notice of a claim for lien
HOME BUYER’S MORTGAGE
The priority rules in favour of lien claims do not apply to a home buyer’s mortgage

Section 39 Requests

 Section 39 Requests are an important and useful
tool contractors and subcontractors can use to
obtain information about:
the status of accounts above you in the pyramid;
information about the type of mortgages on title as well
as the amount and timing of advances made under the
mortgage
whether a Labour and Material Payment Bond has been
posted

Section 39 Requests

 Section 39 Requests are an important and useful
tool contractors and subcontractors can use to
obtain information about:
whether a contract has been substantially performed;
whether liens arise on a lot-by-lot basis
on subdivision or other multi-lot improvements,
subcontractors can (and should) request that the
owner or contractor advise, under s.39, whether or
not the contract provides that liens will arise on a
lot-by-lot basis

Section 39 Requests

Under the Construction Act, the scope of the
information that can be requested has been
expanded to include:
a much more detailed status of accounts from those
above you in the pyramid;
information about the sale of a home (given the
protection home buyers have against liens);
information about deemed subcontract completion
information on leases and the extent to which a landlord
is paying for the improvement
information about the phased release of holdback

Section 39 Requests

S. 39 information/documentation must be provided
within
21 days
of request

Trust Obligations

The Act imposes new duties on contractors and
subcontractors who are
trustees of trust funds
. Specifically,
trustees are required to deposit funds received on account
of their contract/subcontract price into a
bank account
in
the trustee’s name. They must maintain
written records
which detail the amounts received into and paid out of the
trust funds, any transfer made for the purposes of the trust
and other prescribed information. If more than one trust is
involved, the trust funds may be deposited into a single
account; however, the trustee must maintain
separate
records for each trust
.
Act has limited the trustee’s right to set-off. The Former Act
allowed a trustee to set-off money owed for any
outstanding debt claim or damages whether or not related
to the improvement.  The Act now restricts the right to
set
off
 to claims or damages
related to the specific
improvement
.

1) lien rights
2) holdbacks

Substantive change came into force on July 1, 2018:
longer lien timeframes;
new contract termination provisions
changes in holdback procedures;
new publication requirements;
an expanded scope of the s.39 request
re: the written notice of lien;
bonding on “public contracts”;
changes to what is lienable;
enhanced trust obligations;
re: the leasehold lien

Lien Modernization Recap

Can you contract out of the lien or holdback?

No, you cannot “contract out” of the Act.

The lien and holdback provisions apply to you no
matter what, so you cannot have provisions in a
contract that prevent a person from liening, or that
holdbacks are not required.

Even if contract does not say anything, the lien and
hold backs still apply

Business Days or Calendar Days?

Do days include weekends & holidays? Yes, when
counting the relevant days, you must count weekends
and holidays.  However, if your 60th day lands on a
weekend or holiday, then you are permitted to preserve
your lien on the following business day.

Publication Summary

Publication in “construction trade newspaper” –
Daily Commercial News
Provisions relating to publication of the following forms
under the Act:
o

Notice of Non-Payment of Holdback (Form 6)
o

Notice of Termination of Contract (Form 8)
o

Certificate of Substantial Performance (Form 9)
o

Notice of Intention to Register a Condominium in

accordance with the
Condominium Act, 1998

(Form 11)

Covid 19 and Construction Lien

On April 9, 2020, the Attorney General of Ontario amended
the Order in Council made under s. 7.1 of the Emergency
Management and Civil Protection Act (the “EMCPA”) that
had
suspended statutory limitation periods
and procedural
timelines effective as of
March 16, 2020
, such that the
suspension will no longer apply to the Construction Act.
The suspension of the limitation period and timelines was
lifted on
April 16th
, parties will have the same amount of
time to meet a deadline that had been remaining before the
suspension began on March 16, 2020.
The limitation period or period of time
resumes running
on
the date on which the temporary suspension ends and the
temporary suspension period shall not be counted.

Can you Contract Out of Adjudication?

Adjudication is available as a right. A Party to a construction contract can commence
an adjudication without the other Party’s consent.
Application despite other proceeding
13.5(5)  A party may refer a matter to adjudication under this Part even if the matter is
the subject of a court action or of an arbitration under the Arbitration Act, 1991,
unless the action or arbitration has been finally determined.
Adjudication procedures
13.6 (1)  An adjudication shall be conducted in accordance with the adjudication
procedures set out in this Part, the regulations, and, subject to subsection (2), any
additional adjudication procedures that may be set out in the contract or subcontract.
(2) Adjudication procedures set out in a contract or subcontract apply only to the
extent that they do not conflict with this Part and the regulations, and their
application is subject to the exercise of the adjudicator’s powers under section 13.12.
No waiver of rights
4  An agreement by any person who supplies services or materials to an improvement
that this Act does not apply to the person or that the remedies provided by it are not
available for the benefit of the person is void.

Practical Tips

Determine which version of the Construction Act applies to each of your
projects;
Ensure that accounting systems comply with new trust provisions;
Monitor
lien deadlines
and develop a
reminder system
;
Familiarize yourself with the
notice of non-payment
forms;
Monitor
holdback release dates
and deadlines for delivery of notices of
nonpayment;
Remember that if you receive a notice of non-payment of holdback from the
owner,  you must also serve a notice of
non-payment of holdback to your
subcontractors
within 3 days of receipt of the notice of non-payment of
holdback, otherwise you will need to pay the holdback or your
subcontractors;
Monitor
 the daily construction trade newspaper; and
Keep
documents organized
in the event that you receive a notice of
adjudication and have to respond promptly.

QUESTIONS?
QUESTIONS?
您有问题
您有问题
?
?
Slide Note
Embed
Share

In construction law, a construction lien gives a person the right to a claim upon the property they have improved. Learn about the basics of construction liens, amendments, and how they affect different contracts. Understand the implications of the new Construction Act and its key provisions like prompt payment and adjudication. Explore the Mortgagee Construction Pyramid and the process of when a lien arises.

  • Construction
  • Lien
  • Amendments
  • Property
  • Contracts

Uploaded on Feb 16, 2025 | 1 Views

Download Presentation

Please find below an Image/Link to download the presentation.

The content on the website is provided AS IS for your information and personal use only. It may not be sold, licensed, or shared on other websites without obtaining consent from the author.If you encounter any issues during the download, it is possible that the publisher has removed the file from their server.

You are allowed to download the files provided on this website for personal or commercial use, subject to the condition that they are used lawfully. All files are the property of their respective owners.

The content on the website is provided AS IS for your information and personal use only. It may not be sold, licensed, or shared on other websites without obtaining consent from the author.

E N D

Presentation Transcript

  1. CONSTRUCTION LIEN CONSTRUCTION LIEN BASICS BASICS 2020 5 31

  2. 21 20 (IPO, RTO, CPC, QT)

  3. 1989 , , 2000 (21 ) 2000-2002 2002 2006 2007-2019 2019 3

  4. Construction Act (formerly Construction Lien Act) On December 12, 2017, Bill 142, Construction Lien Amendment Act, 2017 received Royal Assent. The Bill amends the ConstructionLien Act (Ontario), and renamed it the Construction Act. The substantive amendments modernizing the new Act also came into force on July 1, 2018. Other amendments including the introduction of prompt payment, adjudication, regulations and forms came into force on October 1, 2019.

  5. Which Act Applies to me? The new regime also will not apply to prime contracts entered into on or after July 1, 2018 or October 1, 2019, if a procurement process for the improvement that is the subject of the contract was commenced by the owner before that day. This non- application of this provision holds true regardless of when any subcontracts under the prime contract were entered into. Generally speaking, if your prime contract was entered into: before July 1, 2018, your project is governed by the previous, pre- amendment version of the Act, being the Construction Lien Act. between July 1, 2018 and September 30, 2019 inclusive, your project is governed by the lien modernization provisions of the new Construction Act, but not the prompt payment or adjudication of the new Act. on or after October 1, 2019, your project is governed by the new Construction Act, including the prompt payment and adjudication provisions

  6. Mortgagee Construction Pyramid Can include a Landlord and/or Tenant Owner Includes Engineer or Architect having direct contract with Owner General Contractor Subcontractor Sub-Subcontractor Workers, Equipment Rentals, Material Suppliers

  7. What is a construction lien? Section 14(1) of the Act provides that, a person who supplies services or materials to an improvement for an owner, contractor or subcontractor, has a lien upon the interest of the owner in the premises improved for the price of those services or materials.

  8. When does a lien arise? The lien creates an interest in the land in favour of those who supply materials or services, thereby creating security. This operates to prevent the owner from receiving improved land without making payment for the improvement. If the lien is unsatisfied, you can take private owner s property, sell it and payback the lien. This is especially important to subcontractors who have no direct contract with the owner (and, therefore, no right to bring an action for payment under a contract). A person s lien arises and takes effect when the person first supplies services or materials to the improvement.

  9. Who can lien? Any person who is under a contract and has supplied services and/or materials to an improvement has a right to lien. Pretty well all persons working on a construction project will have a right to lien, including suppliers of rental equipment, architects, and those who provide design services.

  10. What can you lien? The Act makes reference to an improvement to set out what type of property and what type of work can be liened. An improvement includes the alteration of and/or the addition to the property. This is a broad definition and encapsulates most construction activity. It also includes the construction and installation of industrial, mechanical, or electrical equipment, when that equipment is essential to the regular use of that property. Affixed machinery in a plant such as an automotive assembly plant would fall within the definition of an improvement. It is also possible to lien for work done for a capital repair. This type of work is for work done to extend the economic life of a building or structure. It has to be noted that this does not include just any type of repair, and does not include preventative maintenance.

  11. What is a Capital Repair? a capital repair to land is any repair intended to extend the normal economic life of the land or of any building, structure or works on the land, or to improve the value or productivity of the land, building, structure or works, but does not include maintenance work performed in order to prevent the normal deterioration of the land, building, structure or works or to maintain the land, building, structure or works in a normal, functional state.

  12. What services can you lien for? Supply of services can include: engineering services and architectural services rental of equipment security services to a construction site services of estimating and job supervision.

  13. What is the value of your lien? The Act gives you the ability to lien for the price of services and materials that you provided to the project. Price is a defined term and means: the amount agreed between the parties, or if there is no agreement on the amount, then the market value of the work; AND any direct costs incurred as a result of a delay not caused by provider

  14. What does direct cost really mean? Direct Costs are reasonable costs of performing the contract or subcontract during the extended period of time, including: Costs related to the additional supply of services or materials (including equipment rentals); Insurance and surety bond premiums; and Costs resulting from seasonal conditions; that, but for the extension, would not have been incurred, but do not include indirect damages suffered as a result, such as loss of profit, productivity or opportunity, or any head office overhead costs.

  15. What is the value of your lien? You are not entitled to lien for interest on the amount you are owed, nor can you lien for any indirect costs associated with your claim. You are still at liberty to assert a claim for the amounts as part of a claim for damages under regular contract law. You should never exaggerate the value of your lien. The Act contains specific provisions about an exaggerated lien and that you could be liable for the costs that someone incurs as a result of the exaggerated lien.

  16. Written Notice of a lien The first step which you may wish to consider prior to the actual registration of a lien is a written notice of lien. Typically this can be used in the event that your lien rights do not expire for a period of time that will permit the written notice to have time to be effective. A written notice of a lien is completed by personally serving a prescribed form (Form 1) on the person(s) above you in the construction pyramid. Upon receipt of a written notice of lien, the payer, i.e. the person above you in the construction pyramid, must retain the full amount in dispute. Written notice of lien also affects priority of lien against mortgages. Furthermore, if you are still unpaid after the written notice of lien is sent, you still need to register your lien on title or you will lose your lien rights.

  17. FORM 1 WRITTEN NOTICE OF LIEN UNDER SUBSECTION 1(1) OF THE ACT Construction Act Name of person having a lien: Address for service: Name of payer: Address: Name of person to whom person having a lien supplied services or materials: Address: Time within which services or materials were supplied: to (date supply commenced) (date of most recent supply) Short description of services or materials that have been supplied: Description of premises: Contract price or subcontract price: $ Amount claimed as owing in respect of services or materials that have been supplied: $ Date: (signature of person having a lien)

  18. How do you register a lien? The act of placing a lien on title is known as preserving your lien. It is the registration of your lien on title. There is a specific form Form 12-Claim for Lien that has to be completed, with information such as: your proper legal name; who you contracted with; the name of the owner; the time in which you supplied to the project; your total contract value; how much you are owed; what type of work you supplied; This can be done by visiting the local Land Registry Office in the county of the project. Lawyers have access to a program called Teraview which allows them to register your lien electronically.

  19. FORM 12 CLAIM FOR LIEN UNDER SECTION 34 OF THE ACT Construction Act Name of lien claimant: (In the case of a claim on behalf of a worker by a workers trust fund, the name of the trustee) Address for service: Name of owner: Address: Name of person to whom lien claimant supplied services or materials: Address: Time within which services or materials were supplied: from to (date supply commenced) (date of most recent supply) Short description of services or materials that have been supplied: Contract price or subcontract price: $ Amount claimed as owing in respect of services or materials that have been supplied: $ (Use A where the lien attaches to the premises; use B where the lien does not attach to the premises) A. The lien claimant (if claimant is personal representative or assignee, this must be stated) claims a lien against the interest of every person identified above as an owner of the premises described in Schedule A to this claim for lien. B. The lien claimant (if claimant is personal representative or assignee, this must be stated) claims a charge against the holdbacks required to be retained under the Act and any additional amount owed by a payer to the contractor or any subcontractor whose contract or subcontract was in whole or in part performed by the services or materials that have been supplied by the lien claimant in relation to the premises at: (address or other identification of the location of the premises) Date: (signature of claimant or agent) SCHEDULE A To the claim for lien of Description of premises: (Where the lien attaches to the premises, provide a description of the premises and address sufficient for registration under the Land Titles Act or the Registry Act, as the case may be. Where the lien does not attach to the premises, the address or other identification of the premises)

  20. When can you lien? Once you have supplied materials or services to site, you have a lien. You can register a lien even though the money is not yet due and owing and if you have yet to render an invoice. In theory, you could register a lien every day you are on site even though you have not invoiced for the work. In practice, that is a terrible idea.

  21. When can you lien? By when do you have to preserve lien? There are strict timelines that are outlined in the Act. If you miss a deadline, you will lose your right to lien and may not see any payment. Before you start to count days, you first have to determine whether you are a contractor or a subcontractor . A contractor has a contract directly with the owner. A subcontractor is anyone with a contract with the contractor, or with another subcontractor (i.e. a supplier).

  22. When can you lien? Contractor Under Prior Construction Lien Act Under New Construction Act 45 days following: 60 days following: the completion or abandonment of the Contract, or the completion or abandonment or termination of the Contract, from the publication of a Certificate of Substantial Performance or from the publication of a Certificate of Substantial Performance, whichever is earlier whichever is earlier

  23. When can you lien? Lien of a Contractor Section 31 of the Act has been amended to increase the deadline to preserve a lien from 45 days to 60 days. Termination of a contract has been added as a trigger in determining the timeline for preserving a lien. If a contract is terminated, a Notice of Termination under Subsection 31(6) (Form 8) must be published by the owner, contractor or a person whose lien is subject to expiry.

  24. When can you lien? Subcontractor Under Prior Construction Lien Act Under New Construction Act 45 days following last day of supply; or 60 days following last day of supply; or 45 days following the date the contract was completed, abandoned 60 days following the date the contract was completed, abandoned, or terminated 45 days following the publication of a certificate of substantial performance for the contract, 60 days following the publication of a certificate of substantial performance for the contract, 45 days following the certification of completion for subcontract 60 days following the certification of completion for subcontract where the services or materials were supplied under or in respect of that subcontract which ever is earlier which ever is earlier

  25. When can you lien? Lien of a Subcontractor A subcontractor, or any other person, must register its lien within 60 days of the earlier of: the date upon which the certificate of substantial performance is published (if there is one); the date that they last supply services or materials to the project; the date that the contract was completed, abandoned, or terminated; and the date that the subcontract is certified to be complete (this rarely occurs).

  26. What if you start an adjudication? Adjudication and expiry (10) If the matter that is the subject of a lien that has not expired is also a matter that is the subject of an adjudication under Part II.1, the lien is deemed, for the purposes of this section only, to have expired on the later of the date on which the lien would expire under section 31 and the conclusion of the 45-day period next following the receipt by the adjudicator of documents under section 13.11.

  27. Perfection of Lien Once the lien is registered, you will have to perfect the lien by starting a court action. This can now be done in Small Claims Court if the value of the lien is less than the $25,000 limit. The claim is issued in the Superior Court, and it has to be done within 90 days of the last day in which you could have registered your lien. After the statement of claim is issued, a certificate of action also has to be issued, and then registered on title of the property. If you fail to commence the court action, or fail to register the certificate of action, your lien will expire and it cannot be enforced.

  28. Maintaining the Lien Once the court action is commenced, it proceeds through the litigation process similar to any other lawsuit. There are some modifications to the process that do differ from an ordinary lawsuit. There is no automatic disclosure of documents, no right to examinations for discovery, and no mandatory mediation. However, it is usually agreed between the parties that these steps will take place, depending on the nature of the matter. In order to maintain your lien, you will have to take steps to advance the court action. Within two years of starting the claim, you will have to ensure that it is set down for trial or that there has been an Order directing a trial. If this is not done, your lien will expire.

  29. Lien Process By Contractor STARTING POINT: completion, abandonment or termination of the Contract or publication of a Certificate of Substantial Performance Serve Written Notice of Lien -Payor must keep notice holdback in addition to statutory holdback 60 days from starting point to lien Register Claim of Lien on Title 90 days from lien expiry date to perfect the lien -Start an action in court and obtain a certificate of action 2 years to set action down for trial

  30. Lien Process From Sub-Contractor STARTING POINT: Earlier of: date of last supply of services or materials date contract is completed, abandoned or terminated publication of a Certificate of Substantial Performance date a subcontract is certified to be completed Serve Written Notice of Lien -Payor must keep notice holdback in addition to statutory holdback 60 days from starting point to lien Register Claim of Lien on Title 90 days from lien expiry date to perfect the lien -Start an action in court and obtain a certificate of action 2 years to set action down for trial

  31. Certificate of Substantial Performance Not all construction projects will carry with them a requirement for a certificate of substantial performance ( CSP ). A CSP can be published by a payment certifier (i.e. architect) if there is one, or by the owner and contractor. The CSP serves as notice that the project is almost complete, and acts to cut off a significant portion of lien rights.

  32. Certificate of Substantial Performance A CSP can only validly be published when two criteria are met: The improvement is ready for use ; AND Where the improvement to be made is capable of completion, or where there is a known defect, correction, at a cost of not more than: OLD DEFINITION: 3% of the first $500,000 of the contract price; 2% of the next $500,000 of the contract price, and 1% of the balance NEW DEFINITION: 3% of the first $1 million of the contract price; 2% of the next $1 million of the contract price, and 1% of the balance

  33. Completion or Deemed Completion A contract is deemed completed when the price of completion is not more than the lesser of: 1% of the contract price; and $1,000 (old Act)/$5,000 (new Act)

  34. Termination of Contract In the event that a contract or a subcontract is terminated, a notice is required to be published. If a contract is terminated, either the owner or the contractor or other person whose lien is subject to expiry shall publish a notice of the termination (Form 8) and, for the purposes of this section, the date on which the contract is terminated is the termination date specified in the notice for the contract. Daily Commercial News

  35. FORM 8 NOTICE OF TERMINATION UNDER SUBSECTION 31(6) OF THE ACT Construction Act (name of owner, contractor or other person whose lien is subject to expiry) Description of the premises: (Use A or B, whichever is appropriate) A. Identification of premises for preservation of liens: (if a lien attaches to the premises, a legal description of the premises, including all property identifier numbers and addresses for the premises) B. Office to which claim for lien must be given to preserve lien: (if the lien does not attach to the premises, the name and address of the person or body to whom the claim for lien must be given) Termination of contract or subcontract: The contract or subcontract with dated the (name of contractor or subcontractor) , 20 , is terminated on the day of , 20 . Date: (owner, contractor or other person)

  36. Declaration of Last Supply When there is no certification of substantial performance of the contract, or for services or materials supplied after the date of the substantial performance, the 60-day period starts on, the date on which the person last supplied services or materials to the improvement, the date the contract is completed, abandoned or terminated, and the date a subcontract is certified to be completed, where the services or materials were supplied under or in respect of that subcontract.

  37. FORM 7 DECLARATION OF LAST SUPPLY UNDER SUBSECTION 31(5) OF THE ACT Construction Act , (name of supplier) a supplier of services or materials to an improvement being made to: , (address of premises) declares that: 1. The following services or materials were supplied: . (description of services or materials) 2. These services or materials were supplied under a contract (or subcontract) with (name of payer) dated the day of , 20 . 3. The last supply of services or materials made by the supplier to the improvement under contract (or subcontract) was made on . (date of last supply) 4. No further services or materials will be supplied under the contract (or subcontract). Declared before me at the of in the of (supplier) on the day of , 20 A Commissioner, etc.

  38. Can you lien a public road or a street? Yes, although a lien does not attach to title in the same way. Rather than register a lien on title you preserve it by providing certain people with the lien (clerk in case of municipality).

  39. Can you lien government property? Federal Federal government property cannot have liens enforced against them. The Federal Government takes the position that the Act has no application at all to its property. Generally, most Federal projects are protected by Labour and Material Payment Bonds, which can be utilized by trades and suppliers to obtain payment.

  40. Can you lien government property? Provincial Provincial government property is subject to the Act. The lien is preserved by providing the government body in charge of the project with the claim for lien. The property is never sold to enforce the lien, rather the lien acts as a mechanism to be entitled to share in the holdback.

  41. Can you lien government property? Municipal Municipal property is subject to the Act. The lien is preserved by providing the clerk of the municipality with a copy of the Claim for Lien. Similarly, the property is never sold to enforce the lien, rather the lien acts as a mechanism to be entitled to share in the holdback.

  42. What about landlords? Even where the landlord does not meet the definition of Owner, the Act now provides lien claimants with potential lien rights against the landlord: if the lease contains a leasehold improvement clause that requires the landlord to pay a certain amount towards the improvement, the landlord is liable to the lien claimants for 10% of that amount This means if the landlord funds an improvement through a tenant improvement allowance, or rent abatement or other tenant inducement, contractors performing the work will automatically have a lien right against the landlord for the 10% a s. 39 request is available to determine if there is such a leasehold improvement clause

  43. What about landlords? The landlord can also be fully liable for the lien amount (ie. the price of services or materials supplied by the contractor) if it meets the criteria set out in the definition of "owner". The landlord is deemed to be an "owner" under the New Act if: the landlord has an interest in the improved premises; the landlord requested the improvement; and the improvement was made on the landlord's credit or behalf, or with the landlord's privity or consent, or for the landlord's direct benefit. If each of these criteria is met, the contractor may seek full payment from the landlord (as "owner") (to the extent that the contractor is not paid) using a construction lien, regardless of whether there is a direct contract between the contractor and landlord.

  44. What about condos? Unit Owner Condo Corp Unit Common Elements (Landscaped areas, parking lots, guest suites, recreational facilities, hallways, elevators, foyers, roofs, etc.) Parking (if Pinned and Transferred to Owner) Common Elements Under Exclusive Use (Parking, locker, balcony, front or backyard, rooftop terrace, etc.) Locker (If Pinned and Transferred to Owner)

  45. Liening a Condo Unit Same way as registering a lien on other non-condo property owners Lien is against the unit but not against the common elements . Lien can be against any lands enjoyed with the unit. So if unit owner owns parking and/or locker, can also lien parking and/or locker. When perfecting the lien, the Statement of Claim will name only the individual registered owner of the unit and not the other unit holders or the condominium corporation

  46. Liening Condo Comment Elements? Unlike a unit , the common elements are not individually owned and do not have a unique PIN associated with them. As such, registering a lien against the common elements requires a lien claimant to list all of the units in the Properties section of the claim for lien thereby liening each unit in the condominium for its proportionate share in the common elements. A lien claimant who wants to register a lien relating to an improvement to the common elements must give notice of the lien s to the condominium corp. and to every unit owner or every owner of a common elements condominium corporation. When perfecting the lien by commencing an action, it is not necessary to name every unit holder as a defendant in the Statement of Claim. Under the Condominium Act, it is sufficient to name only the condo corp. Condominium unit owners can remove liens from their unit that are related to improvements to the common elements, by making a motion to court paying his portion of the lien to court.

  47. Liening Condo Corp before registration? Under the Construction Act, an owner does not include a home buyer . Thus, if a lien is registered against the premises after the condominium declaration and description has been registered and title to the units and common elements have been transferred from the developer to individual owners, the lien will most certainly be defeated. The answer: s. 33.1 of the Construction Act which requires that notice be published that a project is on the cusp of being registered as a condominium. Notice is Form 11 and to be published before condo registration Lien claiments will then make sure they register the lien before the condo registration.

  48. FORM 11 NOTICE OF INTENTION TO REGISTER A CONDOMINIUM IN ACCORDANCE WITH THE CONDOMINIUM ACT, 1998 UNDER SECTION 33.1 OF THE ACT Construction Act Name of declarant: Address for service: Concise overview of the land (include reference to the lot and plan number and the parcel number(s)): (Complete for each contractor who supplied services or materials to an improvement during the 90-day period preceding the date on which the description is to be submitted for approval under subsection 9 (3) of the Condominium Act, 1998) Name of contractor: Address: Address for service (if known): (Add the name, address and address for service of other contractors if applicable)

  49. How do you get a lien off title? If you are unable to come to a resolution, it may be necessary to have the lien removed from title. You can bring a motion to court, without telling the lien claimant, so long as you pay into court cash, a lien bond, or a letter of credit in the amount of the lien, plus 25% or $250,000, whichever is less, as security for costs. You will obtain a court order that you register on title of the property that removes the lien, and the court action proceeds. The court action proceeds with money in court being recoverable by the lien claimant at the end of the day. If a lien is out of time or is otherwise invalid, you can bring a motion to declare that the lien is invalid. If you are successful, the lien is deleted. However, this does not prevent a breach of contract claim from continuing.

  50. Can you extend your lien rights? What is your last day on site? Can you attend back on site and hammer a nail in to extend lien rights? Unless you are returning to the project to complete some significant contract work, your lien rights will expire. You cannot return to the site and supply a drywall screw in the hopes of reviving your lien rights. Furthermore, you cannot claim your last day of supply was when you returned to complete deficiency work.

Related

More Related Content

giItT1WQy@!-/#giItT1WQy@!-/#giItT1WQy@!-/#giItT1WQy@!-/#giItT1WQy@!-/#giItT1WQy@!-/#giItT1WQy@!-/#giItT1WQy@!-/#giItT1WQy@!-/#giItT1WQy@!-/#
