Hazardous Waste Management Program Analysis FY 2018-19

undefined
Hazardous Waste Management Program
Permitting Division
Workload Analysis for FY 2018-19
October 26, 2020
Prepared by:
1
Slide
 Intentionally Left Blank
SLIDE INTENTIONALLY LEFT BLANK
2
Purpose
This workload analysis provides information on how the
Permitting Division:
Uses its current resources to meet legislative mandates
and achieve its mission.
Tracks and manages projects to promote efficiency and
effectiveness.
Produces outcomes to meet its mission.
Identifies risks to program performance and
effectiveness.
3
undefined
Mission Statements
“DTSC’s mission is to protect California’s people, communities, and environment
from toxic substances, to enhance economic vitality by restoring contaminated
land, and to compel manufacturers to make safer consumer products.”

                California Department of Toxic Substances Control

  Mission Statement
“The Permitting Division’s mission is to protect Californians and the environment
from toxic harm by making timely, enforceable, and protective permit
decisions for the operation of hazardous waste facilities in accordance
with all applicable laws and sound science.”

             Hazardous Waste Management Program

Permitting Division

Mission Statement
4
undefined
To protect Californians, the Permitting Division oversees hazardous waste facilities’ design and operation
(Page 1 of 2)
BACKGROUND
The Permitting Division (Permitting) in DTSC’s Hazardous Waste Management Program (HWMP) makes permitting
decisions and oversees operating, closure, and post-closure activities at 103 facilities that treat, store, and dispose of
hazardous waste within California. Appropriate decisions and effective permits protect California’s residents from
hazardous wastes that pose a threat to public health and the environment.
Permitting is also tasked with overseeing the adequacy of financial assurance for sites under DTSC’s jurisdiction to protect
California’s residents from toxic harm, and to avoid burdening the California taxpayers with the cost for such efforts.
Permitting evaluates every decision regarding the operation of a hazardous waste facility in accordance with the California
Environmental Quality Act (CEQA) and performs CEQA analysis to support decisions of other DTSC programs. Permitting
also coordinates requests from California government entities to review CEQA documents for hazardous waste impacts
related to their projects.
Senate Bill (SB) 673
(Lara, Chapter 611, Statutes of 2015)
 r
equires DTSC to establish and implement new permitting
criteria to improve enforceability, transparency, and equity in permit decisions. Permitting staff led the regulation
development and is now implementing 5 new permitting criteria, with support from DTSC’s Statewide Enforcement and
Legal staff.  Permitting is now leading the development of additional SB 673 regulations to establish criteria for
consideration of cumulative impacts and community vulnerability in permitting decisions. These SB 673 Track 2
regulations are expected to be promulgated in 2021 for implementation in 2022.
Since SB 839
(Committee on Budget and Fiscal Review, Chapter 340, Statutes of 2016)
 was signed into law, all permit
applications received after April 1, 2016 are subject to Fee-for-Service (FFS). DTSC now recovers the cost of reviewing
permit applications and making permit decisions.
The Permitting Division has undergone transformation in recent years, adopting a culture of continuous improvement,
accountability, and improved transparency. Since 2014, DTSC has implemented several process improvements, including
permitting enhancements and Lean 6-Sigma (L6S) efforts. L6S projects have reduced the time required to make permit
decisions while increasing the quality of application review and permit decisions. The increased efficiency frees Permitting
staff to perform more comprehensive and consistent reviews of ongoing permitted activities. Permitting continues to
improve by determining the next most significant opportunity to reduce time in its processes without sacrificing quality or
public input.
5
undefined
To protect Californians, the Permitting Division oversees hazardous waste facilities’ design and operation
(Page 2 of 2)
BACKGROUND
In 2018-19, Permitting operated with a budget of approximately $13 million and 67.5 positions (63.5 positions were
analyzed, as unfunded and executive positions were excluded). Permitting is funded by the Hazardous Waste Control
Account (HWCA), Fee-for-Service revenues deposited in HWCA, U.S. EPA Resource Conservation and Recovery Act
(RCRA) Grant resources deposited in the Federal Trust Fund, and General Fund.
In FY 2018-19 Permitting:
Issued 18 permit decisions for renewals, Class 2, and Class 3 permit modifications, many of which are in environmental
justice communities. These are communities that are most vulnerable and impacted by multiple sources of pollution.
Performed permit maintenance activities, including review of groundwater monitoring reports, air monitoring studies,
and closure cost estimates.
Reviewed plans, oversaw field activities, and reviewed reports related to closure of 12 facilities.
Performed and implemented 4 process improvement initiatives to make the permitting process more efficient,
protective, and transparent.
P
e
r
m
i
t
t
i
n
g

r
e
c
e
i
v
e
s

i
t
s

a
u
t
h
o
r
i
t
y

f
r
o
m

t
h
e
s
e

3

c
o
d
e
s
:
6
undefined
Overview of HWMP’s Permitting Division
RESOURCES
Permitting Division (FY 2018-19)
SOURCES:

 DTSC HR
NOTES:    (1)  The number of positions used as the basis for the workload analysis may
not align with the 2019-20 Salary and Wages Supplement. Unfunded and other specific
positions were not included.
(2)  Management office includes management and direct reports.
Key Observations
DTSC is mandated by statute to:
Issue permit decisions for hazardous waste management facilities in California
(HSC § 25200(a)).
Oversee closure of hazardous waste management facilities (HSC §25247).
Establish regulations and standards to establish sufficient financial assurance for
cleanup and closure at permitted facilities (HSC § 25245(a)).
Evaluate environmental impacts of discretionary projects in compliance with
CEQA (PRC § 21000(g)).
Adopt permitting criteria to consider facility compliance history among other
criteria (HSC § 25200.21). Recently, SB 673 required DTSC to evaluate and
quantify a facility’s compliance history, cumulative impacts, and community
vulnerability during a permit decision.
Develop and implement programmatic reforms to improve protectiveness,
timeliness, legal defensibility, and enforceability of the permitting program (HSC §
25200.23).
DTSC is authorized to perform 5-year reviews of the estimated costs to implement
closure and post-closure activities at permitted facilities.
Permitting offices are in Sacramento, Berkeley, and Chatsworth. 6 units within
Permitting include dedicated technical project managers and associated support
staff. Scientist, Engineer, and Environmental Planner classifications comprise over
81% of the division.
Permitting’s Financial Responsibility (FR) unit assures that sufficient funds are set
aside and available for future closure, post-closure, operations and maintenance,
corrective action, and/or liability.
The CEQA unit analyzes and mitigates environmental impacts associated with
project decisions.
7
undefined
Technical classifications are fundamental to Permitting’s success
RESOURCES
Permitting Division Staff Hours
1,2
 by Classification (FY 2018-19)
SOURCES: DTSC TEMPO Time Data
NOTES:      (1) TEMPO showed a senior engineering geologist under Permitting’s reporting structure in error and has since been
corrected. These hours are not included in the chart and totaled 525 hours (including leave). The following slides
include these hours.
                    (2) Leave is not included in this chart. Leave, including state and federal holidays, amounts to 19,460 hours.
Key Observations
Permitting is primarily staffed with scientists
and engineers, whose expertise is
necessary to interpret and implement
hazardous waste management regulations
for permitted facilities. Activities require
knowledge of hazardous waste
management laws, CEQA, financial
assurance, and contaminants as they relate
to applications, closures, and technical
consultation requests. 81% of hours are
completed by the scientist, planner, and
engineer classifications.
4% of hours are dedicated to supervisory
positions.
The Permitting project managers review the
design and operation of permitted facilities to
identify deficiencies and deviations from the
comprehensive permitting standards and
requirements.
Permitting’s analysts and office technicians
complete crucial administrative work for the
program. This includes supporting permit
decisions, inputting and monitoring data
management systems, and processing and
tracking contracts.
8
undefined
65 percent of division time goes to technical work on permitting projects, CEQA, financial responsibility,
consultation and outreach, corrective action and cleanup support, and SB 673
RESOURCES
Permitting Division Hours
1
 by Work Category (FY 2018-19)
SOURCES: DTSC TEMPO Time Data
NOTES:       (1) Leave is not shown in this chart. Leave, including state and federal holidays, amounts to 19,460 hours and 16% of
hours. Percentages in the chart take leave into account.
Key Observations
Permitting completes permitting projects, CEQA
evaluations, financial responsibility reviews,
administrative activities, consultation and
outreach, and program development.
Approximately 50% of hours support facility
permitting activities. This is work from Permitting,
CEQA, and FR unit staff dedicated to permit
activities, including Permitting unit supervision
hours for technical work in permit reviews.
DTSC coordination is 15% of hours. Consultation
and outreach includes records requests,
rulemaking review and development, and data
management tasks.
19% of hours are devoted to administrative
activities and is time required to maintain
operations. Specific tasks include statutorily
mandated reforms and L6S projects.
SB 673 hours represent the 5 new permitting
criteria which updated financial assurance rules,
employee training requirements, compliance
history evaluation, community involvement
profiles, and health risk assessments.
SB 673 Track 2 will require review of cumulative
impacts to be considered in a permit decision
which will place additional demands on
Permitting staff.
9
undefined
70 percent of Permitting staff hours are for permitting projects and program development
RESOURCES
Permitting Units’ Hours
1,2
 by Work Category (FY 2018-19)
NOTES:
(1) Activity IDs and Project IDs were grouped into larger work categories in collaboration with program staff.
                    (2) Leave is not included in the chart above. Percentages do not include leave.
Key Observations
The bulk of hours include reviewing applications
and operations for compliance with permitting
standards and requirements and managing Fee-
for-Service (FFS). FFS work includes work on
permit applications received after April 1, 2016.
DTSC FFS documentation and procedures are
required to comply with HSC §§ 25206.1-25206.4
when seeking cost reimbursement for processing
applications.
18% of hours were for administrative activities
including statutorily mandated training, health and
safety compliance, hiring, budget management,
database management, strategic planning, staff
meetings, and other tasks.
5% of hours represent consultation and outreach,
including maintenance of the EnviroStor data
management system, developing and delivering
training, and consultative work with the HWMP
and the public on hazardous waste permitting
issues.
SB 673 represents 3% of Permitting units’ hours.
After Statewide Enforcement determines violations
scoring tiers, Permitting is mandated to implement
special facility requirements based on tiers. As SB
673 workload shifts onto Permitting, associated
hours are expected to significantly increase.
2% of hours involved corrective action activities
and supporting Site Mitigation and Restoration
Program (Cleanup) to mitigate risk at a post-
closure or closure site per HSC § 25247.

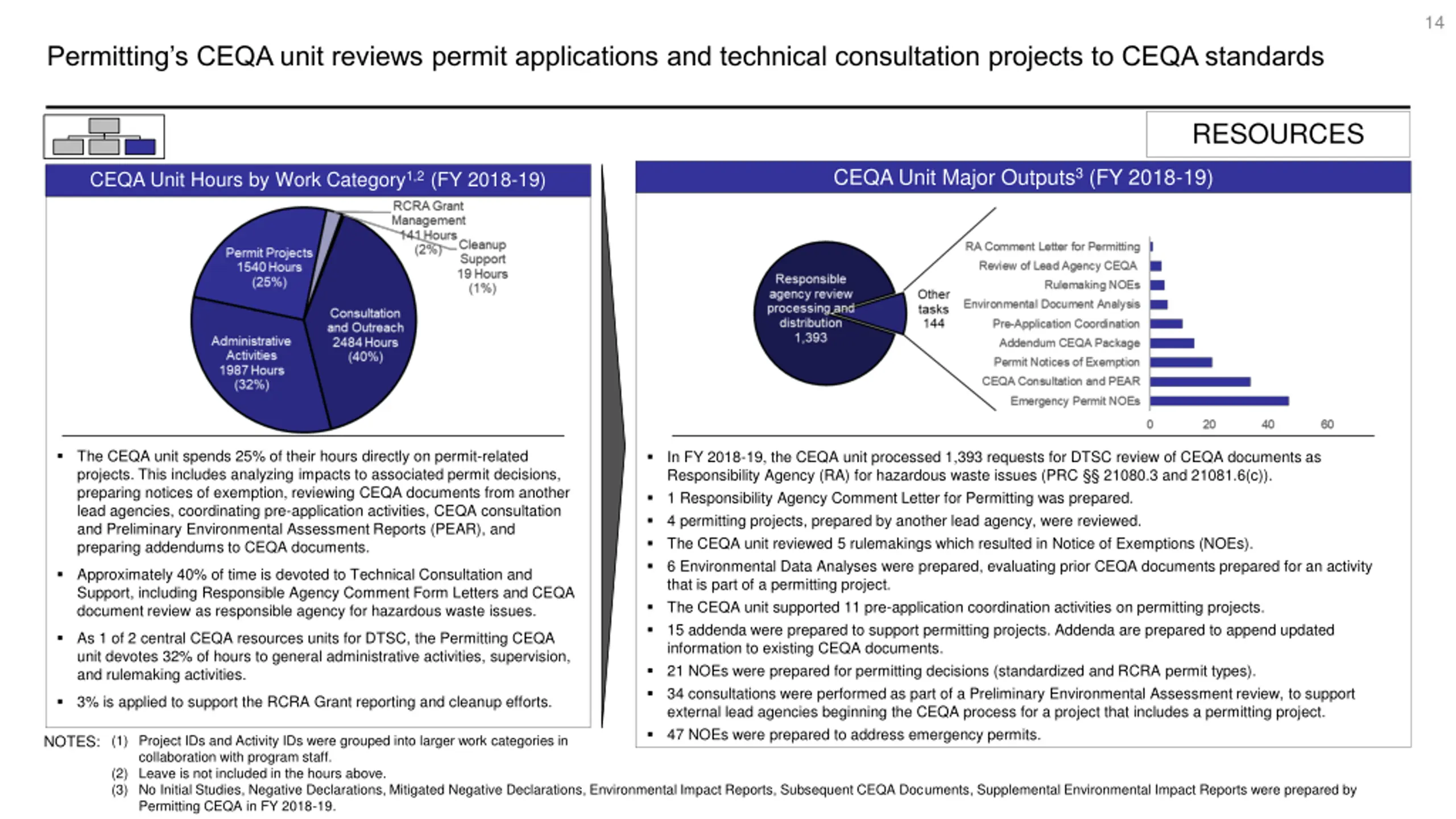

10
undefined
Permitting completed 18 permit decisions in FY 2018-19
RESOURCES
Permit Completions by Timeframe
1
 (FY 2018-19)
The permit application process spans multiple years and involves multiple programs. The 5-phase process consists of:
Pre-Application Period: DTSC meets with facilities as part of a pre-application meeting and establishes clear expectations for the permitting process.
Administrative Review: DTSC uses an Administrative Review Checklist to determine whether each required item is provided in the application, not provided, or not applicable.
Technical Review: DTSC uses a Technical Review Checklist to evaluate whether the permit application meets all of the standards for hazardous waste facilities specified in regulation.
Public Comment Period: DTSC provides public notice of a draft decision; reviews and considers each comment received during the public comment period; and prepares responses to comments.
Permit Decision: DTSC issues a final permit decision, considering all public comments received.
On average, permit decisions spanned 2.6 years and required 1,295 staff hours. Prior to process improvements, permit renewal decisions spanned 4.5 years on average.
5 Class 2 modifications were completed during this period. On average, Class 2 modifications spanned 1 year and required 1,136 staff hours. 2 modifications were completed for Phibro-Tech Inc.
3 Class 3 modifications were completed during this period. On average, Class 3 modifications spanned 1.5 years and required 710 staff hours.
Permitting completed a total of 10 renewals. The average renewal spanned approximately 2.6 years and required 1,567 staff hours. 1 renewal for a particularly large-scale and complex permit, spanned 5 years and began prior to Lean
6-Sigma initiatives.
Hours varied depending on the complexity and specific requirements of each project.
11
undefined
Permitting administers permit modifications, oversees closures, performs special projects, and reviews
closure cost estimates that are not covered by Fee-for-Service
RESOURCES
Major Permitting Unit Tasks Not Covered by FFS  (FY 2018-19)
Key Observations
Work not reimbursed by DTSC’s FFS revenues includes
activities for oversight of facility closures, review and
evaluation of reports prepared by permitted facilities to
demonstrate ongoing protective operations, and support to
Statewide Enforcement. Permitting performed a total of
328 of these major activities in FY 2018-19.
Permitting performed 182 permit maintenance tasks.
These include review of deliverables submitted to fulfill
permit conditions as part of permit maintenance.
Permitting completed 38 Class 1 and 9 Class 1* (“class
one star”) permit modifications, allowing facilities to make
minor modifications to their operations. Class 1 and Class
1* modifications are the simplest of modifications and are
not subject to FFS.
40 emergency permits were issued. Facilities request
emergency permits to manage waste posing an immediate
endangerment to human health or the environment.
12 closures were ongoing during FY 2018-19, with 8
closures completed. Closure oversight is essential so that
contamination issues are resolved.
15 5-year financial assurance closure cost reviews were
completed to confirm that financial assurance
mechanisms were adequate to cover the cost of future
cleanup.
Permitting personnel completed 18 special projects and
have 14 more ongoing, including projects to implement
statutorily mandated reforms, evaluate complex industries
such as metal shredders, and to develop new regulations
to improve protections in vulnerable communities.
12
undefined
Permitting’s Financial Responsibility unit monitors funding adequacy for facility closure and cleanup activities
RESOURCES
Financial Responsibility Unit Hours
1,2
 by Work Category (FY 2018-19)
The Financial Responsibility (FR) unit reviews and assesses the adequacy of financial
assurance mechanisms for Permitting, Statewide Enforcement, and Cleanup. Financial
assurance is essential to oversee that adequate resources are available to perform closure and
cleanup in a timely manner to protect California’s residents from toxic harm.
41% of the FR unit’s hours were devoted to core functions of supporting permit decisions,
implementing new SB 673 financial assurance (FA) requirements, evaluating financial
responsibility, and providing support to Statewide Enforcement and the Cleanup Program.
Note that supervisory time in the FR unit includes time spent on technical review of financial
analyses performed by staff.
30% of time is spent on administrative functions including time spent logging and filing financial
mechanisms for approximately 450 sites. The FR unit receives over 600 documents per year
that require administrative and data management tasks. In addition, the supervisor and financial
analysts receive general inquiries from facilities which cannot be charged directly to a site.
Financial Responsibility Unit Major Outputs (FY 2018-19)
The FR unit reviews and monitors $2.5 billion FA mechanisms for approximately 450 sites
under DTSC’s jurisdiction. Many of these sites have more than 1 mechanism, as reflected
in the 600 FA mechanism management tasks shown.  FA mechanism management tasks
include tracking of annual updates to the mechanisms and logging of receipt and filing of
hardcopy FA mechanisms.
The FR unit performed 75 technical assistance tasks for DTSC project managers, the
regulated community, and financial institutions.
The FR unit reviewed 10 FA mechanisms in support of processing permit applications.
61 FA mechanisms were reviewed for Statewide Enforcement as a part of facility
compliance inspections.
30 FA mechanisms were reviewed for Cleanup Program projects.
29 FA mechanisms were released.
The FR unit also supported 15 special projects for the Permitting Division.
13
undefined
Permitting’s CEQA unit reviews permit applications and technical consultation projects to CEQA standards
RESOURCES
CEQA Unit Hours by Work Category
1,2
 (FY 2018-19)
The CEQA unit spends 25% of their hours directly on permit-related
projects. This includes analyzing impacts to associated permit decisions,
preparing notices of exemption, reviewing CEQA documents from another
lead agencies, coordinating pre-application activities, CEQA consultation
and Preliminary Environmental Assessment Reports (PEAR), and
preparing addendums to CEQA documents.
Approximately 40% of time is devoted to Technical Consultation and
Support, including Responsible Agency Comment Form Letters and CEQA
document review as responsible agency for hazardous waste issues.
As 1 of 2 central CEQA resources units for DTSC, the Permitting CEQA
unit devotes 32% of hours to general administrative activities, supervision,
and rulemaking activities.
3% is applied to support the RCRA Grant reporting and cleanup efforts.
CEQA Unit Major Outputs
3
 (FY 2018-19)
In FY 2018-19, the CEQA unit processed 1,393 requests for DTSC review of CEQA documents as
Responsibility Agency (RA) for hazardous waste issues (PRC §§ 21080.3 and 21081.6(c)).
1 Responsibility Agency Comment Letter for Permitting was prepared.
4 permitting projects, prepared by another lead agency, were reviewed.
The CEQA unit reviewed 5 rulemakings which resulted in Notice of Exemptions (NOEs).
6 Environmental Data Analyses were prepared, evaluating prior CEQA documents prepared for an activity
that is part of a permitting project.
The CEQA unit supported 11 pre-application coordination activities on permitting projects.
15 addenda were prepared to support permitting projects. Addenda are prepared to append updated
information to existing CEQA documents.
21 NOEs were prepared for permitting decisions (standardized and RCRA permit types).
34 consultations were performed as part of a Preliminary Environmental Assessment review, to support
external lead agencies beginning the CEQA process for a project that includes a permitting project.
47 NOEs were prepared to address emergency permits.
14
undefined
Process Improvement and Development
Permitting transformed the permitting process
over the last 6 years, significantly reducing the
time to make permit decisions. Permitting
undertook critical Lean 6-Sigma projects.
The Division developed dashboards, guidance
documents, checklists, trainings, and additional
materials.
Permitting Dashboard as of January 2020
15
undefined
The Permitting Division continues improving in all key performance metrics
PROCESS IMPROVEMENT
SOURCES: DTSC Permitting Dashboard
NOTES:       (1) As of June 16, 2020
                    (2) Projec
t outcomes based on current workload
16
undefined
Permitting has reduced the time to complete technical reviews by over 40 percent
PROCESS IMPROVEMENT
Situation
DTSC evaluates whether permit applications meet the
standards for hazardous waste facilities specified in
regulations. This phase includes reviews by subject
matter experts such as geologists, engineers,
scientists, toxicologists, and inspectors.
Technical review is a significant portion of the overall
permit application processing time. The average
technical review period lasted 45 months prior to
implementing improvements.
Approach
In FY 2013-2014, Permitting implemented a L6S project aimed at
reducing the technical review period in the permitting process so
that 90% of all technical reviews will be processed within 13
months.
The project identified 6 major “root causes” of delays in the
technical review process:
Permit application review checklist was underutilized
Review of revised applications took longer than initial review
60% of labor hours were spent on non-value-added activities
16% were spent on drafting a permit
10% were spent on preparing public notice documents
The L6S project suggestions included using a checklist and:
Creating permitting guidance documents and writing Notices of
Deficiency
Revising permitting guidance documents on how to review
applications
Training
Results
As a result of the L6S, Permitting created and
implemented a Technical Review Checklist. The
checklist reduced review time and established a
streamlined, standardized process. In addition,
Permitting replaced broad reviews from multiple
support staff with more focused and specific
reviews.
The technical review period reduced from 45
months to 25 months, a 44%-time reduction.
SOURCES: California Governor’s Office of Business and Economic Development
17
undefined
Permitting has reduced Notices of Deficiency per permit application by 50 percent
PROCESS IMPROVEMENT
Situation
The Permitting project manager reviews the permit
application and identifies deficiencies in the application.
These deficiencies are communicated to the facility via a
Notice of Deficiency (NOD) document.
Prior to 2015, on average, there were 6 NODs per permit
decision.
Approach
In FY 2014-2015, the Permitting Division implemented a
Lean 6-Sigma project aimed at reducing the average to 3
NODs per permit decision.
2 critical issues were identified in the NOD process:
Lack of early guidance to facilities; and
Over half of the deficiencies in the application are
“administrative” in nature and are issues of missing
information.
The L6S project resulted in the following improvements:
Provide early guidance to facilities by holding a pre-
application meeting. Communicate expectations of permit
application at this meeting and provide a copy of the
permit completion checklist (agenda and guidance
documents created);
NOD templates and guidance; and
Shortly after issuance of NOD, Permitting project
manager is to meet with the applicant to go over
comments for improved clarity; agenda and supporting
guidance documents were created.
Results
As a result of the L6S project, the average number of
NODs reduced by 50%. The average number of NODs
issued per permit decision was reduced from 6 to 3.
Reducing the number of NODs reduces technical
review time as well.
SOURCES: California Governor’s Office of Business and Economic Development
18
undefined
Permitting has reduced the time spent determining the proper CEQA documentation by over 98 percent
PROCESS IMPROVEMENT
Situation
Prior to the L6S project, the average time to decide what
type of CEQA document to move forward with was 229
days. This delay can affect Permitting goals and
performance metrics. Excessive processing time also
delays Permitting decisions and increases costs.
Studies on processing time showed the following:
Decision time varied greatly, with a maximum of 1053
days for 1 project
The median was about 127 days
10% of decisions were made within 30 calendar days
Approach
A L6S project was completed to reduce the time to complete
CEQA document determinations.
The project found 2 areas of concern: documents and
consultation.
Documents issues included ineffective change
communication and inefficient consideration of style
versus content corrections.
During consultation, important forms were not completed
and project managers were not kept updated
To improve, Permitting introduced a working meeting with a
standardized agenda to facilitate the decision about which
environmental document to use.
Results
After implementing improvements, the Permitting
Division reduced the duration to complete a CEQA
document determination from 228 calendar days to 3
calendar days (over 98% reduction), with the majority
of projects being completed in less than 4 hours.
Moderate projects had been charging around 200
hours per permit application to produce a
determination, so reduction to about 16 hours per
permit application results in a savings to the applicant
of approximately $34,000 per application.
SOURCES: California Governor’s Office of Business and Economic Development
19
undefined
Permitting is reducing the time to review environmental monitoring reports by 68 percent (in progress)
PROCESS IMPROVEMENT
Situation
Facilities submit environmental monitoring reports
to comply with their permits.
Information in the monitoring reports is evaluated to
identify issues and releases, and to confirm that the
permitted sampling and analysis plans are being
followed.
DTSC takes 95 days (median) to review the
reports.
Approach
In FY 2019-20, the Permitting Division began a L6S
project aimed at reducing the review time to less than
30 days for 95% of reviews.
2 critical issues were identified as causing the long
review times:
Long waiting periods in the work request phase; and
Low priority for the support service groups
performing the reviews.
The L6S project has started the following
improvements:
A report summary to be submitted with the reports;
Guidance for Permitting project managers; and
Standard letter template for communicating report
deficiencies.
Results
This project is in the implementation phase.
The report summary is undergoing internal
testing, to be followed by a beta test with select
facilities.
Full implementation is expected by July 2020.
SOURCES: California Governor’s Office of Business and Economic Development
20
undefined
Permitting has increased the number of permit decisions processed within 2.5 years
PROCESS IMPROVEMENT
Permit Decision Completions1 Processed in 0-2.5 years
SOURCES: DTSC Permitting EnviroStor
NOTES:      (1) Permit decision completions shown include renewals. Class 3 and Class 2 modifications, and new permits
Key Observations
The division set an aggressive goal of completing
90% of permit applications within 2 years for
renewals and new permits. Permitting has
already reduced the average time it takes to
make a permit decision from 4.5 years to 2.6
years. The division continues to work towards the
2-year mark while performing more
comprehensive permit application reviews and
providing increased opportunities for public input.
In addition, Permitting improved public
accessibility to project documents, reduced the
time for CEQA document decisions, implemented
intradepartmental efficiencies, and reduced the
processing time for tank assessment engineering
reviews. These improvements contribute to the
success of Permitting’s goal of 2-year permit
decisions for 90% of permit applications.
The percentage of permit decision completions
done within 2.5 years increased by 26% since FY
2014-15.
65% of permit decisions were made within 2.5
years in FY 2018-19. Of the 6 completed in over
2.5 years, 4 were completed in 2.7 years.
With the addition of new staff and implementation
of L6S recommendations, Permitting process
times fluctuated, due to incorporating new
documents, checklists, and additional process
improvements. Beginning FY 2017-18, Permitting
processes were more stable and show
demonstrable improvement.
21
undefined
22
Permit decisions for New and Renewal Permits and Class 3 Modifications grew by 550 percent in 5 years
PROCESS IMPROVEMENT
Permit Decisions for New and Renewal Permits and Class 3 Modifications (FY 13/14 – FY 18/19)
SOURCES: DTSC Permitting EnviroStor
Key Observations
The number of FY 2018-19 permit decisions is
550% higher than in FY 2013-14, reflecting the
success of process improvements coupled with
additional staff added through BCPs.
Permit decisions reflect more comprehensive
reviews of facility operations and design plans
and embody more enforceable and protective
permit provisions.
Permit renewal decisions are those made for
existing permitted facilities whose permits are
due to expire and who must reapply.
Of the 4 classifications of permit modifications,
Class 3 is for major structural or operational
changes.
Over the past 3 years, Permitting shows a steady
improvement in number of permit decisions per
year.
Permitting continues to identify new opportunities
to improve.
23
SB 673 is helping Permitting provide transparency and protect environmental justice communities
RISK
Background
DTSC is mandated by statute to develop and implement regulations for
new permitting criteria.
In FY 2014-15, DTSC conducted a series of stakeholder engagements to
address concerns. Stakeholder interviews identified the following:
The need to create clear and objective criteria for making permit
decisions based on valid standards of performance and risk
A clear standard for violations that would lead to denial or revocation
The need to document and provide a “scorecard” of facility attributes to
consider in permitting decisions
SB 673
In 2015, the Governor signed SB 673 to strengthen protections for public
health and the environment at hazardous waste facilities. As part of SB 673, 5
new permitting criteria were added, one of which was the violations scoring
procedure. The violations scoring procedure (VSP) strengthens decision-
making around the permit decision process by:
Establishing an objective scoring process to evaluate the compliance track
record of permitted facilities. Facilities are assigned a compliance tier of
“acceptable,” “conditionally acceptable,” or “unacceptable” based on violation
scores.
Calculating and publishing VSP scores annually. Facilities assigned to the
“conditionally acceptable” or “unacceptable” compliance tiers are subject to
either additional conditions or permit denial, revocation, or suspension.
DTSC did not receive resources to implement SB 673
SOURCES: Senate Bill 673, Senate Committee on Environmental Quality, 2015,
Violations Scoring Procedure
undefined
Resources redirected to implement SB 673 have impacted other permit decisions
RISK REDUCTION
SB 673 VSP Workload Estimate
1
Implementation of VSP requires effort from Statewide Enforcement (Enforcement), Office of
Legal Counsel (Legal), and Permitting, for initial scoring and for response to facility disputes of
scores.
Enforcement’s 4 environmental scientists are responsible for scoring the violations.
Permitting will be responsible for implementing special requirements for facilities based on final
VSP scores.
Legal works with Enforcement and Permitting to provide legal advice regarding whether
requirements and conditions are met, to respond to disputes, and to help address violations
quickly to protect public health and safety.
As DTSC continues to fully implement the requirements of the VSP regulations, public
engagement support will be needed that will require additional resources in the Office of
Environmental Equity (OEE).
More demands will be placed on Permitting staff as a result of the future SB 673 Track 2
permitting criteria for cumulative impacts and community vulnerability, not reflected in the
estimate above. These regulations are being developed by Permitting staff and expected to be
promulgated in 2021 for implementation in 2022.
Resource Allocation for VSP
The permit decision pipeline gets clogged by lack of capacity in other programs and offices on which
Permitting relies. The contributions of staff in other programs are critical to the enforceability, defensibility,
and transparency of permit decisions. DTSC is unable to make timely permit decisions without sufficient
support from these shared services and support programs.
On average, Permitting spends approximately 1,295 hours over 2.6 years on a permit decision. Over those
2.6 years, reallocating 2 positions reduces outputs by nearly 3 permit decisions.
Permitting works closely with Enforcement so that that hazardous waste facility permits are clear and
enforceable. Enforcement is responsible for inspecting permitted facilities to see that they are operating
within the terms of their permits and, when necessary, for taking enforcement actions with the help of
Legal. In FY 2018-19, Enforcement spent 3,993 hours in support of Permitting. Reallocating positions from
Enforcement will diminish their ability to support Permitting.
Legal works closely with Permitting so that DTSC issues hazardous waste facility permits that meet
statutory and regulatory requirements and are enforceable. The program also represents Permitting in
administrative proceedings including permit denials, suspensions, and revocations. In addition, Legal
provides support on CEQA as part of the permit decision process. Therefore, reallocation of positions for
VSP work from Enforcement will diminish their ability to support Permitting.
24
undefined
The CEQA unit is faced with increased demands to support permit decisions and to fulfill DTSC’s role as
 lead agency for hazardous waste
RISK
New and Renewal Permit and Class 3 Mod. Permit Decisions
The CEQA unit provides a CEQA analysis for each DTSC hazardous waste
permit decision.1
From FY 2016-17 to FY 2018-19, Permitting processed a total of 33 permits at
an average rate of 11 per year. Over the 3-year period, the number of annual
decisions has increased by 2 permits per year.
Permitting’s CEQA unit is currently allocating 3 staff to supporting permitting
decisions, and its current staffing levels are sufficient to address the current
Permitting workload.
CEQA Document Review Requests
DTSC is charged with reviewing hazards and hazardous materials impacts in CEQA
documents submitted for review by other local governments and other state agencies
that seek out DTSC’s expertise. These reviews give DTSC a unique and time-
sensitive opportunity to assess proposed discretionary projects and make
recommendations to prevent or mitigate human and environmental harm.
For example, a CEQA document may state that a proposed development is next to a
hazardous waste facility. DTSC has the opportunity to review handling of the facilities’
waste and provide feedback to the lead agency to mitigate risks.
Over the last 4 years, requests have doubled due to the State Clearinghouse’s new
online submission system, an increase in the number of land development projects,
and increased understanding of DTSC’s role in protecting the environment.
25
undefined
Increasing levels of CEQA document review requests diminish review periods
RISK
Average Review Time/CEQA Document Review (Hrs.)
DTSC has been identified by either the lead agency or by the Governor’s Office of
Planning and Research as a responsible agency to consult on hazardous/ toxic
materials pursuant to PRC §§ 21080.3 and 21081.6(c). Increased workload
diminishes the unit’s ability to meet these mandates.
Due to the increased workload, DTSC is not able to provide even the minimal 1.5-
hour review of CEQA documents needed to provide critical input on the impacts of
hazardous waste on the community and environment. The resulting decisions may
lack needed mitigation measures. Current resources allow 30 minutes of review per
document.
Each 1.5-hour review involves CEQA unit staff and regional liaisons conducting
preliminary reviews of each CEQA document’s project description, location, and
Hazards and Hazardous Materials resource section
.
CEQA Staffing Gap
1
Permitting’s CEQA unit is currently allocating 1 staff to CEQA document reviews,
which provides only about 0.5 hours per CEQA document. To provide minimal level of
review requires 2 additional staff.
With 2 additional resources, Permitting can provide an estimated 1.5 hours of review
to each CEQA document.
26
undefined
Conclusion
The Permitting Division has undergone transformation in recent years, adopting a culture of continuous improvement, accountability, and improved transparency.
Permitting continues to improve by determining the next most significant opportunity to reduce time in its processes without sacrificing quality or public input.
The permit decision process timeframe was reduced from 4.5 years to 2.5 years, while increasing the quality of reviews. At the same time, permits are clearer,
better supporting compliance, and more enforceable, enabling DTSC to take appropriate action when needed.
The number of annual permit renewal decisions have improved from 2 in FY 2013-14 to 13 in FY 2018-19. Permitting also developed a dashboard to provide
visibility to staff, leadership, and auditors on key metrics of performance.
The Financial Responsibility unit holds and maintains of over 600 financial mechanisms for over 450 facilities/sites, totaling $2.5 billion. In FY 2018-19, this unit
received over 600 documents that required administrative and data management tasks and supports other programs such as Statewide Enforcement and the
Cleanup Program.
The CEQA unit supports permit decisions and reviews CEQA documents for sites that have potential impacts associated with hazards and hazardous materials.
Over the last 4 years, requests by local and other state agencies for CEQA reviews have increased by 100 percent.
In 2015, Governor Brown signed Senate Bill 673 to strengthen protections for public health and the environment at hazardous waste facilities. As part of SB 673, 5
new permitting criteria were added, one of which was the violations scoring procedure (VSP). DTSC did not receive any additional resources and reallocated existing
staff to implement VSP. Coordination with other supporting programs is essential to the permit decision process, and reallocation of resources reduces DTSC’s
ability to keep making defensible, transparent, and enforceable decisions. Because staff has been reallocated to implement VSP, DTSC is faced with reducing
inspections by 28 sites and permit decisions by 3.
The workload analysis identified various areas where DTSC has gaps in resources. This presentation showcases 2 of these resource gaps:
2 additional positions would enable the Permitting Division to backfill those resources that were redirected to implement VSP. When new statutes are enacted,
Permitting needs resources to fulfill the mandates.
Due to the increased workload, DTSC is unable to meet the demand to review CEQA documents submitted by other government entities. This places
communities at risk due to lack of complete analysis of potential hazardous waste impacts, and it diminishes the CEQA unit’s ability to fulfill its mandates. 2
additional positions would address this resource gap.
In addition, new mandates will be placed on Permitting as a result of the future SB 673 permitting criteria for cumulative impacts.  This workload analysis did not
include any potential resources necessary to implement permitting criteria for cumulative impacts.
27
Contact Information
Rizgar Ghazi, P.E.
Deputy Director
Hazardous Waste Management Program
Department of Toxic Substances Control
1001 I Street
Sacramento, CA 95814
Email:  Rizgar.Ghazi@dtsc.ca.gov
Jane R. Numazu
Hazardous Substances Engineer
Office of Performance Management and Program Review
Department of Toxic Substances Control
1001 I Street
Sacramento, CA 95814
Email: Jane.Numazu@dtsc.ca.gov
28
Slide Note
Embed
Share

This workload analysis examines how the Permitting Division manages resources to meet legislative mandates, track projects, produce outcomes, and mitigate risks in the Hazardous Waste Management Program.

  • Hazardous waste
  • Permitting division
  • Workload analysis
  • Program management
  • Environmental protection

Uploaded on Feb 18, 2025 | 0 Views


Download Presentation

Please find below an Image/Link to download the presentation.

The content on the website is provided AS IS for your information and personal use only. It may not be sold, licensed, or shared on other websites without obtaining consent from the author.If you encounter any issues during the download, it is possible that the publisher has removed the file from their server.

You are allowed to download the files provided on this website for personal or commercial use, subject to the condition that they are used lawfully. All files are the property of their respective owners.

The content on the website is provided AS IS for your information and personal use only. It may not be sold, licensed, or shared on other websites without obtaining consent from the author.

E N D

Presentation Transcript


  1. 1 Hazardous Waste Management Program Permitting Division Workload Analysis for FY 2018-19 October 26, 2020 Prepared by:

  2. 2 Slide Intentionally Left Blank SLIDE INTENTIONALLY LEFT BLANK

  3. 3 Purpose This workload analysis provides information on how the Permitting Division: Uses its current resources to meet legislative mandates and achieve its mission. Tracks and manages projects to promote efficiency and effectiveness. Produces outcomes to meet its mission. Identifies risks to program performance and effectiveness.

  4. 4 Mission Statements DTSC s mission is to protect California s people, communities, and environment from toxic substances, to enhance economic vitality by restoring contaminated land, and to compel manufacturers to make safer consumer products. California Department of Toxic Substances Control Mission Statement The Permitting Division s mission is to protect Californians and the environment from toxic harm by making timely, enforceable, and protective permit decisions for the operation of hazardous waste facilities in accordance with all applicable laws and sound science. Hazardous Waste Management Program Permitting Division Mission Statement

  5. 5 To protect Californians, the Permitting Division oversees hazardous waste facilities design and operation (Page 1 of 2) BACKGROUND The Permitting Division (Permitting) in DTSC s Hazardous Waste Management Program (HWMP) makes permitting decisions and oversees operating, closure, and post-closure activities at 103 facilities that treat, store, and dispose of hazardous waste within California. Appropriate decisions and effective permits protect California s residents from hazardous wastes that pose a threat to public health and the environment. Permitting is also tasked with overseeing the adequacy of financial assurance for sites under DTSC s jurisdiction to protect California s residents from toxic harm, and to avoid burdening the California taxpayers with the cost for such efforts. Permitting evaluates every decision regarding the operation of a hazardous waste facility in accordance with the California Environmental Quality Act (CEQA) and performs CEQA analysis to support decisions of other DTSC programs. Permitting also coordinates requests from California government entities to review CEQA documents for hazardous waste impacts related to their projects. Senate Bill (SB) 673 (Lara, Chapter 611, Statutes of 2015) requires DTSC to establish and implement new permitting criteria to improve enforceability, transparency, and equity in permit decisions. Permitting staff led the regulation development and is now implementing 5 new permitting criteria, with support from DTSC s Statewide Enforcement and Legal staff. Permitting is now leading the development of additional SB 673 regulations to establish criteria for consideration of cumulative impacts and community vulnerability in permitting decisions. These SB 673 Track 2 regulations are expected to be promulgated in 2021 for implementation in 2022. Since SB 839 (Committee on Budget and Fiscal Review, Chapter 340, Statutes of 2016) was signed into law, all permit applications received after April 1, 2016 are subject to Fee-for-Service (FFS). DTSC now recovers the cost of reviewing permit applications and making permit decisions. The Permitting Division has undergone transformation in recent years, adopting a culture of continuous improvement, accountability, and improved transparency. Since 2014, DTSC has implemented several process improvements, including permitting enhancements and Lean 6-Sigma (L6S) efforts. L6S projects have reduced the time required to make permit decisions while increasing the quality of application review and permit decisions. The increased efficiency frees Permitting staff to perform more comprehensive and consistent reviews of ongoing permitted activities. Permitting continues to improve by determining the next most significant opportunity to reduce time in its processes without sacrificing quality or public input.

  6. 6 To protect Californians, the Permitting Division oversees hazardous waste facilities design and operation (Page 2 of 2) BACKGROUND In 2018-19, Permitting operated with a budget of approximately $13 million and 67.5 positions (63.5 positions were analyzed, as unfunded and executive positions were excluded). Permitting is funded by the Hazardous Waste Control Account (HWCA), Fee-for-Service revenues deposited in HWCA, U.S. EPA Resource Conservation and Recovery Act (RCRA) Grant resources deposited in the Federal Trust Fund, and General Fund. In FY 2018-19 Permitting: Issued 18 permit decisions for renewals, Class 2, and Class 3 permit modifications, many of which are in environmental justice communities. These are communities that are most vulnerable and impacted by multiple sources of pollution. Performed permit maintenance activities, including review of groundwater monitoring reports, air monitoring studies, and closure cost estimates. Reviewed plans, oversaw field activities, and reviewed reports related to closure of 12 facilities. Performed and implemented 4 process improvement initiatives to make the permitting process more efficient, protective, and transparent. Permitting receives its authority from these 3 codes: Code Code Sections Div. 20 Ch. 6.5 25100-25135.9, 25146-25149.7, 25150.82-25150.86, 25152.5- 25155.10, 25159.10-25159.25, 25169.5-25169.8, 25178, 25179.1-25179.12, 25205, 25205.1-25205.23, 25206.1-25206.4, 25208-25208.17, 25209-25209.7, 25220-25227, 25245-25249, 25250-25250.30 Health and Safety (HSC) Public Resources (PRC) Div. 13 21000-21177 Div. 3 Ch. 7 6700-6799 Business and Professions

  7. 7 Overview of HWMP s Permitting Division RESOURCES Permitting Division (FY 2018-19) Key Observations DTSC is mandated by statute to: Issue permit decisions for hazardous waste management facilities in California (HSC 25200(a)). Oversee closure of hazardous waste management facilities (HSC 25247). Establish regulations and standards to establish sufficient financial assurance for cleanup and closure at permitted facilities (HSC 25245(a)). Evaluate environmental impacts of discretionary projects in compliance with CEQA (PRC 21000(g)). Adopt permitting criteria to consider facility compliance history among other criteria (HSC 25200.21). Recently, SB 673 required DTSC to evaluate and quantify a facility s compliance history, cumulative impacts, and community vulnerability during a permit decision. Develop and implement programmatic reforms to improve protectiveness, timeliness, legal defensibility, and enforceability of the permitting program (HSC 25200.23). DTSC is authorized to perform 5-year reviews of the estimated costs to implement closure and post-closure activities at permitted facilities. Permitting offices are in Sacramento, Berkeley, and Chatsworth. 6 units within Permitting include dedicated technical project managers and associated support staff. Scientist, Engineer, and Environmental Planner classifications comprise over 81% of the division. SOURCES: DTSC HR NOTES: (1) The number of positions used as the basis for the workload analysis may not align with the 2019-20 Salary and Wages Supplement. Unfunded and other specific positions were not included. Permitting s Financial Responsibility (FR) unit assures that sufficient funds are set aside and available for future closure, post-closure, operations and maintenance, corrective action, and/or liability. The CEQA unit analyzes and mitigates environmental impacts associated with project decisions. (2) Management office includes management and direct reports.

  8. 8 Technical classifications are fundamental to Permitting s success RESOURCES Permitting Division Staff Hours1,2 by Classification (FY 2018-19) Key Observations Permitting is primarily staffed with scientists and engineers, whose expertise is necessary to interpret and implement hazardous waste management regulations for permitted facilities. Activities require knowledge of hazardous waste management laws, CEQA, financial assurance, and contaminants as they relate to applications, closures, and technical consultation requests. 81% of hours are completed by the scientist, planner, and engineer classifications. 4% of hours are dedicated to supervisory positions. The Permitting project managers review the design and operation of permitted facilities to identify deficiencies and deviations from the comprehensive permitting standards and requirements. Permitting s analysts and office technicians complete crucial administrative work for the program. This includes supporting permit decisions, inputting and monitoring data management systems, and processing and tracking contracts. SOURCES: DTSC TEMPO Time Data NOTES: (1) TEMPO showed a senior engineering geologist under Permitting s reporting structure in error and has since been corrected. These hours are not included in the chart and totaled 525 hours (including leave). The following slides include these hours. (2) Leave is not included in this chart. Leave, including state and federal holidays, amounts to 19,460 hours.

  9. 9 65 percent of division time goes to technical work on permitting projects, CEQA, financial responsibility, consultation and outreach, corrective action and cleanup support, and SB 673 RESOURCES Key Observations Permitting Division Hours1 by Work Category (FY 2018-19) Permitting completes permitting projects, CEQA evaluations, financial responsibility reviews, administrative activities, consultation and outreach, and program development. Approximately 50% of hours support facility permitting activities. This is work from Permitting, CEQA, and FR unit staff dedicated to permit activities, including Permitting unit supervision hours for technical work in permit reviews. DTSC coordination is 15% of hours. Consultation and outreach includes records requests, rulemaking review and development, and data management tasks. 19% of hours are devoted to administrative activities and is time required to maintain operations. Specific tasks include statutorily mandated reforms and L6S projects. SB 673 hours represent the 5 new permitting criteria which updated financial assurance rules, employee training requirements, compliance history evaluation, community involvement profiles, and health risk assessments. SB 673 Track 2 will require review of cumulative impacts to be considered in a permit decision which will place additional demands on Permitting staff. SOURCES: DTSC TEMPO Time Data NOTES: (1) Leave is not shown in this chart. Leave, including state and federal holidays, amounts to 19,460 hours and 16% of hours. Percentages in the chart take leave into account.

  10. 10 70 percent of Permitting staff hours are for permitting projects and program development RESOURCES Key Observations Permitting Units Hours1,2 by Work Category (FY 2018-19) The bulk of hours include reviewing applications and operations for compliance with permitting standards and requirements and managing Fee- for-Service (FFS). FFS work includes work on permit applications received after April 1, 2016. DTSC FFS documentation and procedures are required to comply with HSC 25206.1-25206.4 when seeking cost reimbursement for processing applications. 18% of hours were for administrative activities including statutorily mandated training, health and safety compliance, hiring, budget management, database management, strategic planning, staff meetings, and other tasks. 5% of hours represent consultation and outreach, including maintenance of the EnviroStor data management system, developing and delivering training, and consultative work with the HWMP and the public on hazardous waste permitting issues. SB 673 represents 3% of Permitting units hours. After Statewide Enforcement determines violations scoring tiers, Permitting is mandated to implement special facility requirements based on tiers. As SB 673 workload shifts onto Permitting, associated hours are expected to significantly increase. 2% of hours involved corrective action activities and supporting Site Mitigation and Restoration Program (Cleanup) to mitigate risk at a post- closure or closure site per HSC 25247. NOTES: (1) Activity IDs and Project IDs were grouped into larger work categories in collaboration with program staff. (2) Leave is not included in the chart above. Percentages do not include leave.

  11. 11 Permitting completed 18 permit decisions in FY 2018-19 RESOURCES Permit Completions by Timeframe1 (FY 2018-19) The permit application process spans multiple years and involves multiple programs. The 5-phase process consists of: Pre-Application Period: DTSC meets with facilities as part of a pre-application meeting and establishes clear expectations for the permitting process. Administrative Review: DTSC uses an Administrative Review Checklist to determine whether each required item is provided in the application, not provided, or not applicable. Technical Review: DTSC uses a Technical Review Checklist to evaluate whether the permit application meets all of the standards for hazardous waste facilities specified in regulation. Public Comment Period: DTSC provides public notice of a draft decision; reviews and considers each comment received during the public comment period; and prepares responses to comments. Permit Decision: DTSC issues a final permit decision, considering all public comments received. On average, permit decisions spanned 2.6 years and required 1,295 staff hours. Prior to process improvements, permit renewal decisions spanned 4.5 years on average. 5 Class 2 modifications were completed during this period. On average, Class 2 modifications spanned 1 year and required 1,136 staff hours. 2 modifications were completed for Phibro-Tech Inc. 3 Class 3 modifications were completed during this period. On average, Class 3 modifications spanned 1.5 years and required 710 staff hours. Permitting completed a total of 10 renewals. The average renewal spanned approximately 2.6 years and required 1,567 staff hours. 1 renewal for a particularly large-scale and complex permit, spanned 5 years and began prior to Lean 6-Sigma initiatives. Hours varied depending on the complexity and specific requirements of each project. NOTES: (1) Project Hours only represent Permitting s work and does not include work completed by other DTSC programs during the application process.

  12. 12 Permitting administers permit modifications, oversees closures, performs special projects, and reviews closure cost estimates that are not covered by Fee-for-Service RESOURCES Key Observations Major Permitting Unit Tasks Not Covered by FFS (FY 2018-19) Work not reimbursed by DTSC s FFS revenues includes activities for oversight of facility closures, review and evaluation of reports prepared by permitted facilities to demonstrate ongoing protective operations, and support to Statewide Enforcement. Permitting performed a total of 328 of these major activities in FY 2018-19. Permitting performed 182 permit maintenance tasks. These include review of deliverables submitted to fulfill permit conditions as part of permit maintenance. Permitting completed 38 Class 1 and 9 Class 1* ( class one star ) permit modifications, allowing facilities to make minor modifications to their operations. Class 1 and Class 1* modifications are the simplest of modifications and are not subject to FFS. 40 emergency permits were issued. Facilities request emergency permits to manage waste posing an immediate endangerment to human health or the environment. 12 closures were ongoing during FY 2018-19, with 8 closures completed. Closure oversight is essential so that contamination issues are resolved. 15 5-year financial assurance closure cost reviews were completed to confirm that financial assurance mechanisms were adequate to cover the cost of future cleanup. Permitting personnel completed 18 special projects and have 14 more ongoing, including projects to implement statutorily mandated reforms, evaluate complex industries such as metal shredders, and to develop new regulations to improve protections in vulnerable communities.

  13. 13 Permitting s Financial Responsibility unit monitors funding adequacy for facility closure and cleanup activities RESOURCES Financial Responsibility Unit Hours1,2 by Work Category (FY 2018-19) Financial Responsibility Unit Major Outputs (FY 2018-19) The FR unit reviews and monitors $2.5 billion FA mechanisms for approximately 450 sites under DTSC s jurisdiction. Many of these sites have more than 1 mechanism, as reflected in the 600 FA mechanism management tasks shown. FA mechanism management tasks include tracking of annual updates to the mechanisms and logging of receipt and filing of hardcopy FA mechanisms. The FR unit performed 75 technical assistance tasks for DTSC project managers, the regulated community, and financial institutions. The FR unit reviewed 10 FA mechanisms in support of processing permit applications. 61 FA mechanisms were reviewed for Statewide Enforcement as a part of facility compliance inspections. 30 FA mechanisms were reviewed for Cleanup Program projects. 29 FA mechanisms were released. The FR unit also supported 15 special projects for the Permitting Division. The Financial Responsibility (FR) unit reviews and assesses the adequacy of financial assurance mechanisms for Permitting, Statewide Enforcement, and Cleanup. Financial assurance is essential to oversee that adequate resources are available to perform closure and cleanup in a timely manner to protect California s residents from toxic harm. 41% of the FR unit s hours were devoted to core functions of supporting permit decisions, implementing new SB 673 financial assurance (FA) requirements, evaluating financial responsibility, and providing support to Statewide Enforcement and the Cleanup Program. Note that supervisory time in the FR unit includes time spent on technical review of financial analyses performed by staff. 30% of time is spent on administrative functions including time spent logging and filing financial mechanisms for approximately 450 sites. The FR unit receives over 600 documents per year that require administrative and data management tasks. In addition, the supervisor and financial analysts receive general inquiries from facilities which cannot be charged directly to a site. NOTES: (1) Activity IDs were grouped into larger work categories in collaboration with program staff. (2) Leave is not included in the hours above. Percentages do not include leave.

  14. 14 Permitting s CEQA unit reviews permit applications and technical consultation projects to CEQA standards RESOURCES CEQA Unit Major Outputs3 (FY 2018-19) CEQA Unit Hours by Work Category1,2 (FY 2018-19) The CEQA unit spends 25% of their hours directly on permit-related projects. This includes analyzing impacts to associated permit decisions, preparing notices of exemption, reviewing CEQA documents from another lead agencies, coordinating pre-application activities, CEQA consultation and Preliminary Environmental Assessment Reports (PEAR), and preparing addendums to CEQA documents. In FY 2018-19, the CEQA unit processed 1,393 requests for DTSC review of CEQA documents as Responsibility Agency (RA) for hazardous waste issues (PRC 21080.3 and 21081.6(c)). 1 Responsibility Agency Comment Letter for Permitting was prepared. 4 permitting projects, prepared by another lead agency, were reviewed. The CEQA unit reviewed 5 rulemakings which resulted in Notice of Exemptions (NOEs). 6 Environmental Data Analyses were prepared, evaluating prior CEQA documents prepared for an activity that is part of a permitting project. The CEQA unit supported 11 pre-application coordination activities on permitting projects. 15 addenda were prepared to support permitting projects. Addenda are prepared to append updated information to existing CEQA documents. 21 NOEs were prepared for permitting decisions (standardized and RCRA permit types). 34 consultations were performed as part of a Preliminary Environmental Assessment review, to support external lead agencies beginning the CEQA process for a project that includes a permitting project. 47 NOEs were prepared to address emergency permits. Approximately 40% of time is devoted to Technical Consultation and Support, including Responsible Agency Comment Form Letters and CEQA document review as responsible agency for hazardous waste issues. As 1 of 2 central CEQA resources units for DTSC, the Permitting CEQA unit devotes 32% of hours to general administrative activities, supervision, and rulemaking activities. 3% is applied to support the RCRA Grant reporting and cleanup efforts. NOTES: (1) Project IDs and Activity IDs were grouped into larger work categories in collaboration with program staff. (2) Leave is not included in the hours above. (3) No Initial Studies, Negative Declarations, Mitigated Negative Declarations, Environmental Impact Reports, Subsequent CEQA Documents, Supplemental Environmental Impact Reports were prepared by Permitting CEQA in FY 2018-19.

  15. 15 Process Improvement and Development Permitting transformed the permitting process over the last 6 years, significantly reducing the time to make permit decisions. Permitting undertook critical Lean 6-Sigma projects. The Division developed dashboards, guidance documents, checklists, trainings, and additional materials. Permitting Dashboard as of January 2020

  16. 16 The Permitting Division continues improving in all key performance metrics PROCESS IMPROVEMENT SOURCES: DTSC Permitting Dashboard NOTES: (1) As of June 16, 2020 (2) Project outcomes based on current workload

  17. 17 Permitting has reduced the time to complete technical reviews by over 40 percent PROCESS IMPROVEMENT Situation Approach Results In FY 2013-2014, Permitting implemented a L6S project aimed at reducing the technical review period in the permitting process so that 90% of all technical reviews will be processed within 13 months. The project identified 6 major root causes of delays in the technical review process: DTSC evaluates whether permit applications meet the standards for hazardous waste facilities specified in regulations. This phase includes reviews by subject matter experts such as geologists, engineers, scientists, toxicologists, and inspectors. As a result of the L6S, Permitting created and implemented a Technical Review Checklist. The checklist reduced review time and established a streamlined, standardized process. In addition, Permitting replaced broad reviews from multiple support staff with more focused and specific reviews. Technical review is a significant portion of the overall permit application processing time. The average technical review period lasted 45 months prior to implementing improvements. Permit application review checklist was underutilized Review of revised applications took longer than initial review The technical review period reduced from 45 months to 25 months, a 44%-time reduction. 60% of labor hours were spent on non-value-added activities 16% were spent on drafting a permit 10% were spent on preparing public notice documents The L6S project suggestions included using a checklist and: Creating permitting guidance documents and writing Notices of Deficiency Revising permitting guidance documents on how to review applications Training SOURCES: California Governor s Office of Business and Economic Development

  18. 18 Permitting has reduced Notices of Deficiency per permit application by 50 percent PROCESS IMPROVEMENT Approach Results Situation The Permitting project manager reviews the permit application and identifies deficiencies in the application. These deficiencies are communicated to the facility via a Notice of Deficiency (NOD) document. Prior to 2015, on average, there were 6 NODs per permit decision. In FY 2014-2015, the Permitting Division implemented a Lean 6-Sigma project aimed at reducing the average to 3 NODs per permit decision. 2 critical issues were identified in the NOD process: As a result of the L6S project, the average number of NODs reduced by 50%. The average number of NODs issued per permit decision was reduced from 6 to 3. Reducing the number of NODs reduces technical review time as well. Lack of early guidance to facilities; and Over half of the deficiencies in the application are administrative in nature and are issues of missing information. The L6S project resulted in the following improvements: Provide early guidance to facilities by holding a pre- application meeting. Communicate expectations of permit application at this meeting and provide a copy of the permit completion checklist (agenda and guidance documents created); NOD templates and guidance; and Shortly after issuance of NOD, Permitting project manager is to meet with the applicant to go over comments for improved clarity; agenda and supporting guidance documents were created. SOURCES: California Governor s Office of Business and Economic Development

  19. 19 Permitting has reduced the time spent determining the proper CEQA documentation by over 98 percent PROCESS IMPROVEMENT Situation Approach Results A L6S project was completed to reduce the time to complete CEQA document determinations. After implementing improvements, the Permitting Division reduced the duration to complete a CEQA document determination from 228 calendar days to 3 calendar days (over 98% reduction), with the majority of projects being completed in less than 4 hours. Prior to the L6S project, the average time to decide what type of CEQA document to move forward with was 229 days. This delay can affect Permitting goals and performance metrics. Excessive processing time also delays Permitting decisions and increases costs. The project found 2 areas of concern: documents and consultation. Documents issues included ineffective change communication and inefficient consideration of style versus content corrections. Moderate projects had been charging around 200 hours per permit application to produce a determination, so reduction to about 16 hours per permit application results in a savings to the applicant of approximately $34,000 per application. Studies on processing time showed the following: Decision time varied greatly, with a maximum of 1053 days for 1 project During consultation, important forms were not completed and project managers were not kept updated The median was about 127 days To improve, Permitting introduced a working meeting with a standardized agenda to facilitate the decision about which environmental document to use. 10% of decisions were made within 30 calendar days SOURCES: California Governor s Office of Business and Economic Development

  20. 20 Permitting is reducing the time to review environmental monitoring reports by 68 percent (in progress) PROCESS IMPROVEMENT Situation Approach Results In FY 2019-20, the Permitting Division began a L6S project aimed at reducing the review time to less than 30 days for 95% of reviews. 2 critical issues were identified as causing the long review times: Facilities submit environmental monitoring reports to comply with their permits. This project is in the implementation phase. The report summary is undergoing internal testing, to be followed by a beta test with select facilities. Information in the monitoring reports is evaluated to identify issues and releases, and to confirm that the permitted sampling and analysis plans are being followed. Long waiting periods in the work request phase; and Full implementation is expected by July 2020. Low priority for the support service groups performing the reviews. The L6S project has started the following improvements: DTSC takes 95 days (median) to review the reports. A report summary to be submitted with the reports; Guidance for Permitting project managers; and Standard letter template for communicating report deficiencies. SOURCES: California Governor s Office of Business and Economic Development

  21. 21 Permitting has increased the number of permit decisions processed within 2.5 years PROCESS IMPROVEMENT Key Observations Permit Decision Completions1 Processed in 0-2.5 years The division set an aggressive goal of completing 90% of permit applications within 2 years for renewals and new permits. Permitting has already reduced the average time it takes to make a permit decision from 4.5 years to 2.6 years. The division continues to work towards the 2-year mark while performing more comprehensive permit application reviews and providing increased opportunities for public input. In addition, Permitting improved public accessibility to project documents, reduced the time for CEQA document decisions, implemented intradepartmental efficiencies, and reduced the processing time for tank assessment engineering reviews. These improvements contribute to the success of Permitting s goal of 2-year permit decisions for 90% of permit applications. The percentage of permit decision completions done within 2.5 years increased by 26% since FY 2014-15. 65% of permit decisions were made within 2.5 years in FY 2018-19. Of the 6 completed in over 2.5 years, 4 were completed in 2.7 years. With the addition of new staff and implementation of L6S recommendations, Permitting process times fluctuated, due to incorporating new documents, checklists, and additional process improvements. Beginning FY 2017-18, Permitting processes were more stable and show demonstrable improvement. SOURCES: DTSC Permitting EnviroStor NOTES: (1) Permit decision completions shown include renewals. Class 3 and Class 2 modifications, and new permits

  22. 22 Permit decisions for New and Renewal Permits and Class 3 Modifications grew by 550 percent in 5 years PROCESS IMPROVEMENT Key Observations Permit Decisions for New and Renewal Permits and Class 3 Modifications (FY 13/14 FY 18/19) The number of FY 2018-19 permit decisions is 550% higher than in FY 2013-14, reflecting the success of process improvements coupled with additional staff added through BCPs. Permit decisions reflect more comprehensive reviews of facility operations and design plans and embody more enforceable and protective permit provisions. Permit renewal decisions are those made for existing permitted facilities whose permits are due to expire and who must reapply. Of the 4 classifications of permit modifications, Class 3 is for major structural or operational changes. Over the past 3 years, Permitting shows a steady improvement in number of permit decisions per year. Permitting continues to identify new opportunities to improve. SOURCES: DTSC Permitting EnviroStor

  23. 23 SB 673 is helping Permitting provide transparency and protect environmental justice communities RISK SB 673 Background In 2015, the Governor signed SB 673 to strengthen protections for public health and the environment at hazardous waste facilities. As part of SB 673, 5 new permitting criteria were added, one of which was the violations scoring procedure. The violations scoring procedure (VSP) strengthens decision- making around the permit decision process by: Establishing an objective scoring process to evaluate the compliance track record of permitted facilities. Facilities are assigned a compliance tier of acceptable, conditionally acceptable, or unacceptable based on violation scores. Calculating and publishing VSP scores annually. Facilities assigned to the conditionally acceptable or unacceptable compliance tiers are subject to either additional conditions or permit denial, revocation, or suspension. DTSC is mandated by statute to develop and implement regulations for new permitting criteria. In FY 2014-15, DTSC conducted a series of stakeholder engagements to address concerns. Stakeholder interviews identified the following: The need to create clear and objective criteria for making permit decisions based on valid standards of performance and risk A clear standard for violations that would lead to denial or revocation The need to document and provide a scorecard of facility attributes to consider in permitting decisions DTSC did not receive resources to implement SB 673 SOURCES: Senate Bill 673, Senate Committee on Environmental Quality, 2015, Violations Scoring Procedure

  24. 24 Resources redirected to implement SB 673 have impacted other permit decisions RISK REDUCTION SB 673 VSP Workload Estimate1 Resource Allocation for VSP The permit decision pipeline gets clogged by lack of capacity in other programs and offices on which Permitting relies. The contributions of staff in other programs are critical to the enforceability, defensibility, and transparency of permit decisions. DTSC is unable to make timely permit decisions without sufficient support from these shared services and support programs. On average, Permitting spends approximately 1,295 hours over 2.6 years on a permit decision. Over those 2.6 years, reallocating 2 positions reduces outputs by nearly 3 permit decisions. Permitting works closely with Enforcement so that that hazardous waste facility permits are clear and enforceable. Enforcement is responsible for inspecting permitted facilities to see that they are operating within the terms of their permits and, when necessary, for taking enforcement actions with the help of Legal. In FY 2018-19, Enforcement spent 3,993 hours in support of Permitting. Reallocating positions from Enforcement will diminish their ability to support Permitting. Legal works closely with Permitting so that DTSC issues hazardous waste facility permits that meet statutory and regulatory requirements and are enforceable. The program also represents Permitting in administrative proceedings including permit denials, suspensions, and revocations. In addition, Legal provides support on CEQA as part of the permit decision process. Therefore, reallocation of positions for VSP work from Enforcement will diminish their ability to support Permitting. Implementation of VSP requires effort from Statewide Enforcement (Enforcement), Office of Legal Counsel (Legal), and Permitting, for initial scoring and for response to facility disputes of scores. Enforcement s 4 environmental scientists are responsible for scoring the violations. Permitting will be responsible for implementing special requirements for facilities based on final VSP scores. Legal works with Enforcement and Permitting to provide legal advice regarding whether requirements and conditions are met, to respond to disputes, and to help address violations quickly to protect public health and safety. As DTSC continues to fully implement the requirements of the VSP regulations, public engagement support will be needed that will require additional resources in the Office of Environmental Equity (OEE). More demands will be placed on Permitting staff as a result of the future SB 673 Track 2 permitting criteria for cumulative impacts and community vulnerability, not reflected in the estimate above. These regulations are being developed by Permitting staff and expected to be promulgated in 2021 for implementation in 2022. NOTES: (1) This figure depicts Permitting s resource needs. Resources will be needed in other DTSC programs to support these activities. (2) In FY 2018-19, Statewide Enforcement s 57 inspectors completed 395 inspections, or about 7 inspections per person. If each of the 4 reallocated positions completed 7 inspections, that equates to a loss of 28 inspections. (3) In FY 2018-19, permit decisions spanned 1,295 hours and 2.5 years, on average. This equates to approximately 518 hours per year per permit. Factoring the working hours per staff by 2, dividing by 518 hours and dividing by the permit decision time frame equates to nearly 3 less permit decisions over the course of 2.5 years.

  25. 25 The CEQA unit is faced with increased demands to support permit decisions and to fulfill DTSC s role as lead agency for hazardous waste RISK CEQA Document Review Requests New and Renewal Permit and Class 3 Mod. Permit Decisions DTSC is charged with reviewing hazards and hazardous materials impacts in CEQA documents submitted for review by other local governments and other state agencies that seek out DTSC s expertise. These reviews give DTSC a unique and time- sensitive opportunity to assess proposed discretionary projects and make recommendations to prevent or mitigate human and environmental harm. For example, a CEQA document may state that a proposed development is next to a hazardous waste facility. DTSC has the opportunity to review handling of the facilities waste and provide feedback to the lead agency to mitigate risks. Over the last 4 years, requests have doubled due to the State Clearinghouse s new online submission system, an increase in the number of land development projects, and increased understanding of DTSC s role in protecting the environment. The CEQA unit provides a CEQA analysis for each DTSC hazardous waste permit decision.1 From FY 2016-17 to FY 2018-19, Permitting processed a total of 33 permits at an average rate of 11 per year. Over the 3-year period, the number of annual decisions has increased by 2 permits per year. Permitting s CEQA unit is currently allocating 3 staff to supporting permitting decisions, and its current staffing levels are sufficient to address the current Permitting workload. SOURCES: NOTES: State Clearinghouse (1) See CEQA responsibilities in the Permitting process. (2) Estimate for FY 2019-20 based on annualizing current level

  26. 26 Increasing levels of CEQA document review requests diminish review periods RISK CEQA Staffing Gap1 Average Review Time/CEQA Document Review (Hrs.) DTSC has been identified by either the lead agency or by the Governor s Office of Planning and Research as a responsible agency to consult on hazardous/ toxic materials pursuant to PRC 21080.3 and 21081.6(c). Increased workload diminishes the unit s ability to meet these mandates. Due to the increased workload, DTSC is not able to provide even the minimal 1.5- hour review of CEQA documents needed to provide critical input on the impacts of hazardous waste on the community and environment. The resulting decisions may lack needed mitigation measures. Current resources allow 30 minutes of review per document. Each 1.5-hour review involves CEQA unit staff and regional liaisons conducting preliminary reviews of each CEQA document s project description, location, and Hazards and Hazardous Materials resource section. Permitting s CEQA unit is currently allocating 1 staff to CEQA document reviews, which provides only about 0.5 hours per CEQA document. To provide minimal level of review requires 2 additional staff. With 2 additional resources, Permitting can provide an estimated 1.5 hours of review to each CEQA document. SOURCES: State Clearinghouse NOTES: (1) This figure only depicts Permitting s resource needs. Resources will be needed in other DTSC programs to support these activities.

  27. 27 Conclusion The Permitting Division has undergone transformation in recent years, adopting a culture of continuous improvement, accountability, and improved transparency. Permitting continues to improve by determining the next most significant opportunity to reduce time in its processes without sacrificing quality or public input. The permit decision process timeframe was reduced from 4.5 years to 2.5 years, while increasing the quality of reviews. At the same time, permits are clearer, better supporting compliance, and more enforceable, enabling DTSC to take appropriate action when needed. The number of annual permit renewal decisions have improved from 2 in FY 2013-14 to 13 in FY 2018-19. Permitting also developed a dashboard to provide visibility to staff, leadership, and auditors on key metrics of performance. The Financial Responsibility unit holds and maintains of over 600 financial mechanisms for over 450 facilities/sites, totaling $2.5 billion. In FY 2018-19, this unit received over 600 documents that required administrative and data management tasks and supports other programs such as Statewide Enforcement and the Cleanup Program. The CEQA unit supports permit decisions and reviews CEQA documents for sites that have potential impacts associated with hazards and hazardous materials. Over the last 4 years, requests by local and other state agencies for CEQA reviews have increased by 100 percent. In 2015, Governor Brown signed Senate Bill 673 to strengthen protections for public health and the environment at hazardous waste facilities. As part of SB 673, 5 new permitting criteria were added, one of which was the violations scoring procedure (VSP). DTSC did not receive any additional resources and reallocated existing staff to implement VSP. Coordination with other supporting programs is essential to the permit decision process, and reallocation of resources reduces DTSC s ability to keep making defensible, transparent, and enforceable decisions. Because staff has been reallocated to implement VSP, DTSC is faced with reducing inspections by 28 sites and permit decisions by 3. The workload analysis identified various areas where DTSC has gaps in resources. This presentation showcases 2 of these resource gaps: 2 additional positions would enable the Permitting Division to backfill those resources that were redirected to implement VSP. When new statutes are enacted, Permitting needs resources to fulfill the mandates. Due to the increased workload, DTSC is unable to meet the demand to review CEQA documents submitted by other government entities. This places communities at risk due to lack of complete analysis of potential hazardous waste impacts, and it diminishes the CEQA unit s ability to fulfill its mandates. 2 additional positions would address this resource gap. In addition, new mandates will be placed on Permitting as a result of the future SB 673 permitting criteria for cumulative impacts. This workload analysis did not include any potential resources necessary to implement permitting criteria for cumulative impacts.

  28. 28 Contact Information Rizgar Ghazi, P.E. Deputy Director Jane R. Numazu Hazardous Substances Engineer Office of Performance Management and Program Review Department of Toxic Substances Control 1001 I Street Sacramento, CA 95814 Email: Jane.Numazu@dtsc.ca.gov Hazardous Waste Management Program Department of Toxic Substances Control 1001 I Street Sacramento, CA 95814 Email: Rizgar.Ghazi@dtsc.ca.gov

More Related Content

giItT1WQy@!-/#giItT1WQy@!-/#giItT1WQy@!-/#giItT1WQy@!-/#
